The build diaries · 2019 · Greenway ACT

Building our Tuggeranong shop

From the empty Greenway premises to the Crawfords shop and workshop: the detailed 2019 fit-out in photographed stages.

160 photographs · From the first steps to the finished space

ContainerMitchellTuggeranong
See the fitted space ↓Start at the beginning

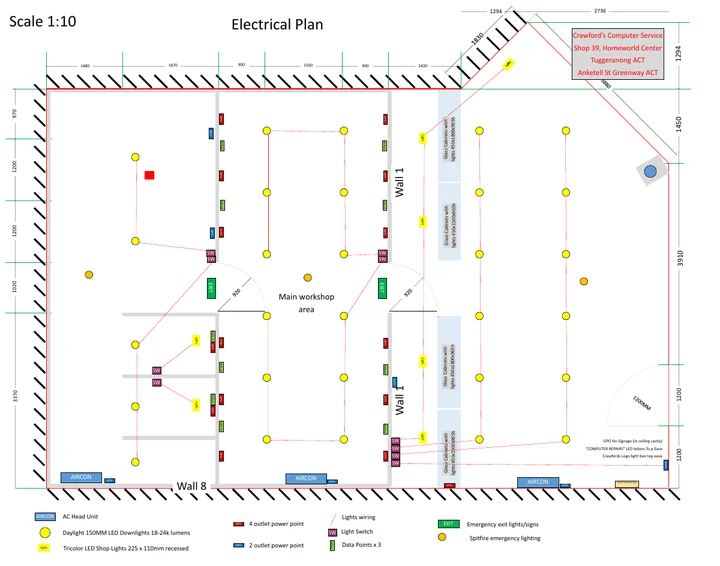

A preview of David’s 2019 electrical plan

Drawn by David in Publisher

From the plans to the photographs.

The drawings record the layout, framing, wiring, air-conditioning and drainage notes that went into the build. A later UPS plan shows how the space kept evolving.

2019 build plans ↗PDF · 8 pages · 4.7 MBThe original layout, electrical and data points, air-conditioning drainage notes, framing, elevations and signage.David’s Publisher working file ↗Publisher · includes later 2022 updates · 17.4 MBThe editable working document, including later UPS changes; it differs from the original 2019 PDF.2022 UPS wiring plan ↗PDF · 1 page · 159 KBA later plan for supplying selected lighting and power points from the UPS.
Jump to a stage 17 stages
Empty premises, June and JulyPreparing the premisesCeiling grid and wall framingServices and initial insulationInsulation and Opening Soon frontagePlasterboard liningPaintingScreen mounts and network cabinetCabinets, windows and worktopsCeilings and lightingFloorsRetail display wallsGlass displays and service countersDoors and final retail fittingsEquipping the workshopStocking the shopFinal stations, storage and frontage

Follow the photographs in date order, or choose a stage. Select a photo to enlarge it and move through the sequence.

01Empty premises, June and July

The empty premises, with the roof structure exposed and the blue shopfront frame in place.
00127 Jun 2019

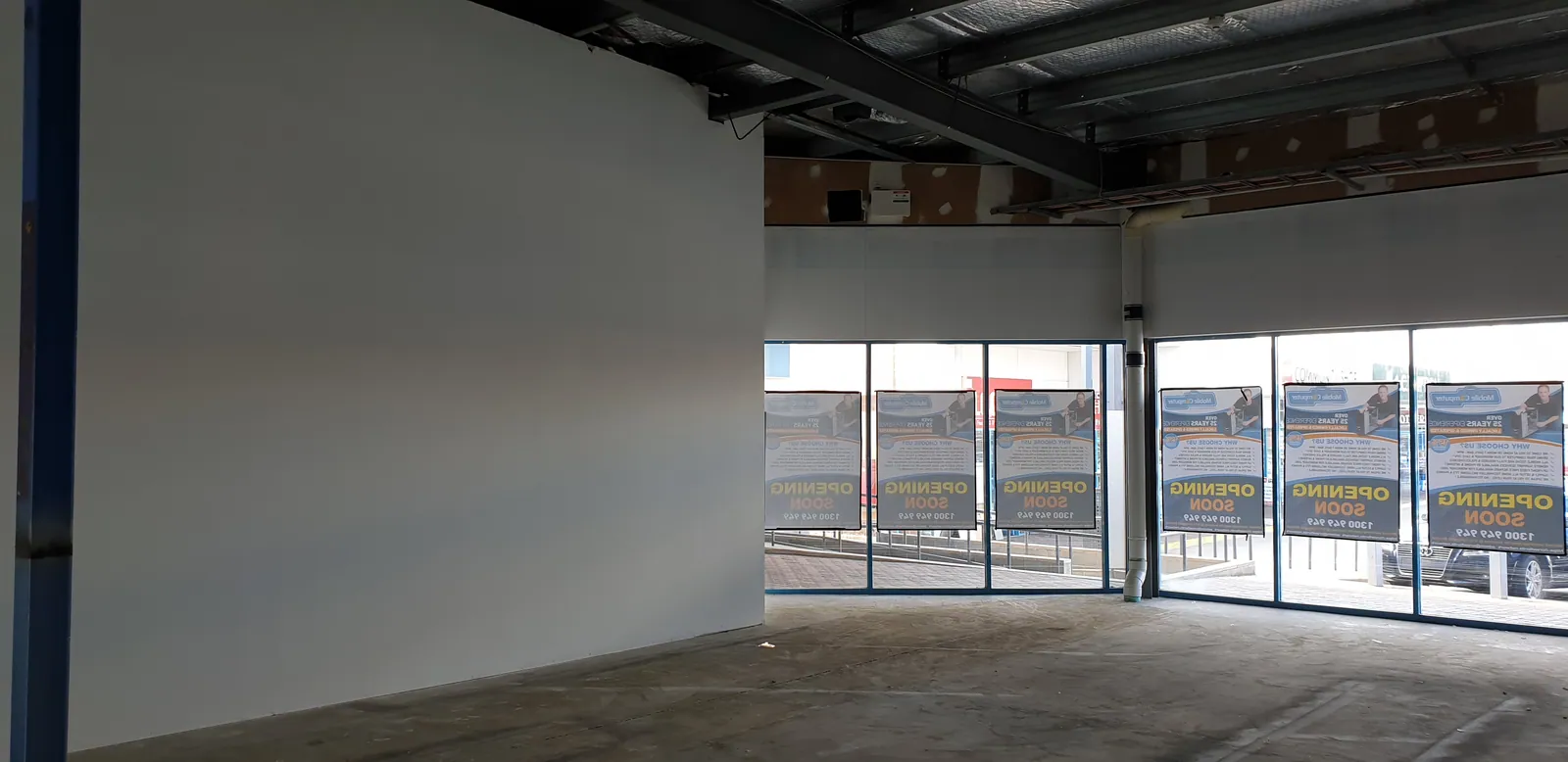

The empty premises, with the roof structure exposed and the blue shopfront frame in place.

Looking towards the front windows before the fit-out.
00227 Jun 2019

Looking towards the front windows before the fit-out.

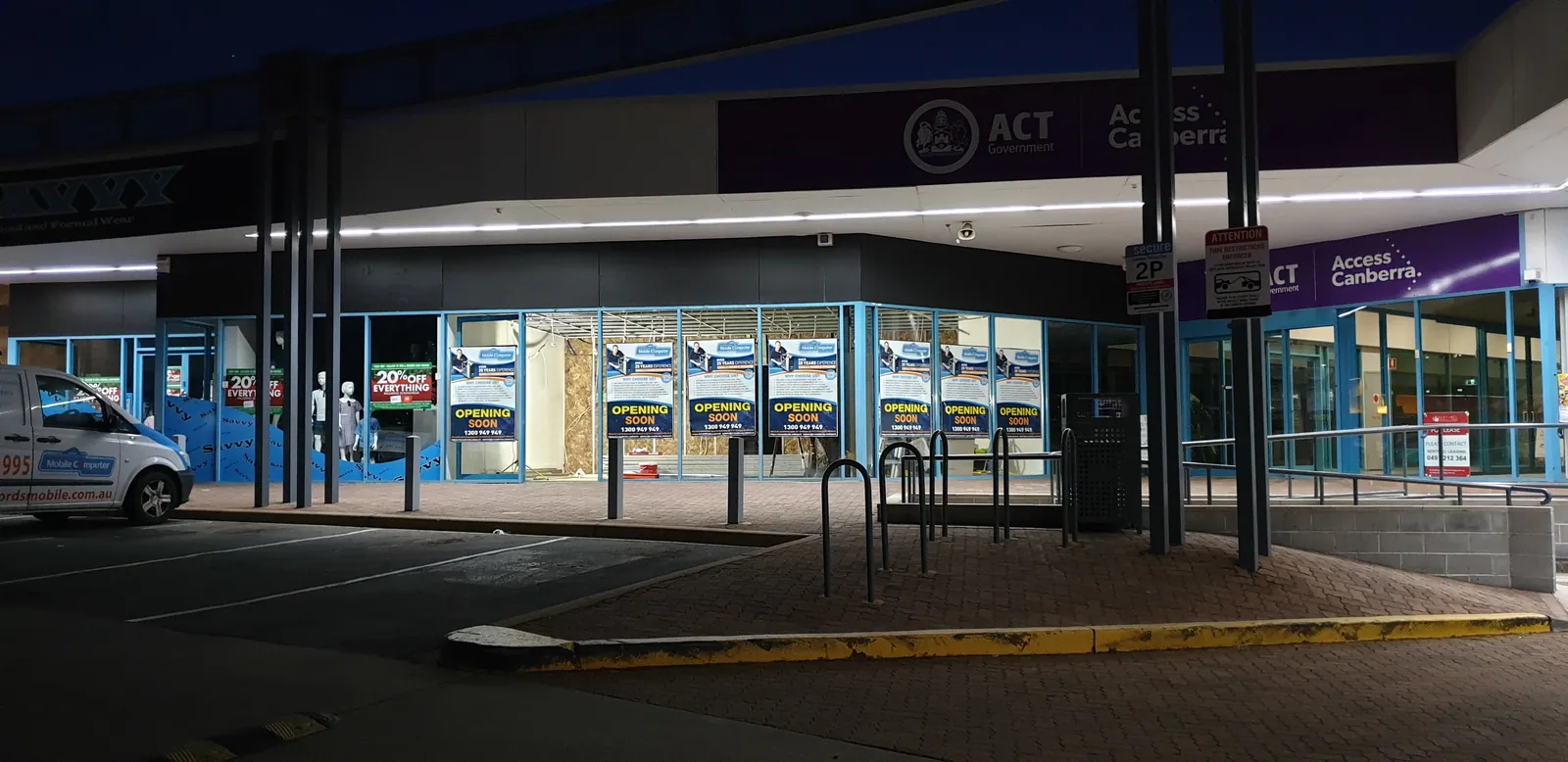

The surrounding Homeworld precinct before the new shop was fitted out.
00327 Jun 2019

The surrounding Homeworld precinct before the new shop was fitted out.

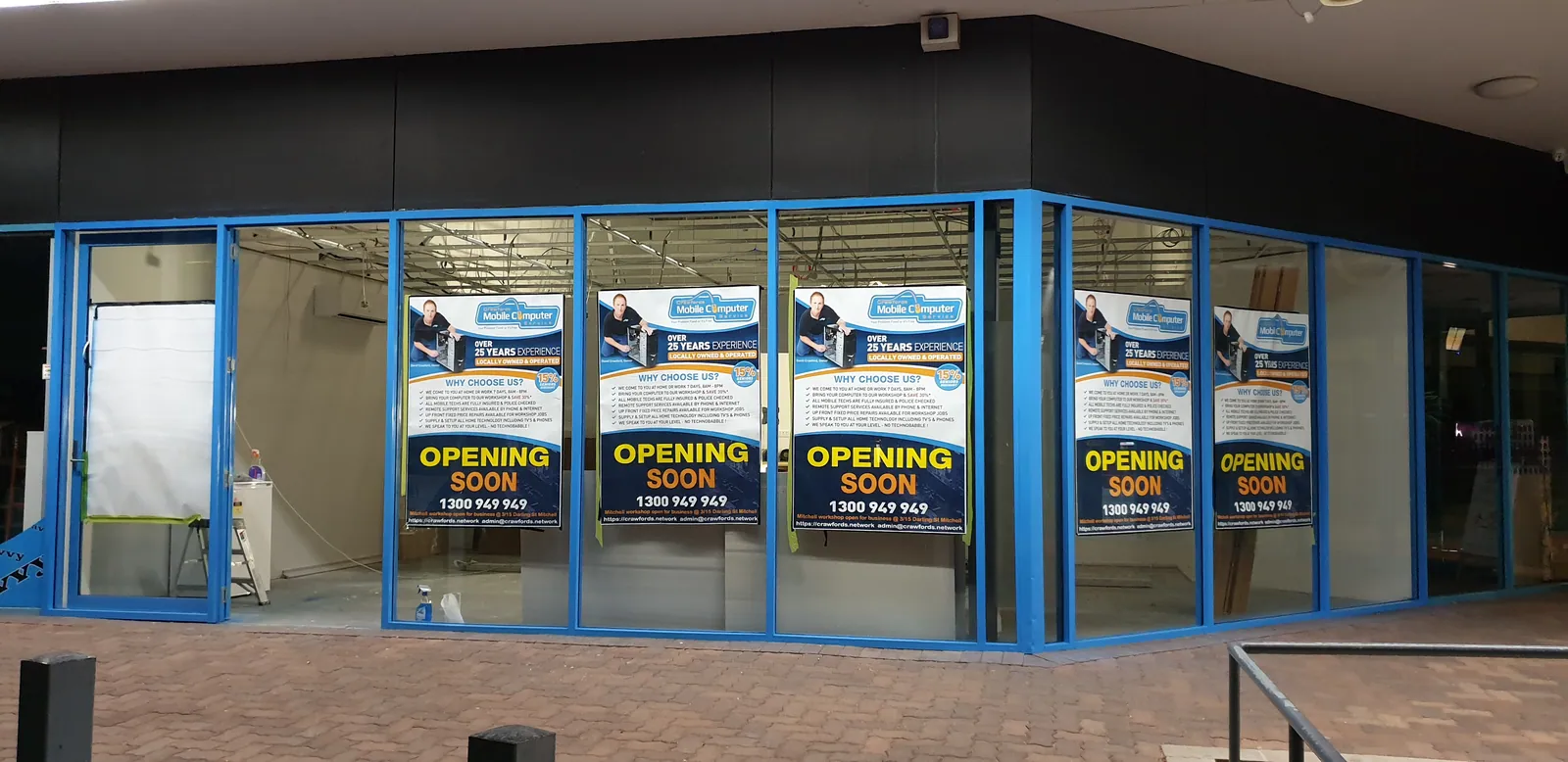

The vacant shopfront in July, before the November construction sequence.
0042 Jul 2019

The vacant shopfront in July, before the November construction sequence.

Looking through the front glazing into the empty unit.
0052 Jul 2019

Looking through the front glazing into the empty unit.

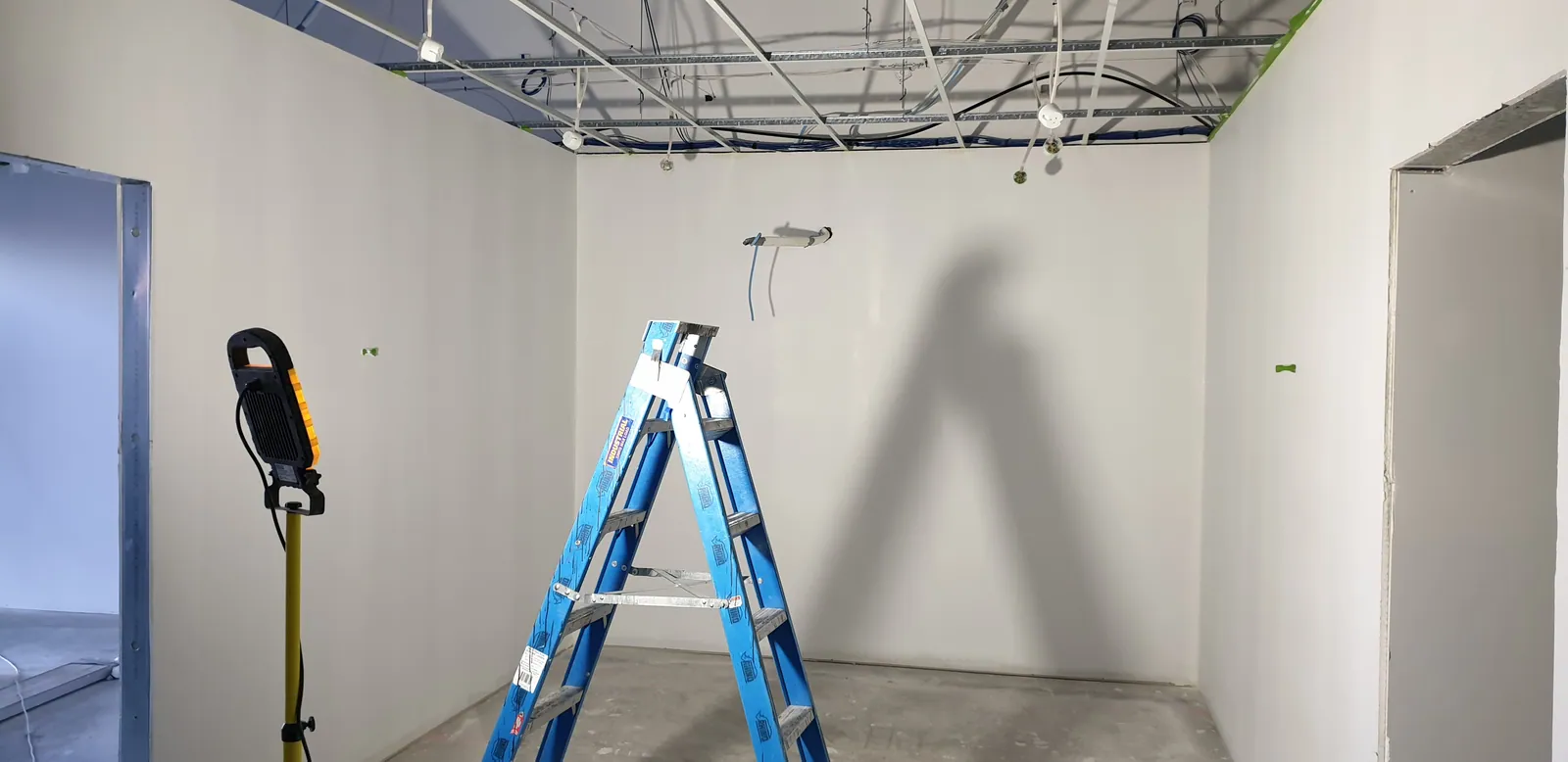

02Preparing the premises

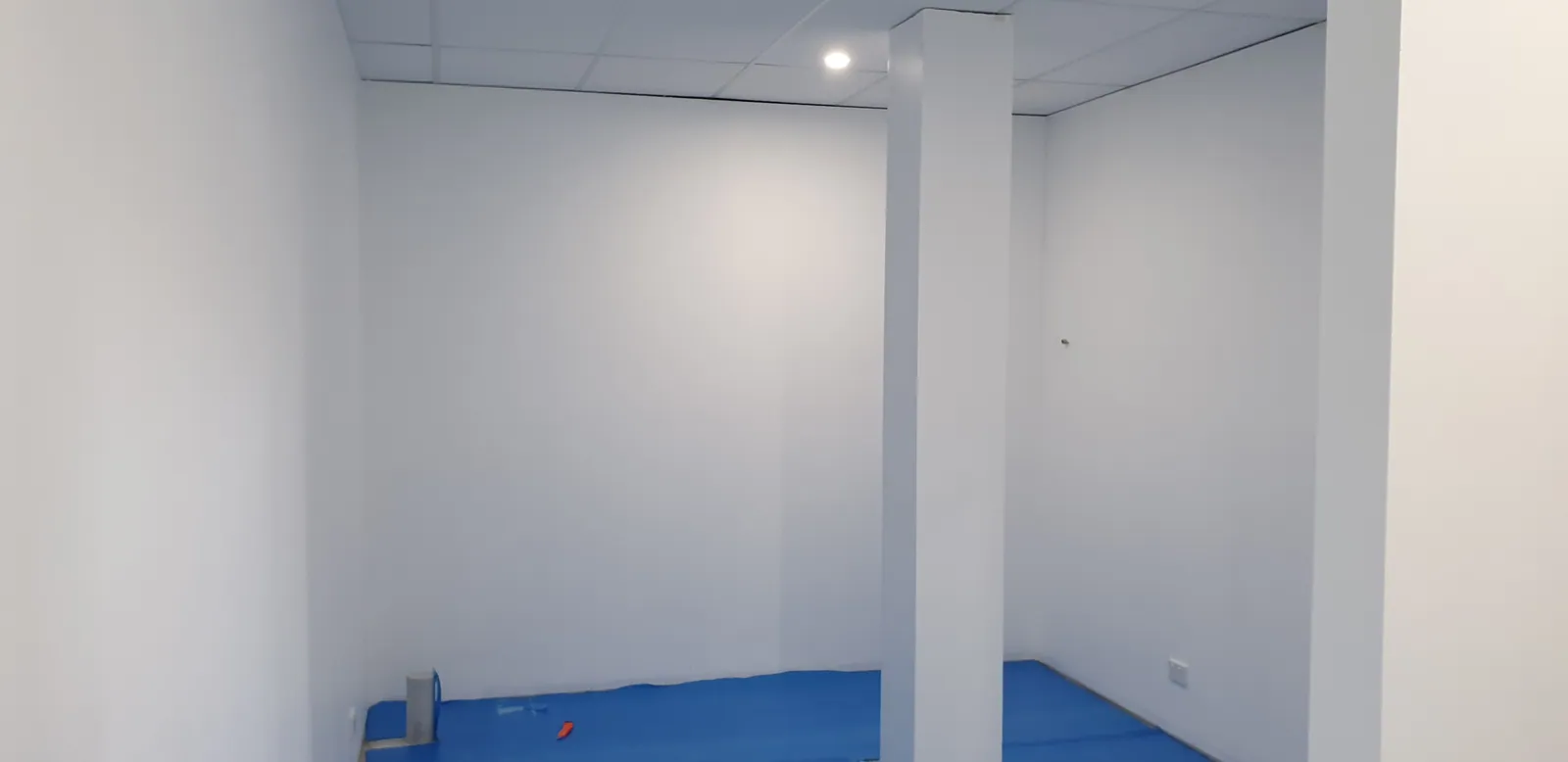

The empty interior at the start of the November fit-out.

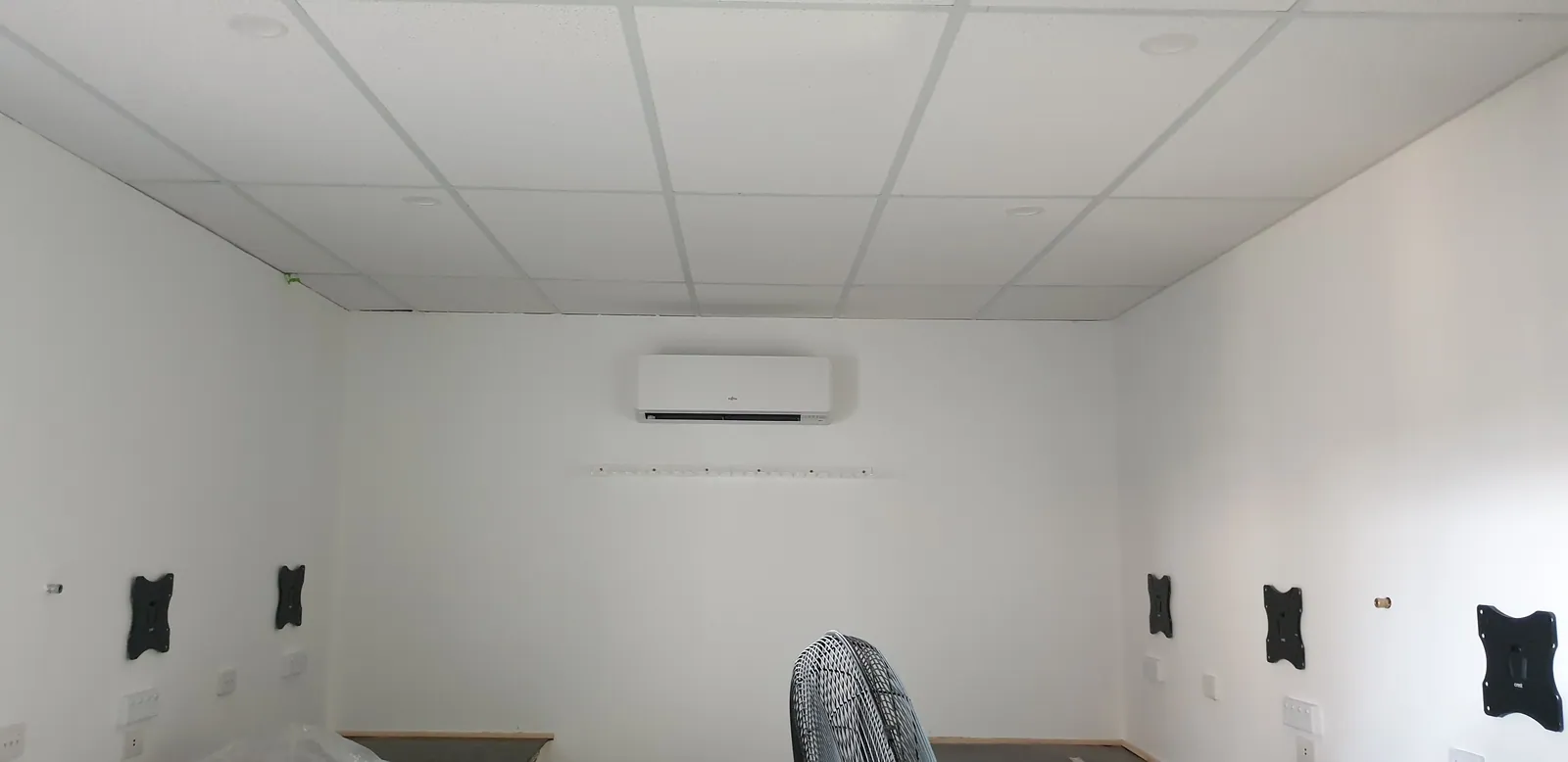

0065 Nov 2019

The empty interior at the start of the November fit-out.

Looking towards the shopfront across the clear floor.

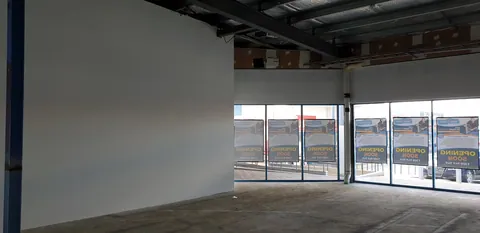

0075 Nov 2019

Looking towards the shopfront across the clear floor.

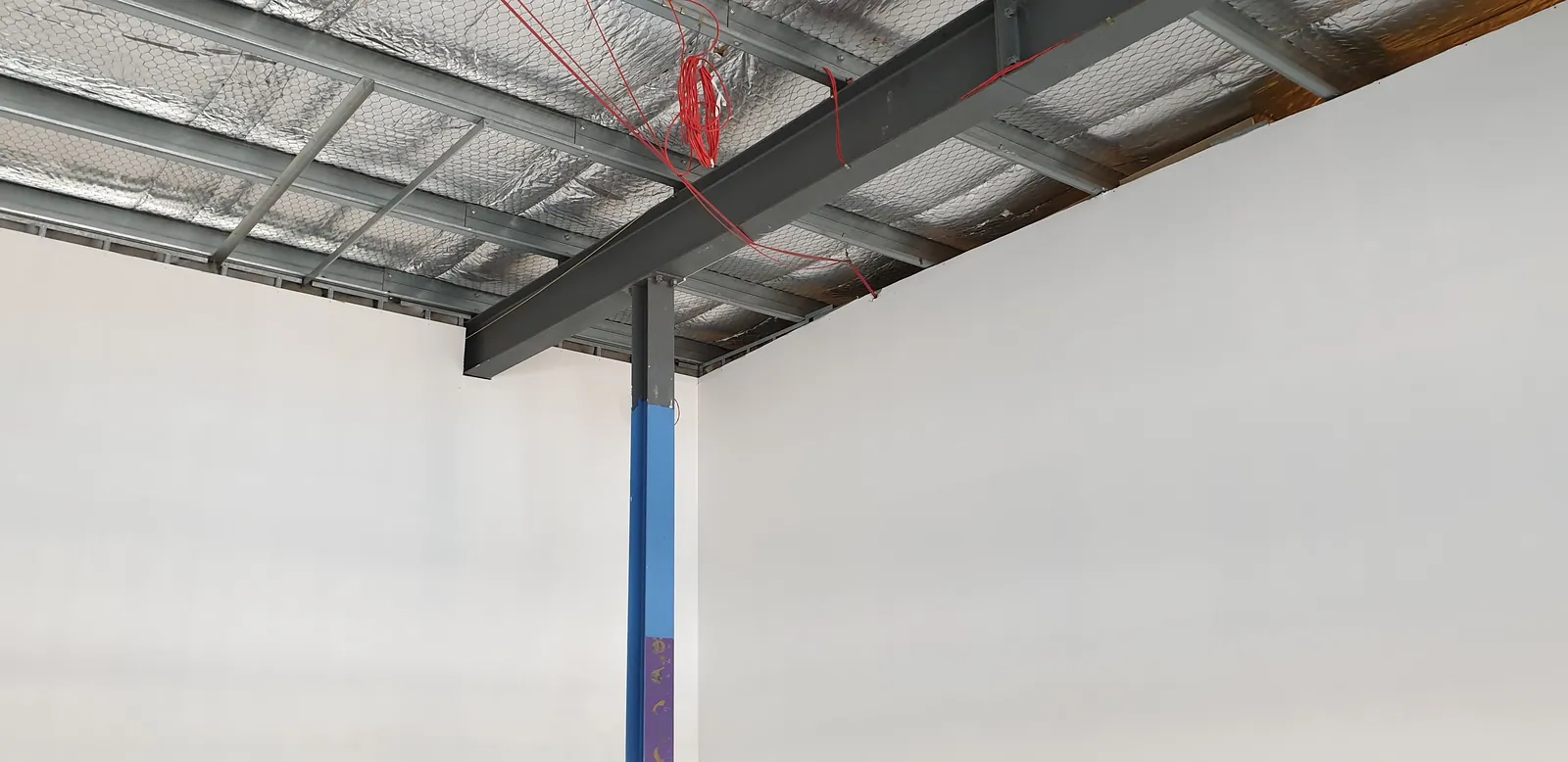

The existing roof structure above the blue front column.
0085 Nov 2019

The existing roof structure above the blue front column.

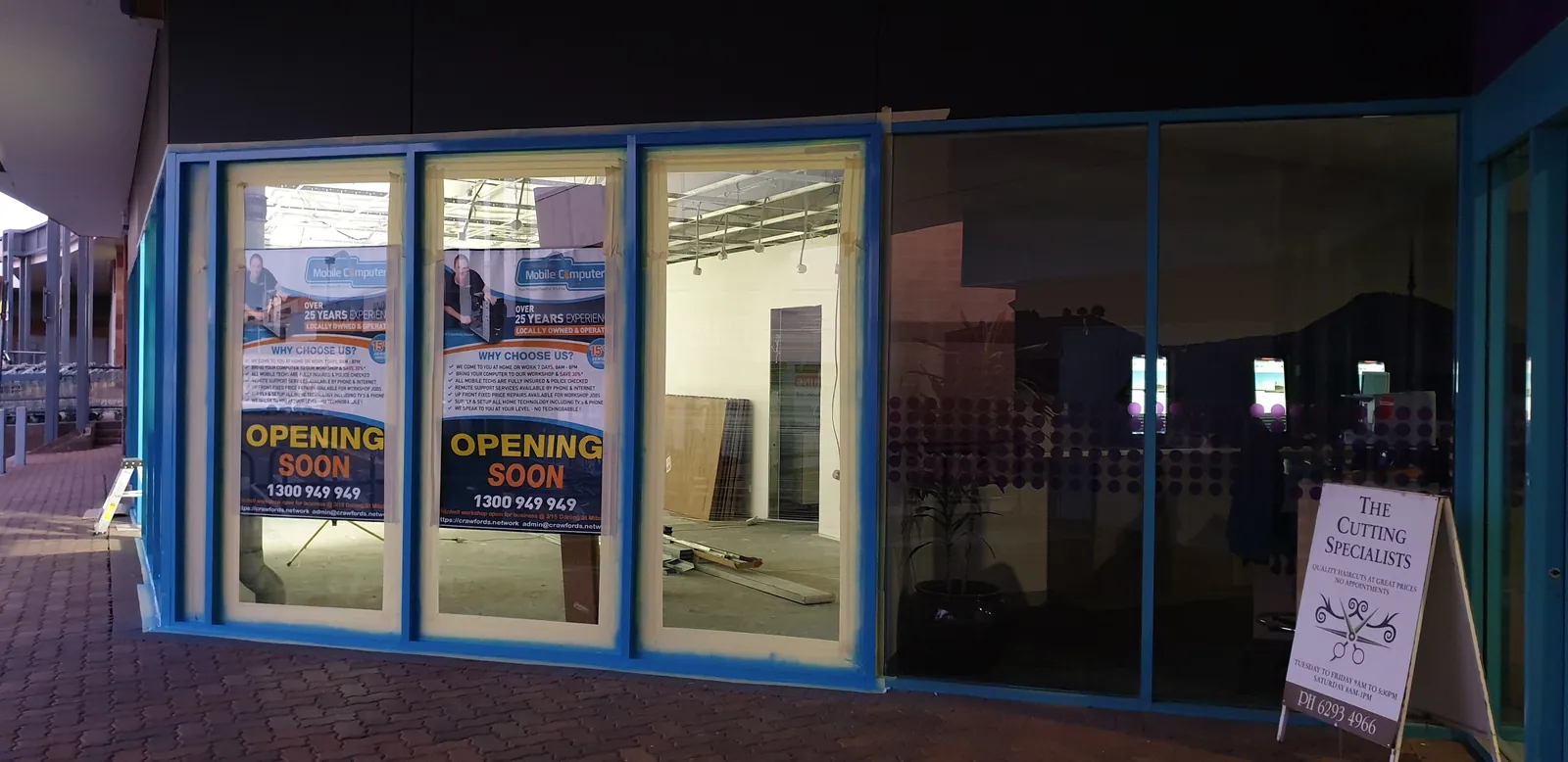

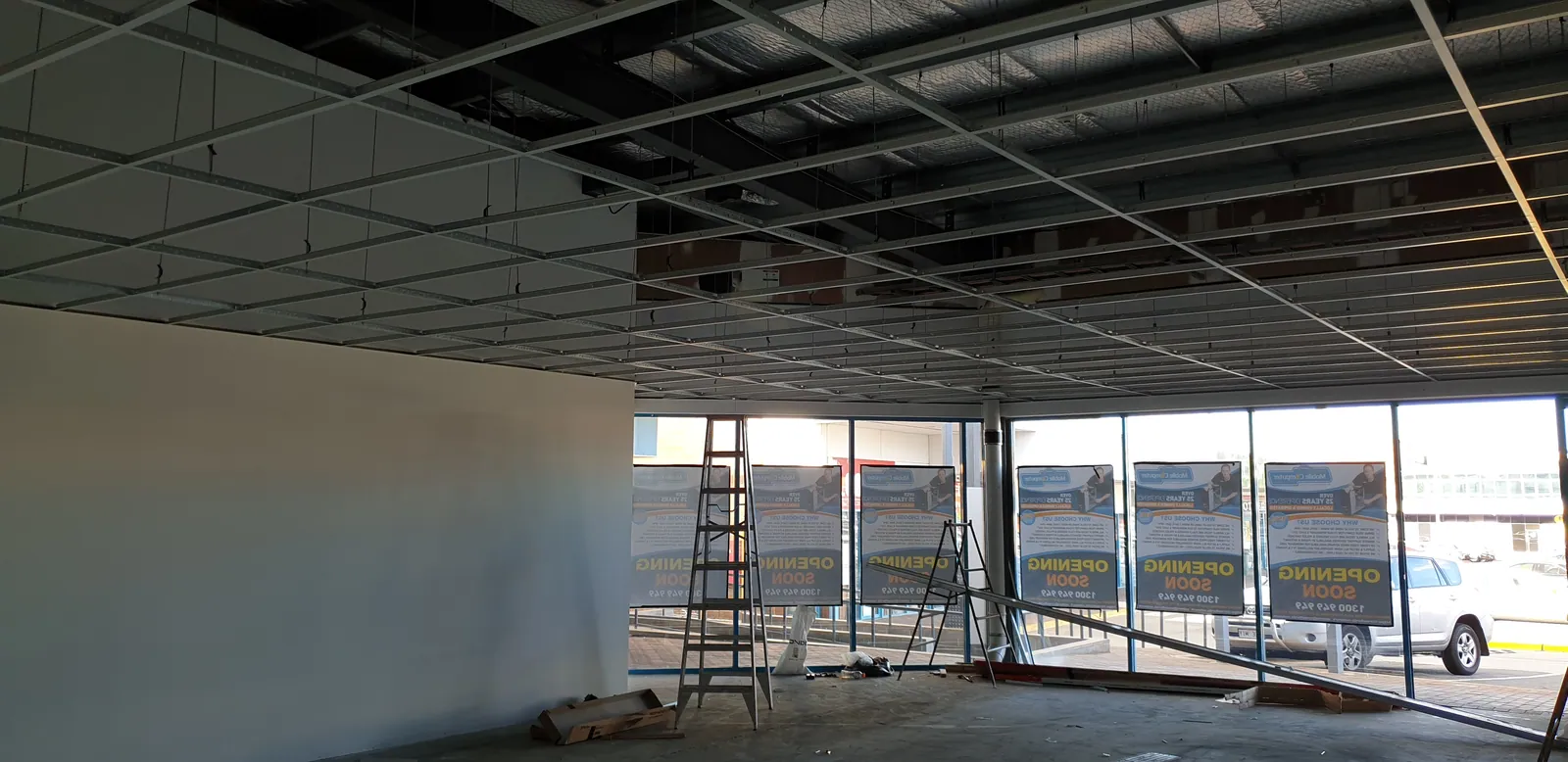

Opening Soon notices displayed on the front windows.
0095 Nov 2019

Opening Soon notices displayed on the front windows.

03Ceiling grid and wall framing

Ladders and tools brought in to begin work on the interior.
0106 Nov 2019

Ladders and tools brought in to begin work on the interior.

Materials set out across the floor before the partitions are built.
0116 Nov 2019

Materials set out across the floor before the partitions are built.

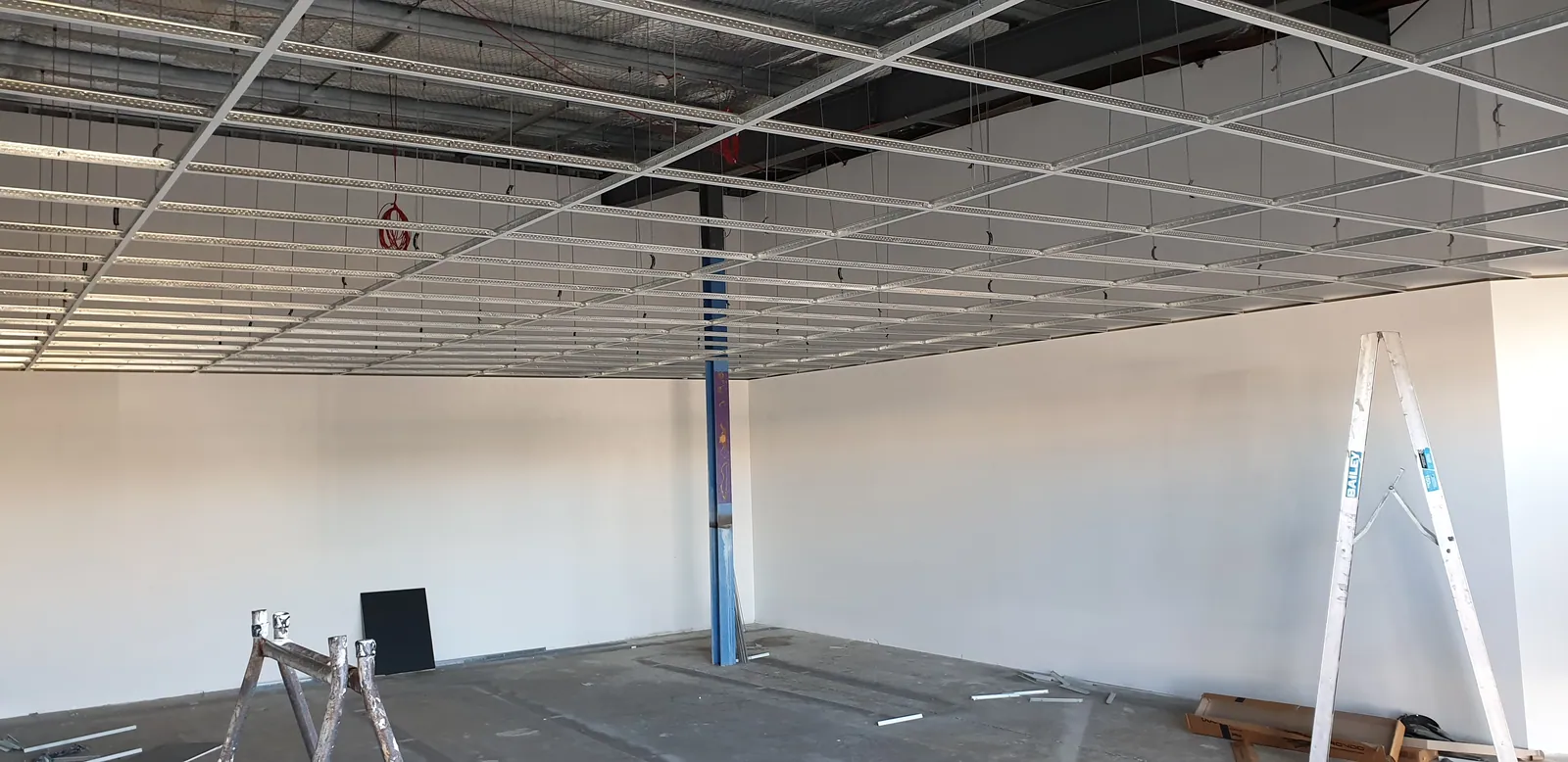

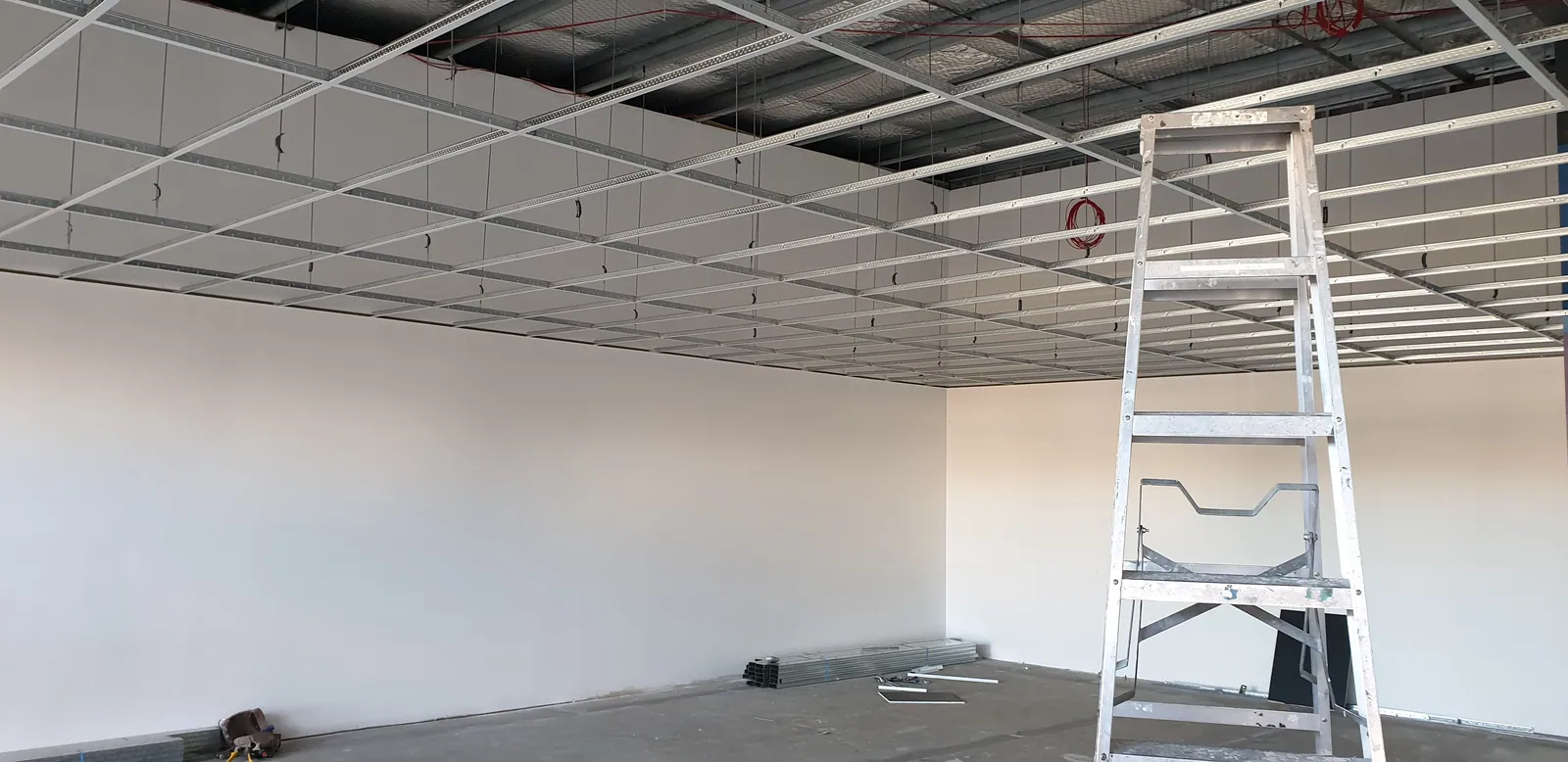

The first suspended-ceiling grid installed at the back.
0127 Nov 2019

The first suspended-ceiling grid installed at the back.

Ceiling-grid work progresses above the ladders.
0137 Nov 2019

Ceiling-grid work progresses above the ladders.

The ceiling grid extending towards the front windows.
0147 Nov 2019

The ceiling grid extending towards the front windows.

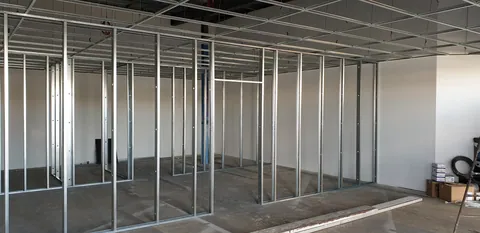

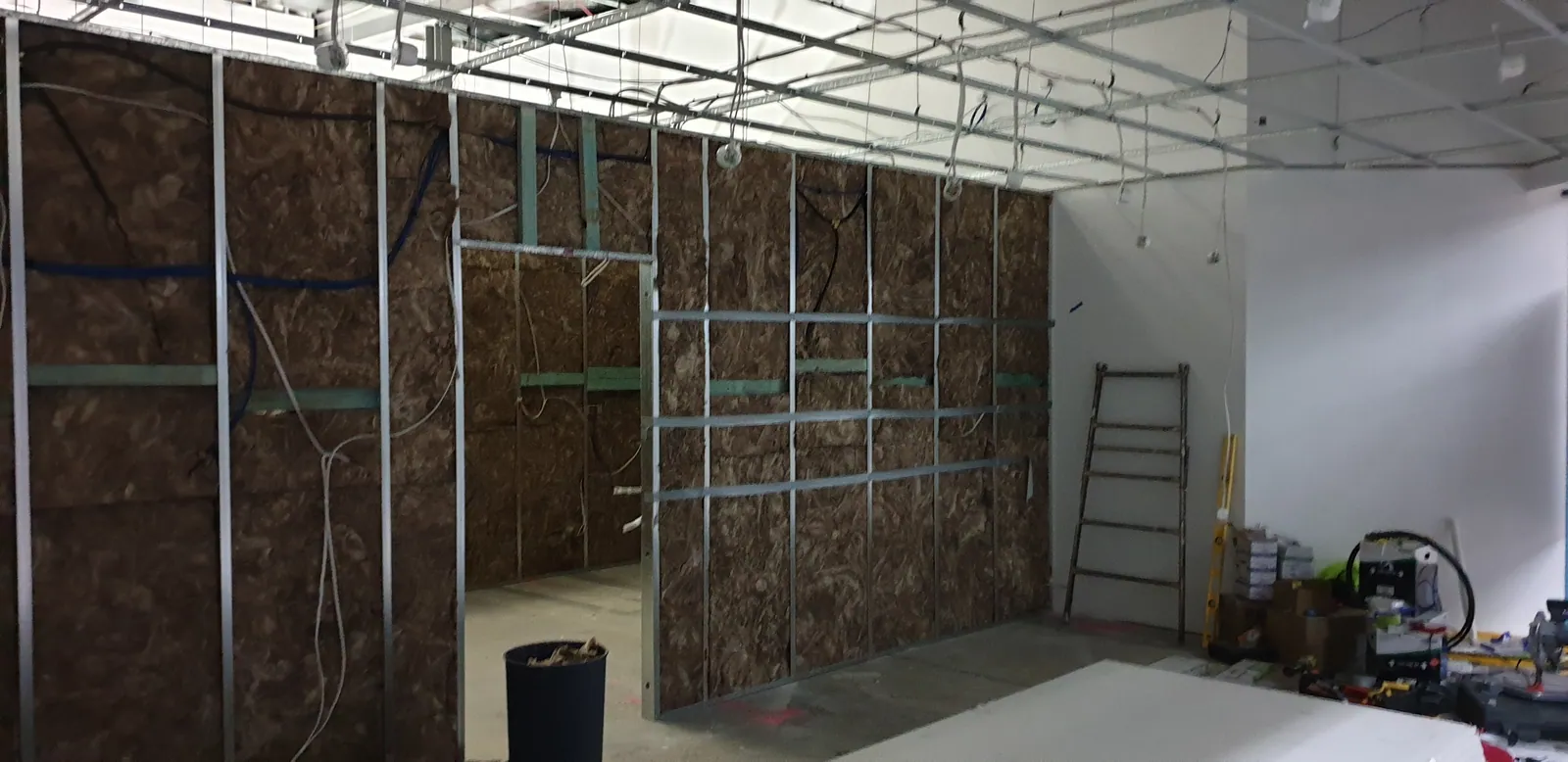

Metal wall framing divides the former open space into rooms.

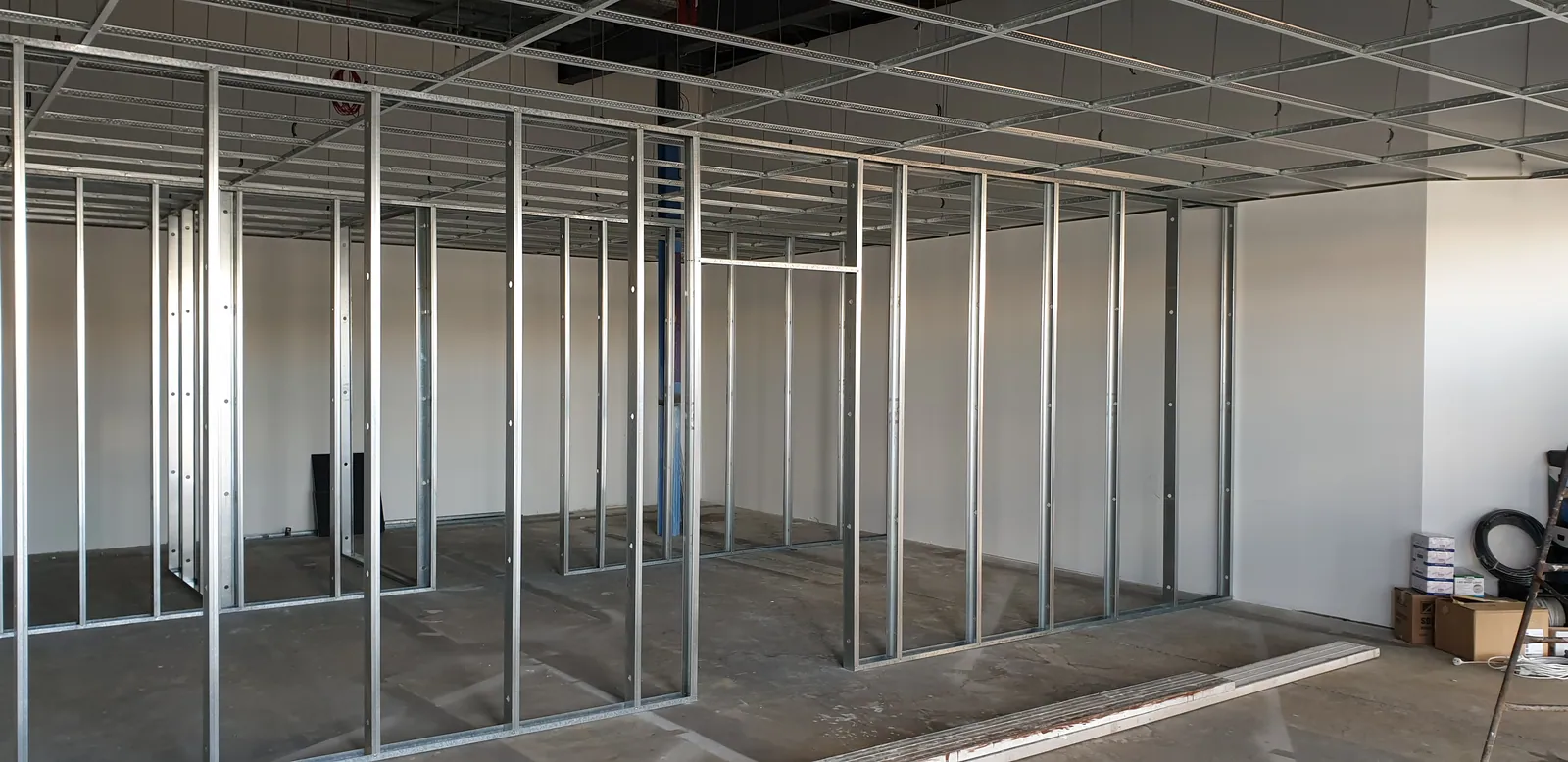

0158 Nov 2019

Metal wall framing divides the former open space into rooms.

The new partition frames viewed along the internal passage.
0168 Nov 2019

The new partition frames viewed along the internal passage.

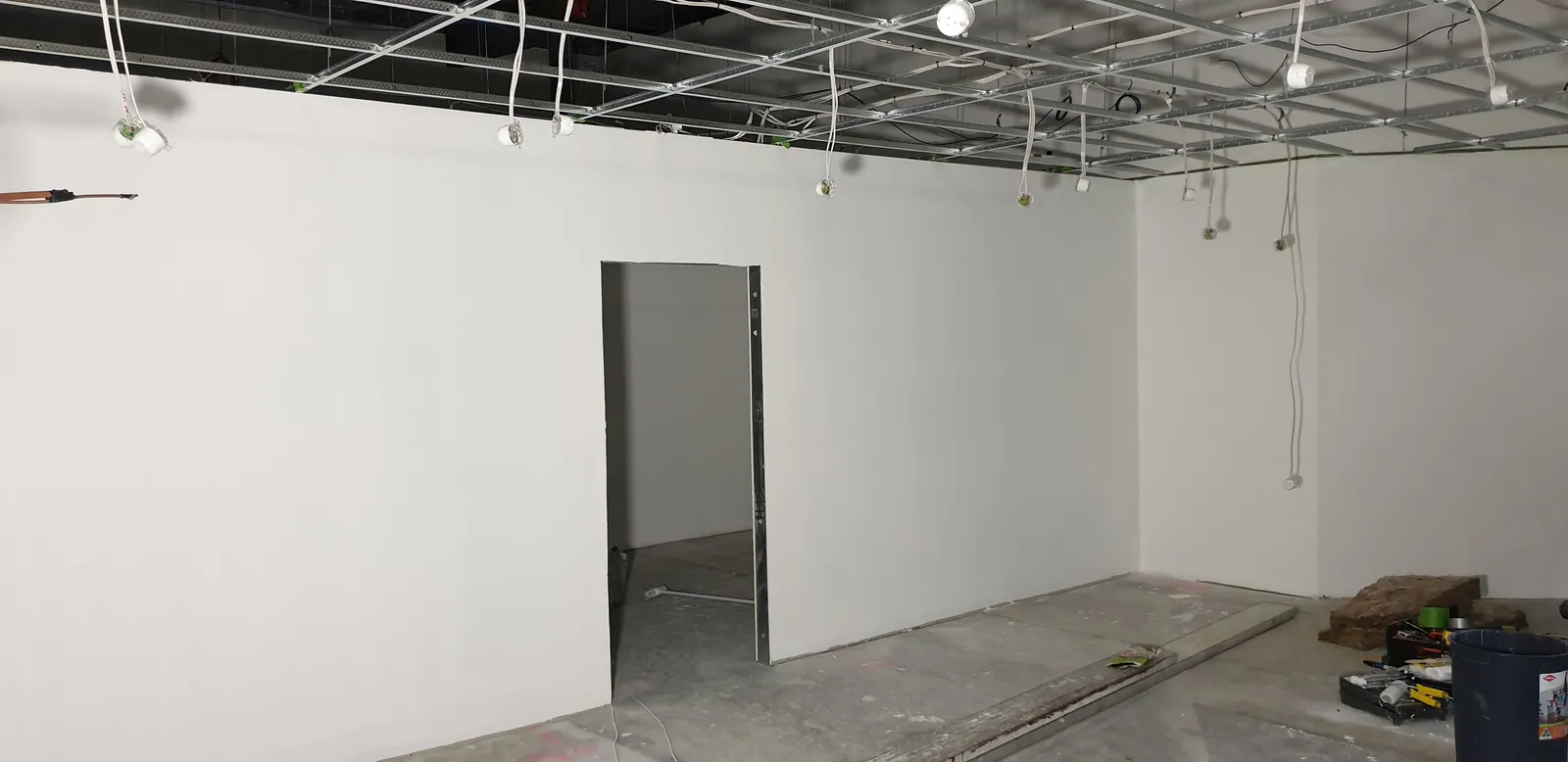

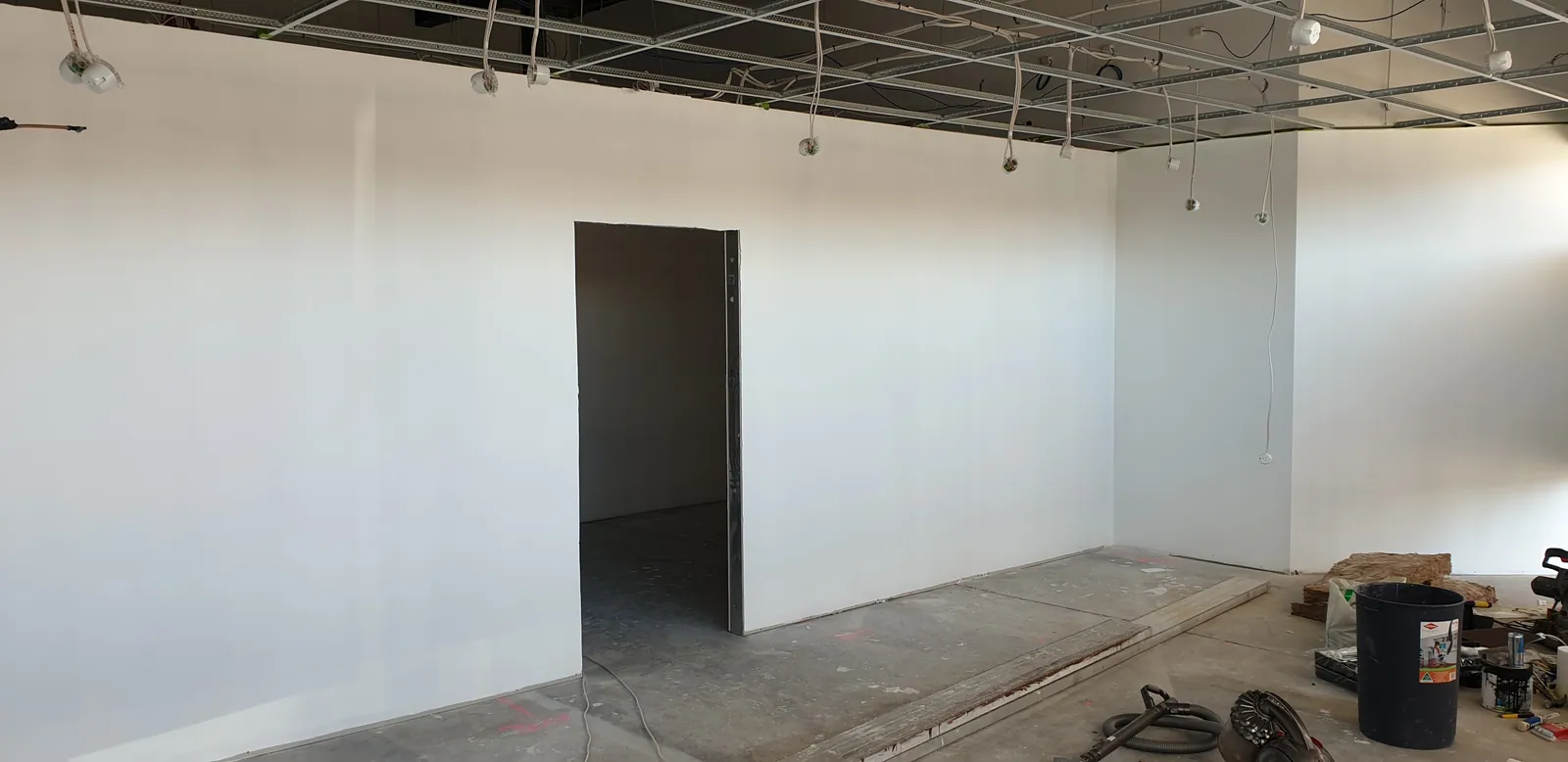

A doorway taking shape in the metal framing.
0178 Nov 2019

A doorway taking shape in the metal framing.

Further partition framing around the ladders and work area.
0189 Nov 2019

Further partition framing around the ladders and work area.

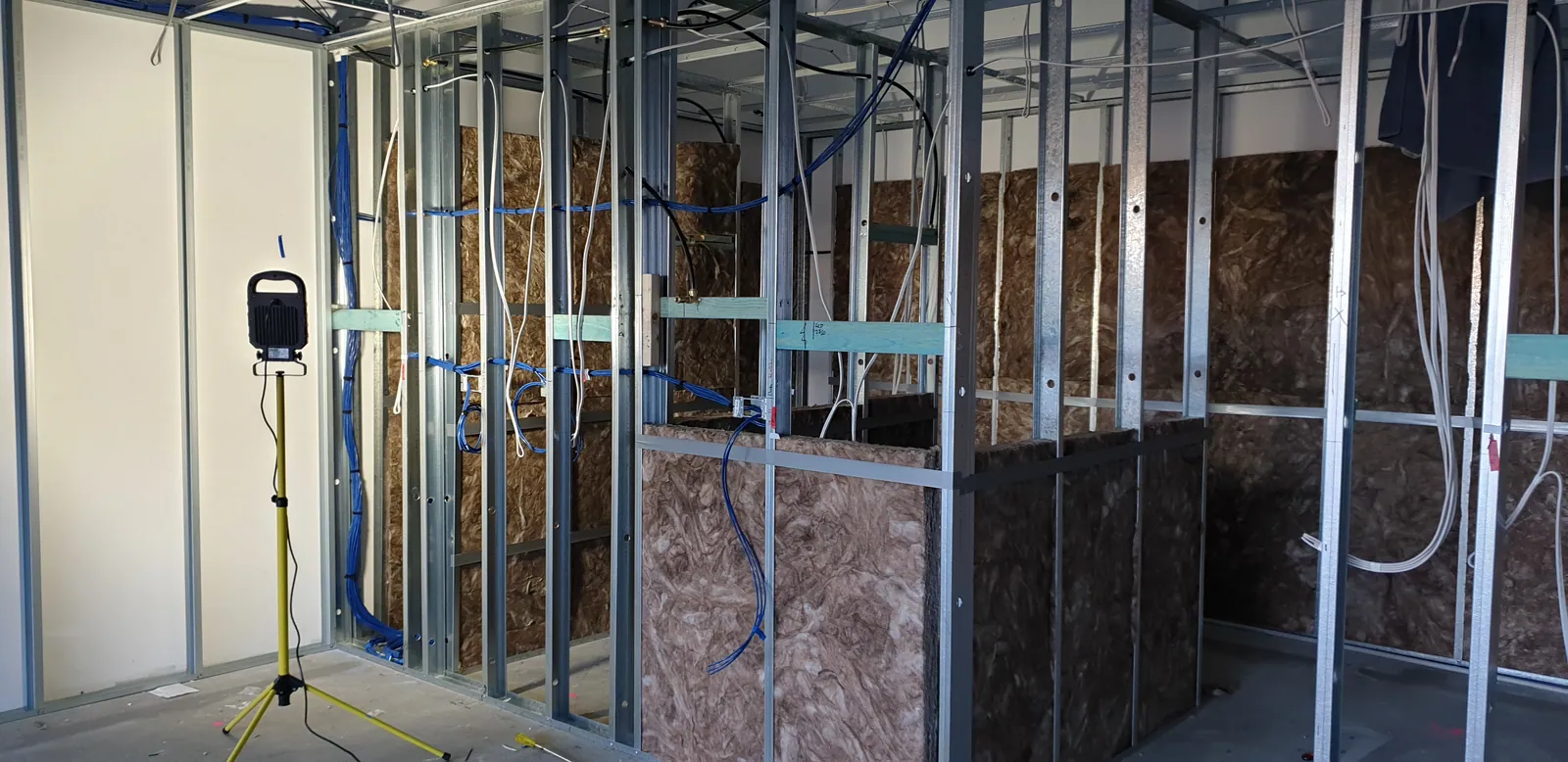

04Services and initial insulation

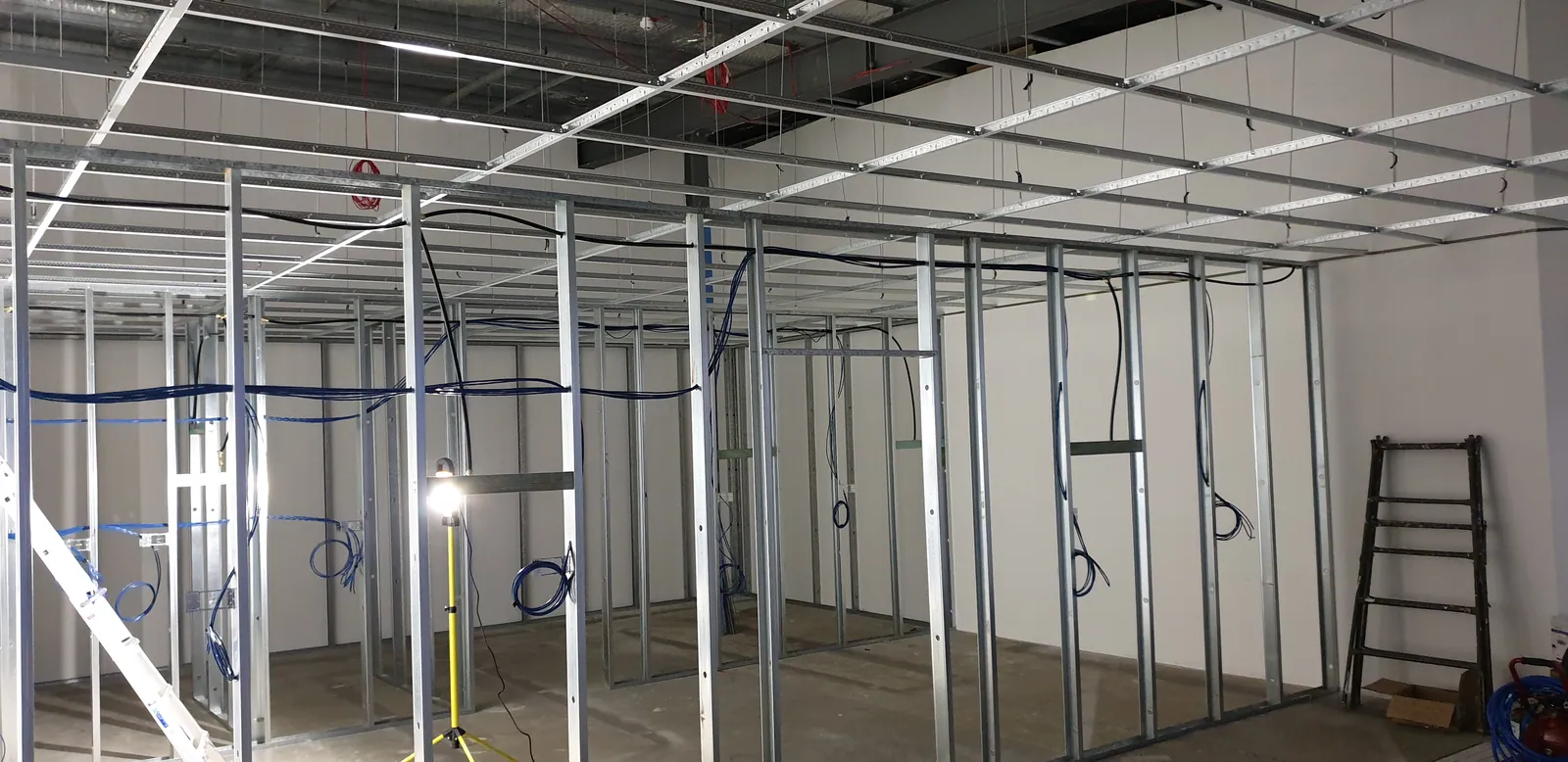

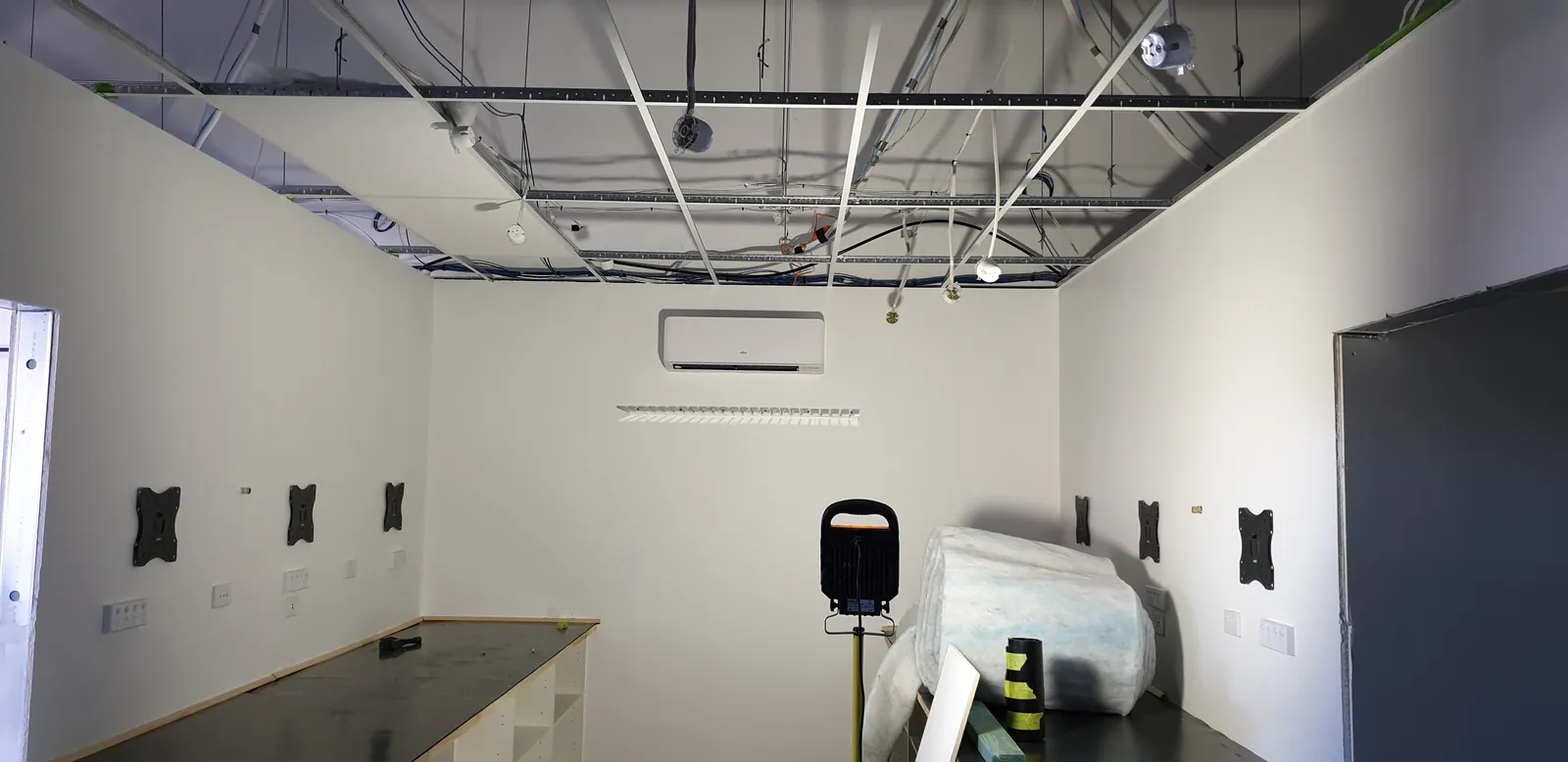

The framed rooms and cabling during an evening of construction.
0199 Nov 2019

The framed rooms and cabling during an evening of construction.

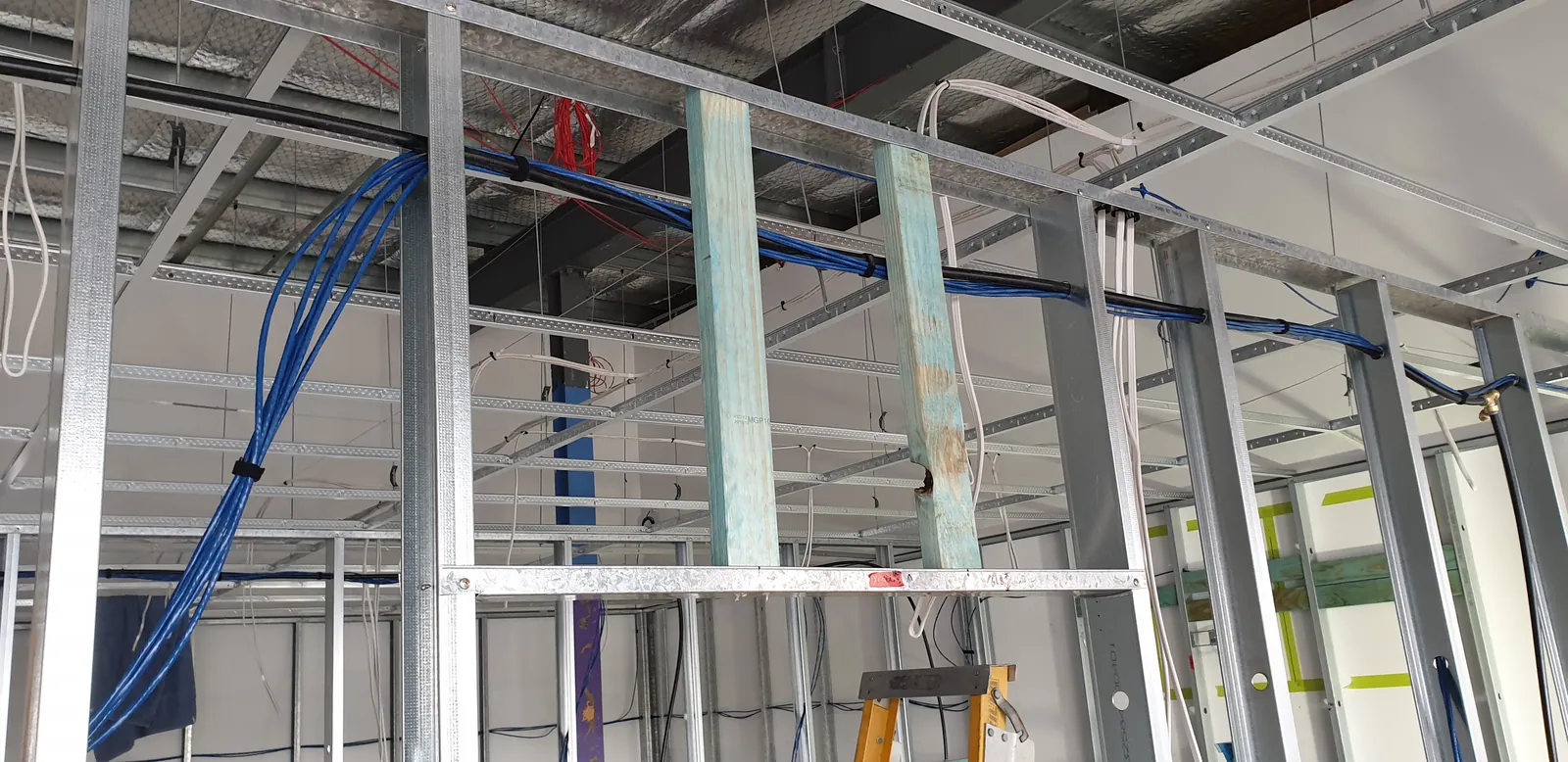

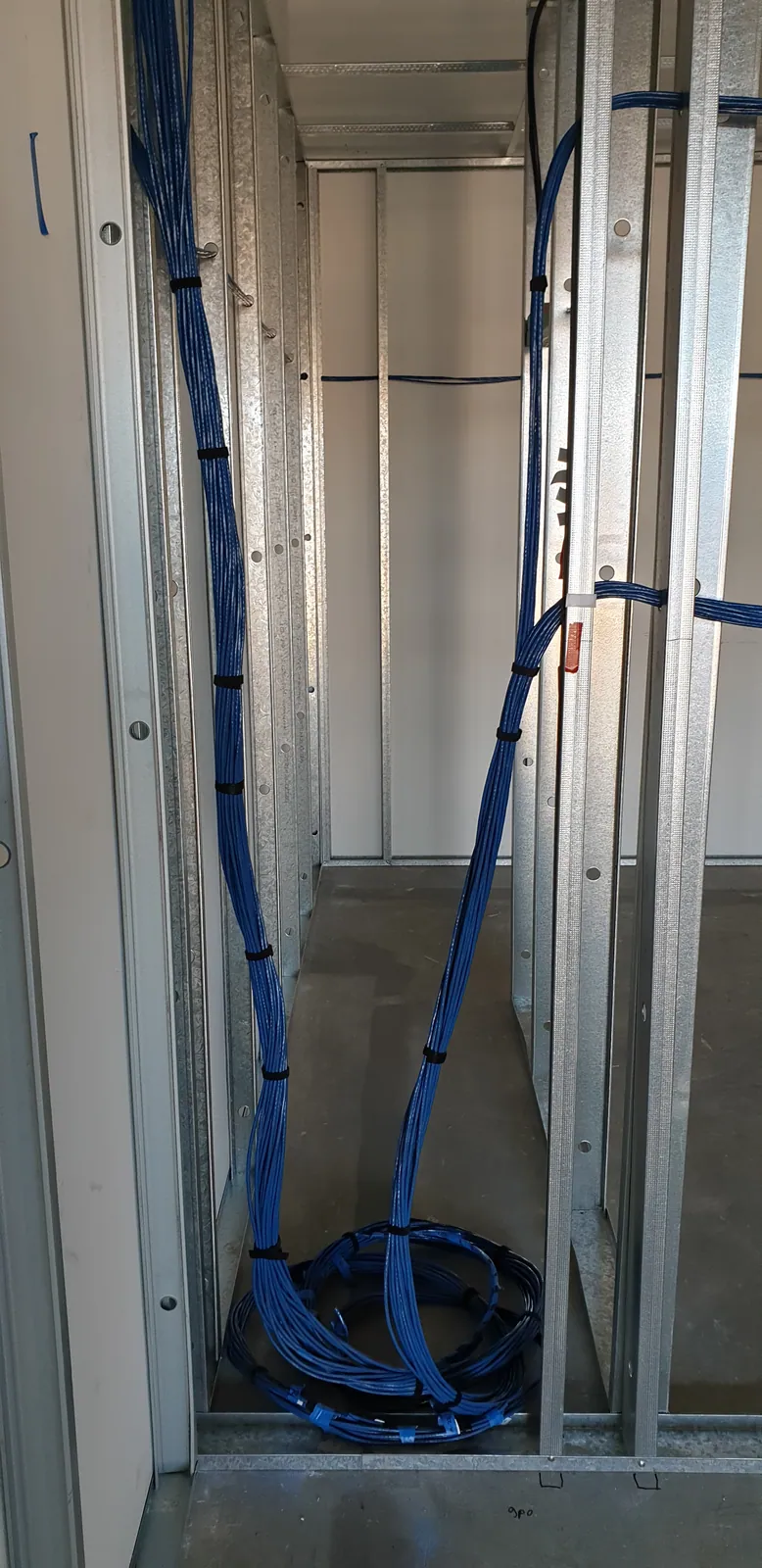

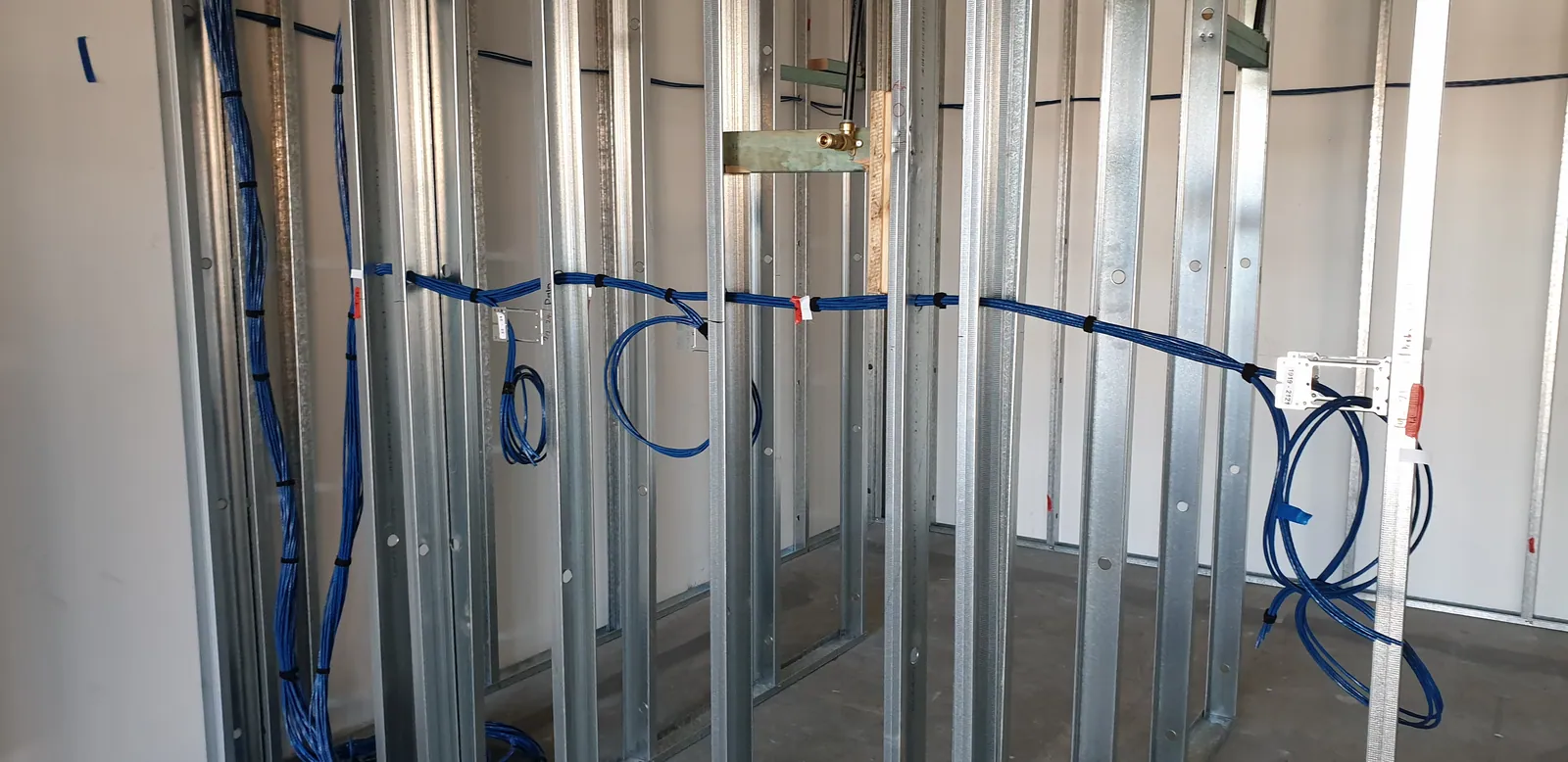

Cables gathered within the new wall framing.
0209 Nov 2019

Cables gathered within the new wall framing.

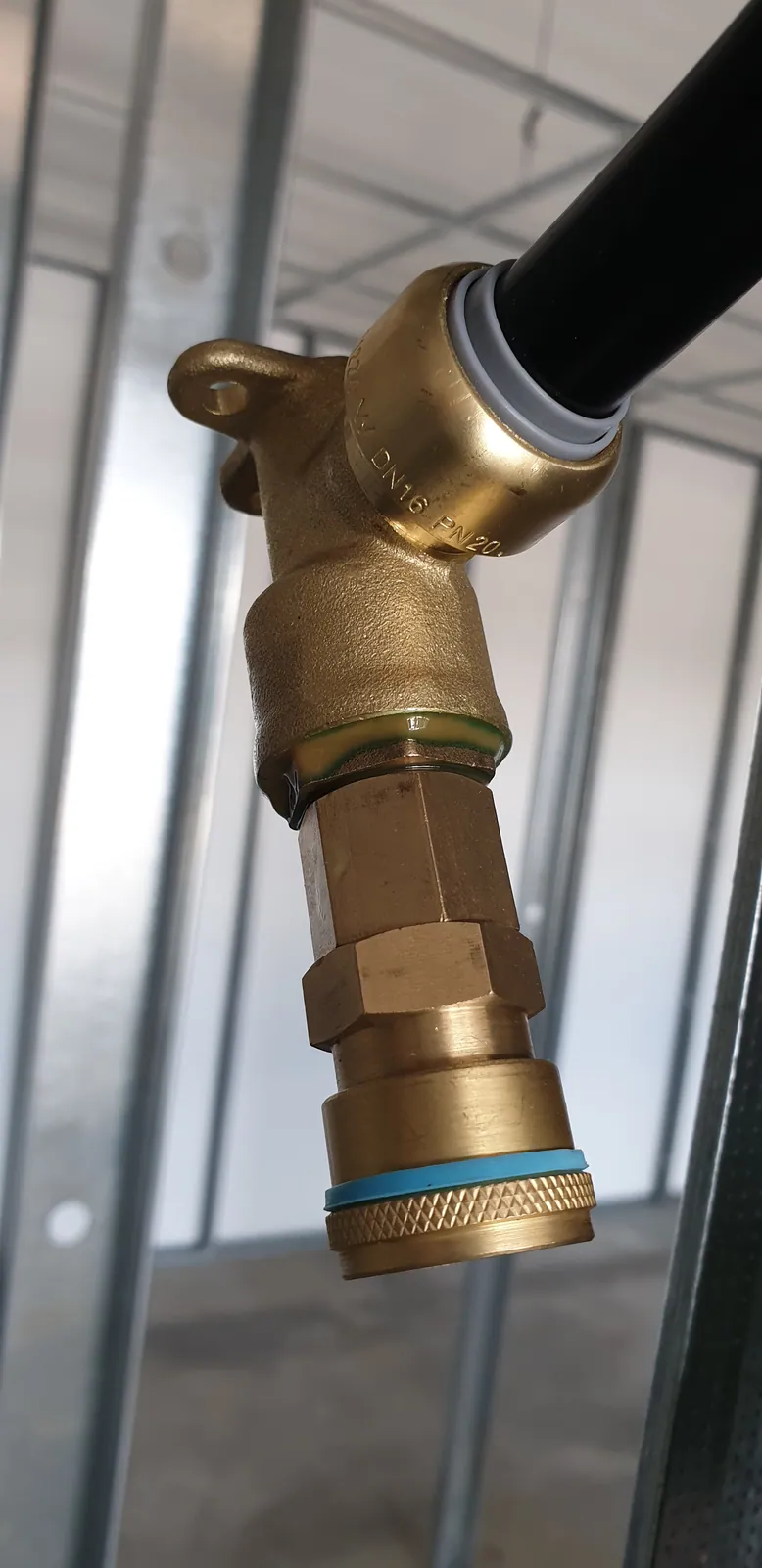

A close view of the compressed-air fittings being prepared.
02110 Nov 2019

A close view of the compressed-air fittings being prepared.

The compressor and tools inside the framed workshop.
02210 Nov 2019

The compressor and tools inside the framed workshop.

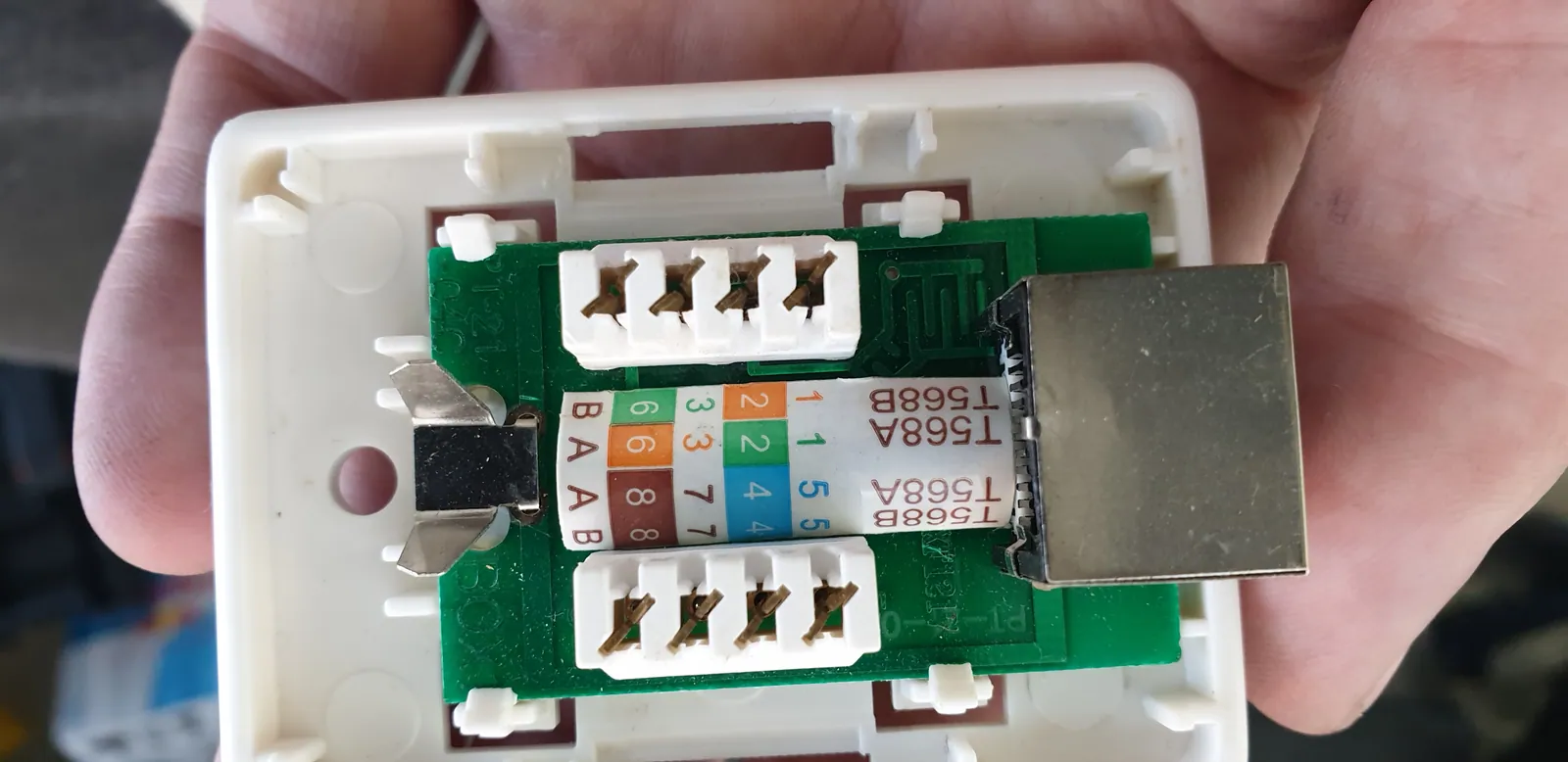

A data connection prepared for the new work areas.
02311 Nov 2019

A data connection prepared for the new work areas.

The framework and service runs viewed across the workshop.
02411 Nov 2019

The framework and service runs viewed across the workshop.

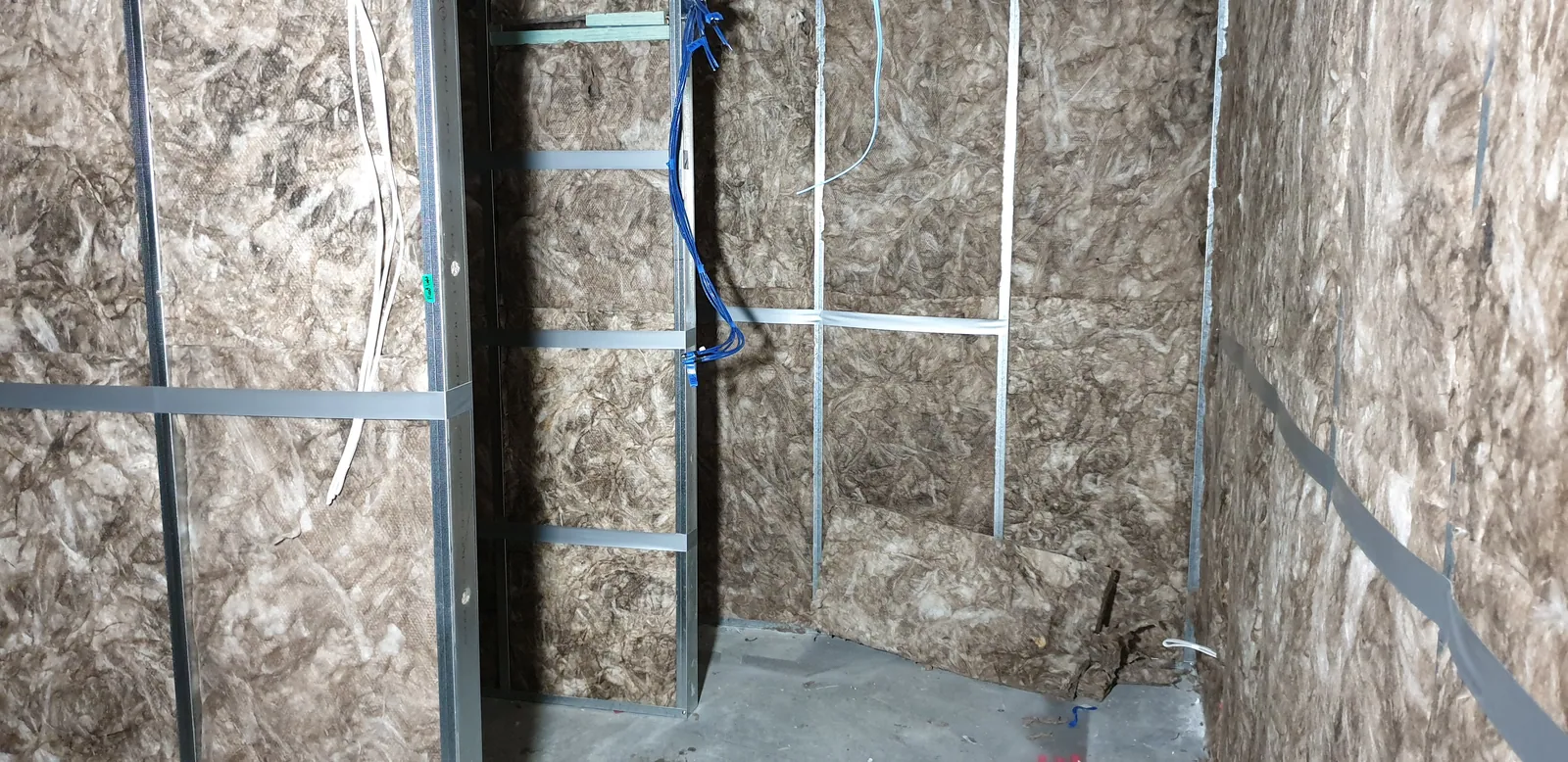

The framed passage and door openings between the rooms.
02511 Nov 2019

The framed passage and door openings between the rooms.

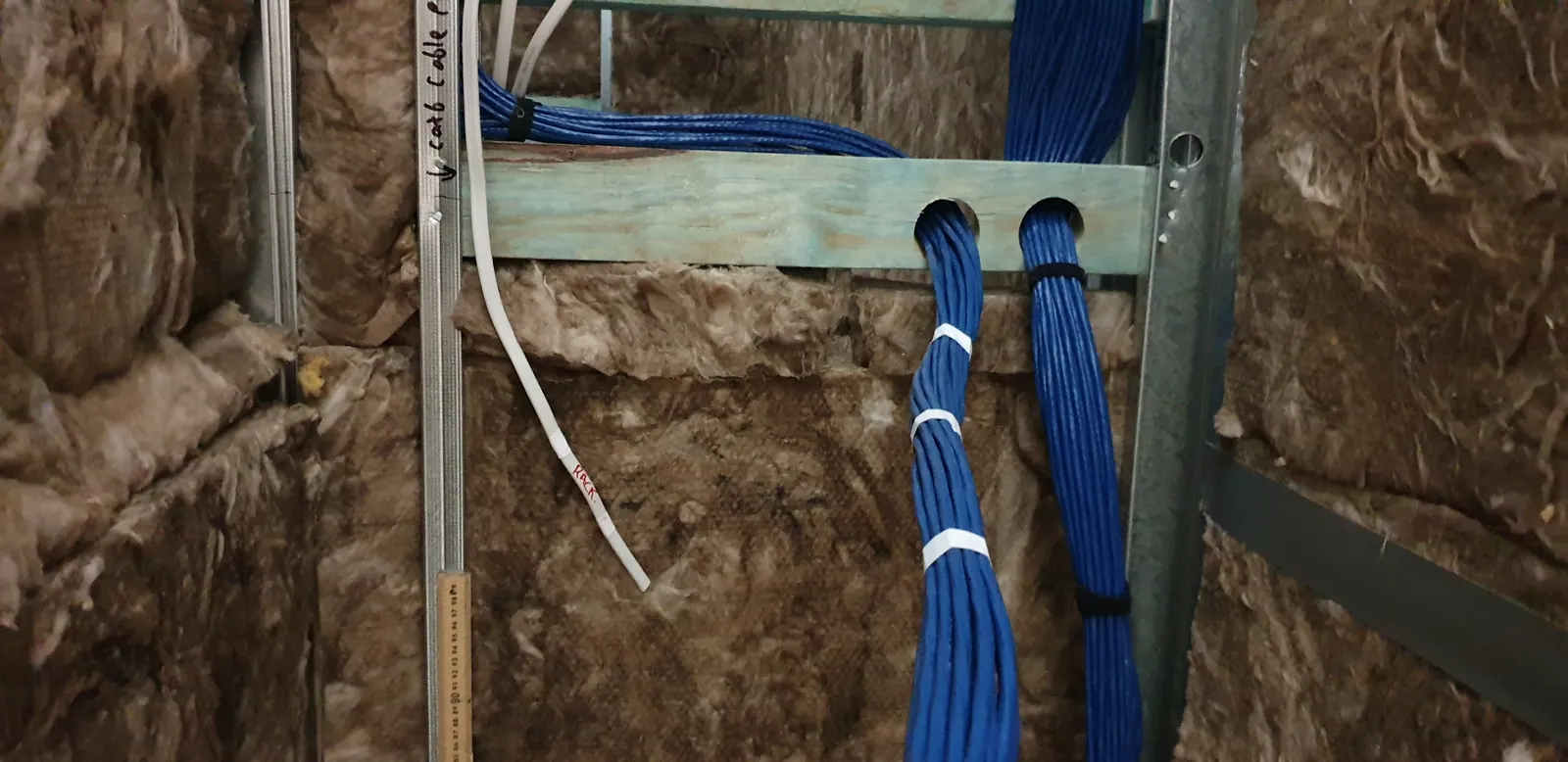

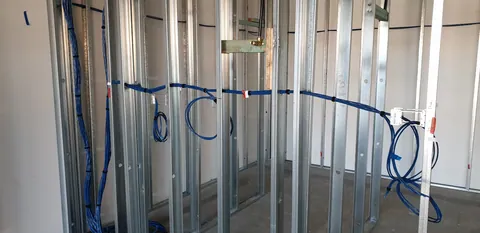

Services routed through the wall framing before lining.
02611 Nov 2019

Services routed through the wall framing before lining.

Blue service lines running through the new partitions.
02711 Nov 2019

Blue service lines running through the new partitions.

Cables brought down from above into the wall cavity.
02812 Nov 2019

Cables brought down from above into the wall cavity.

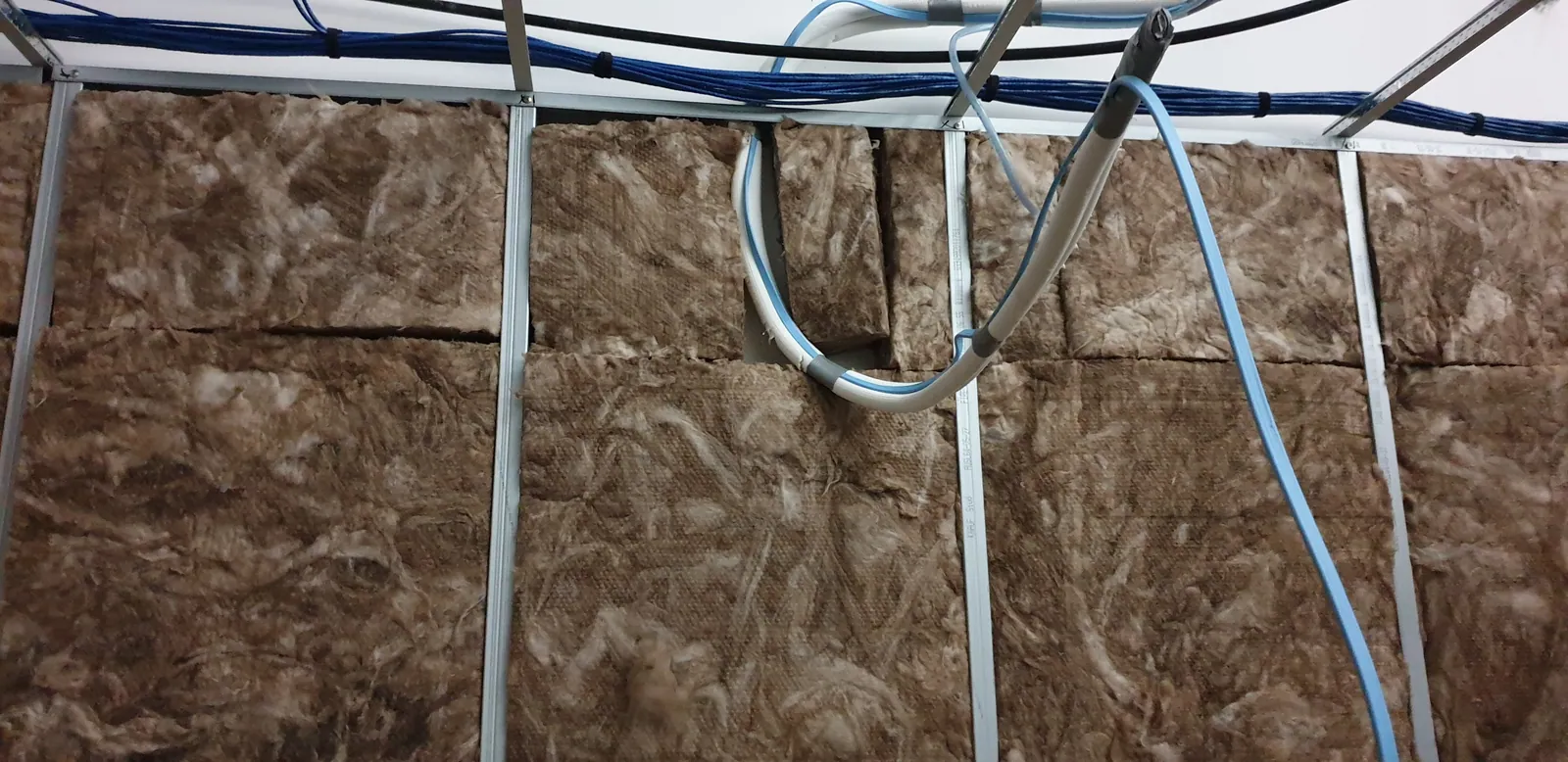

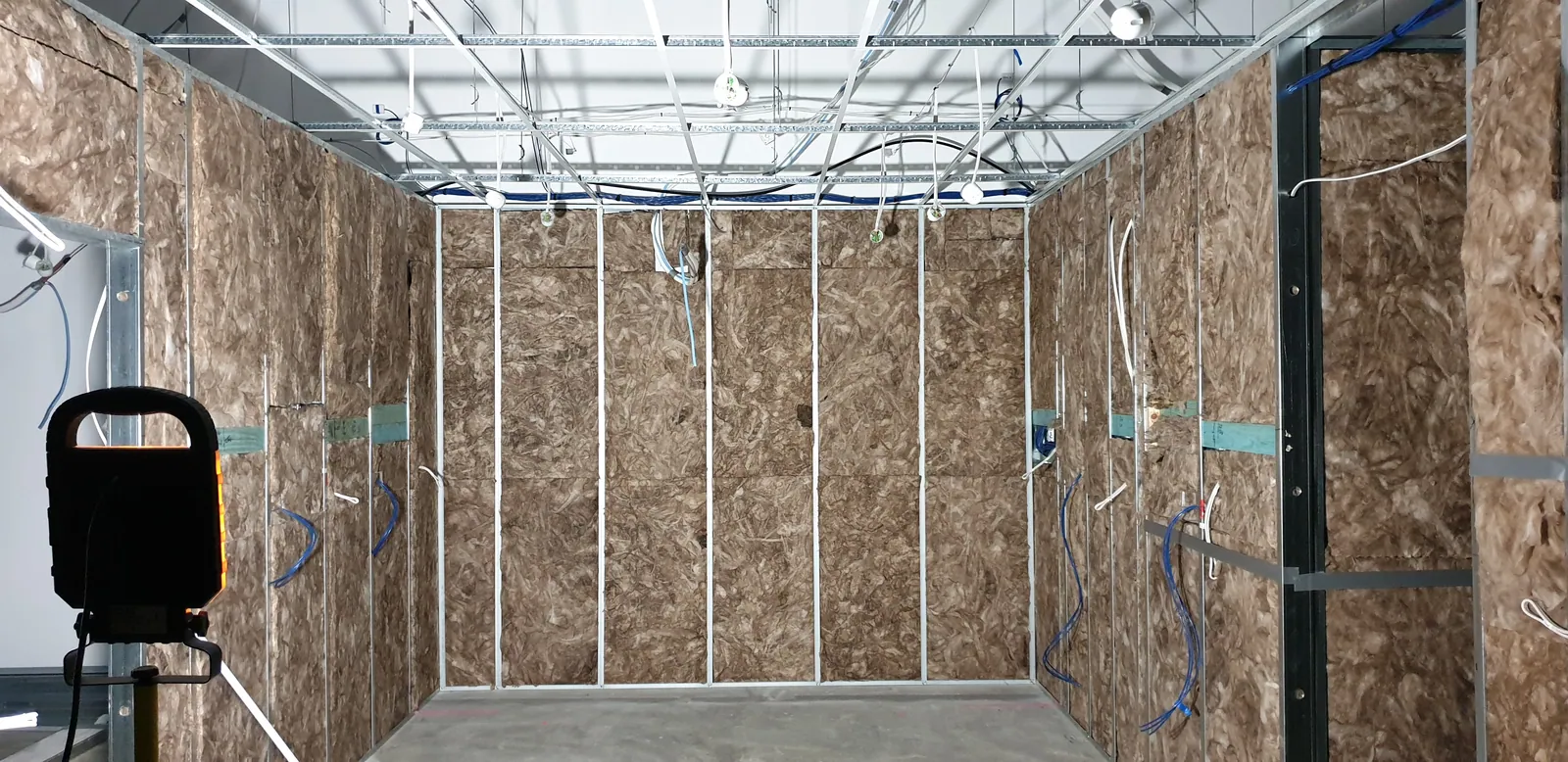

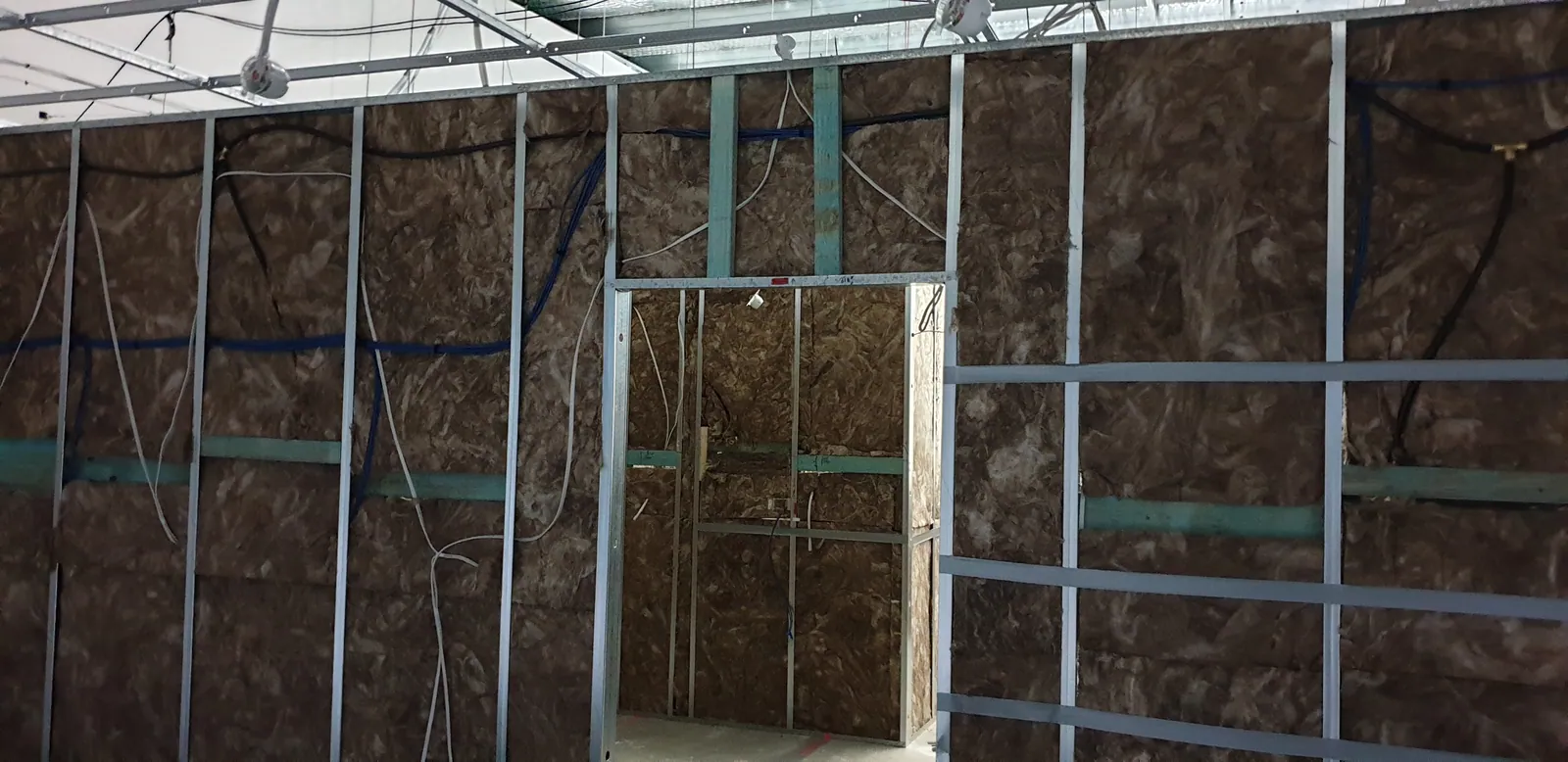

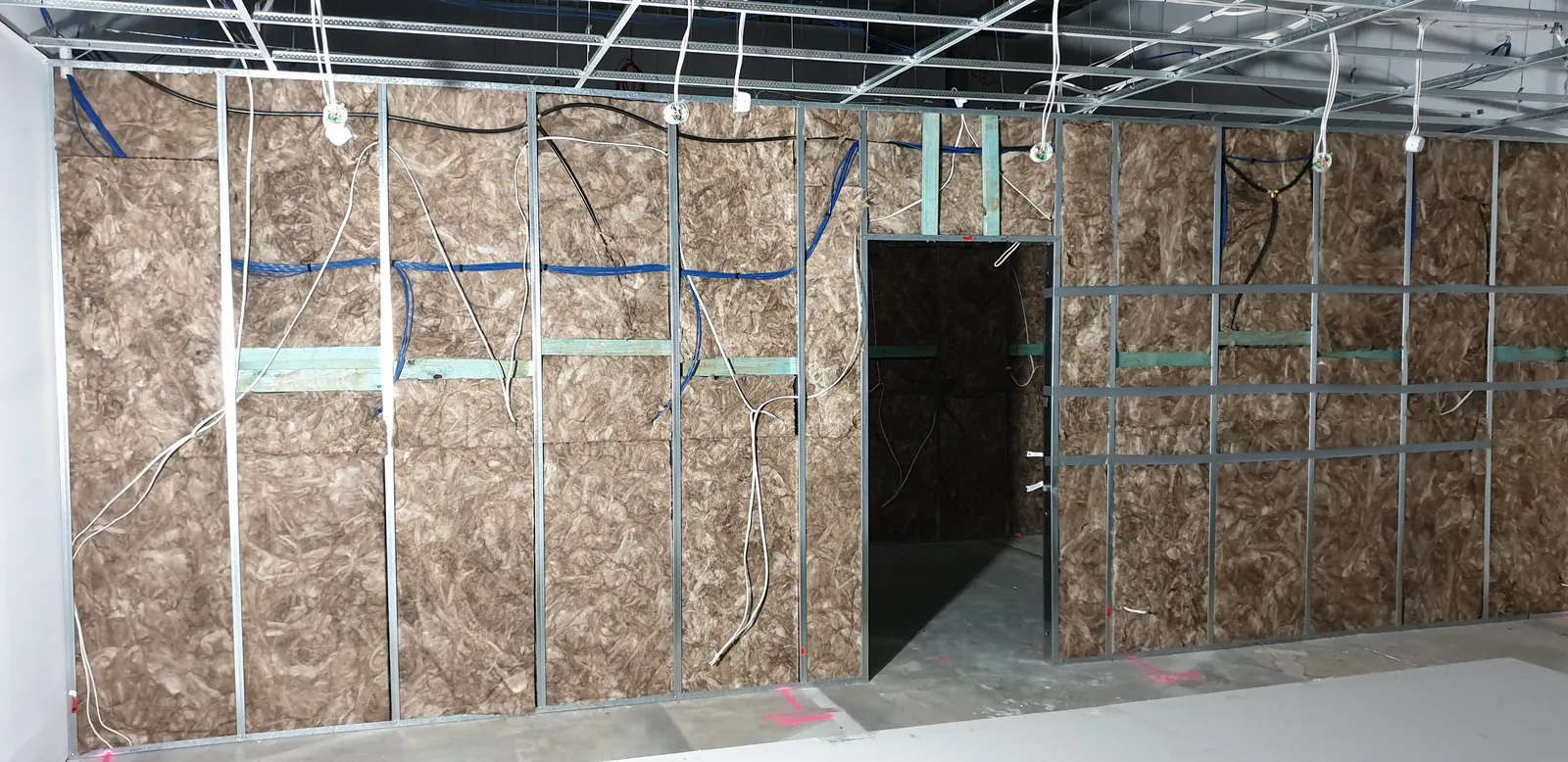

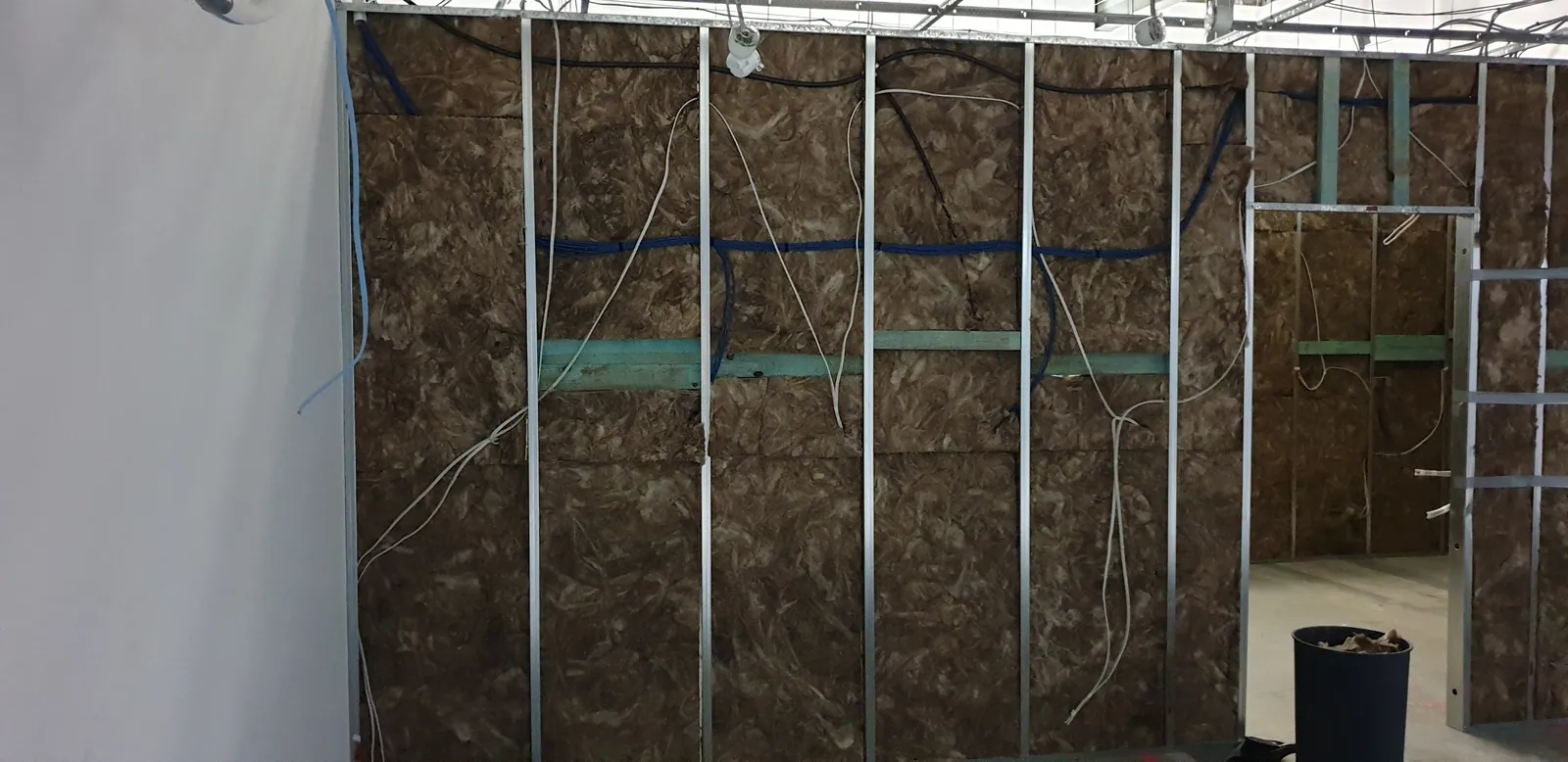

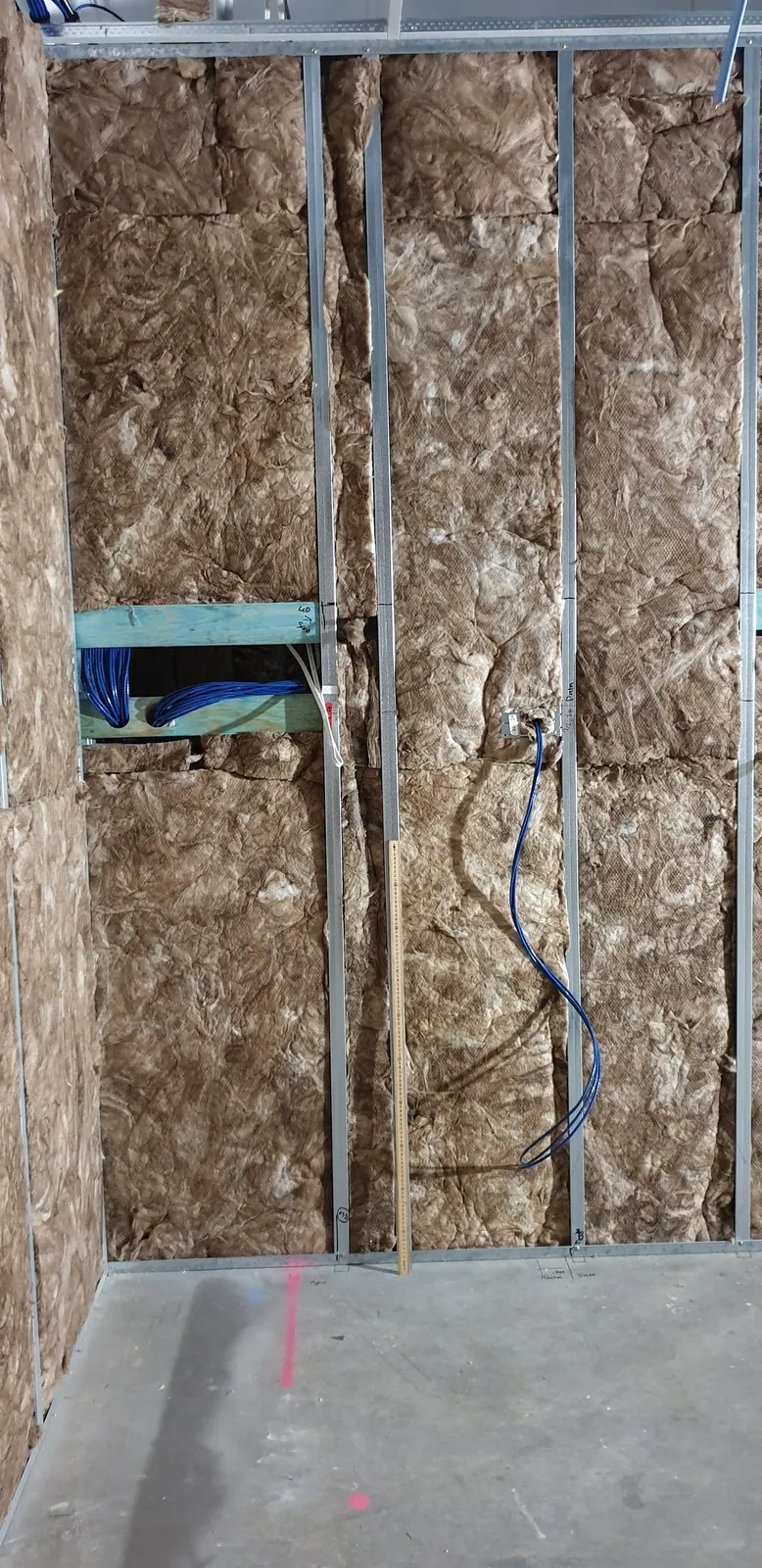

Insulation being fitted between the wall studs.

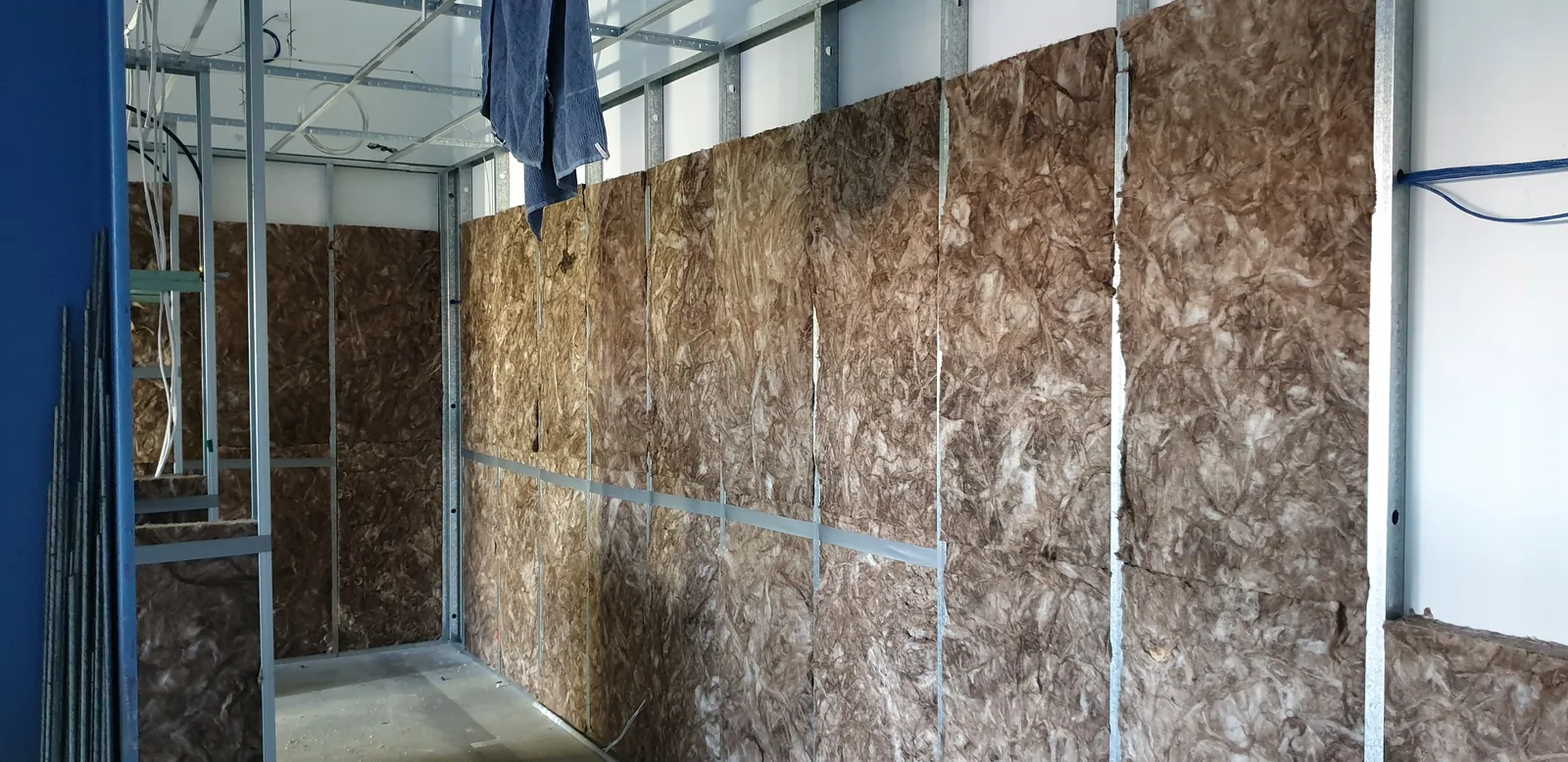

02912 Nov 2019

Insulation being fitted between the wall studs.

Insulation added around a corner of the new rooms.
03012 Nov 2019

Insulation added around a corner of the new rooms.

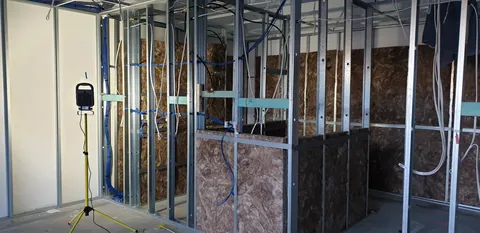

The partly insulated partitions and the remaining open framework.
03112 Nov 2019

The partly insulated partitions and the remaining open framework.

The insulation work progressing across the framed rooms.
03213 Nov 2019

The insulation work progressing across the framed rooms.

05Insulation and Opening Soon frontage

A closer view of insulation within the vertical wall framing.
03313 Nov 2019

A closer view of insulation within the vertical wall framing.

Insulation and service runs before the wall lining covers them.
03413 Nov 2019

Insulation and service runs before the wall lining covers them.

A service connection within the open partition.
03513 Nov 2019

A service connection within the open partition.

The workshop walls filled with insulation before plasterboard.
03613 Nov 2019

The workshop walls filled with insulation before plasterboard.

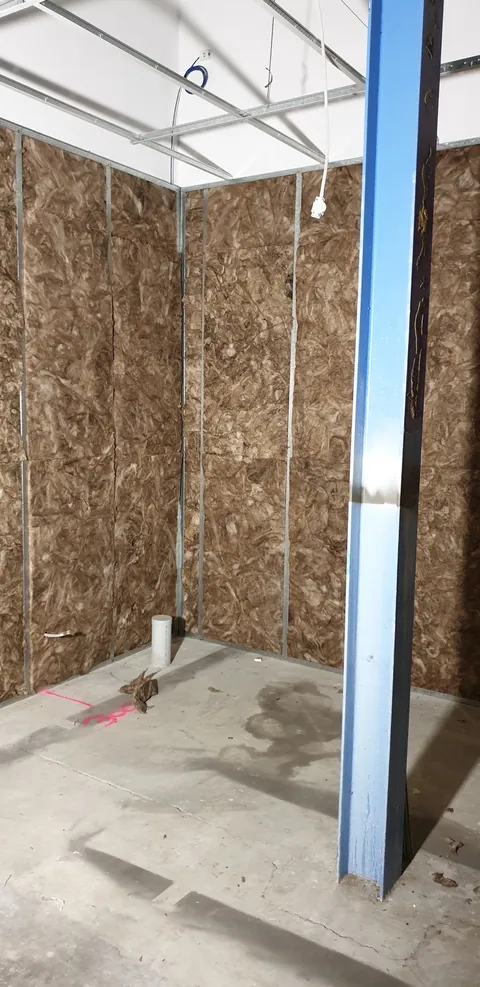

The framed doorway between the insulated rooms.
03713 Nov 2019

The framed doorway between the insulated rooms.

Service routes through the insulated wall.
03813 Nov 2019

Service routes through the insulated wall.

A close view of the blue service lines and horizontal bracing.
03913 Nov 2019

A close view of the blue service lines and horizontal bracing.

Overhead cables above the new partitions.
04013 Nov 2019

Overhead cables above the new partitions.

The insulated workshop during the last stages before lining.
04113 Nov 2019

The insulated workshop during the last stages before lining.

The insulated room viewed through its framed doorway.
04213 Nov 2019

The insulated room viewed through its framed doorway.

The future retail area with construction tools and materials still out.
04313 Nov 2019

The future retail area with construction tools and materials still out.

The shop lit from within during the evening build.
04413 Nov 2019

The shop lit from within during the evening build.

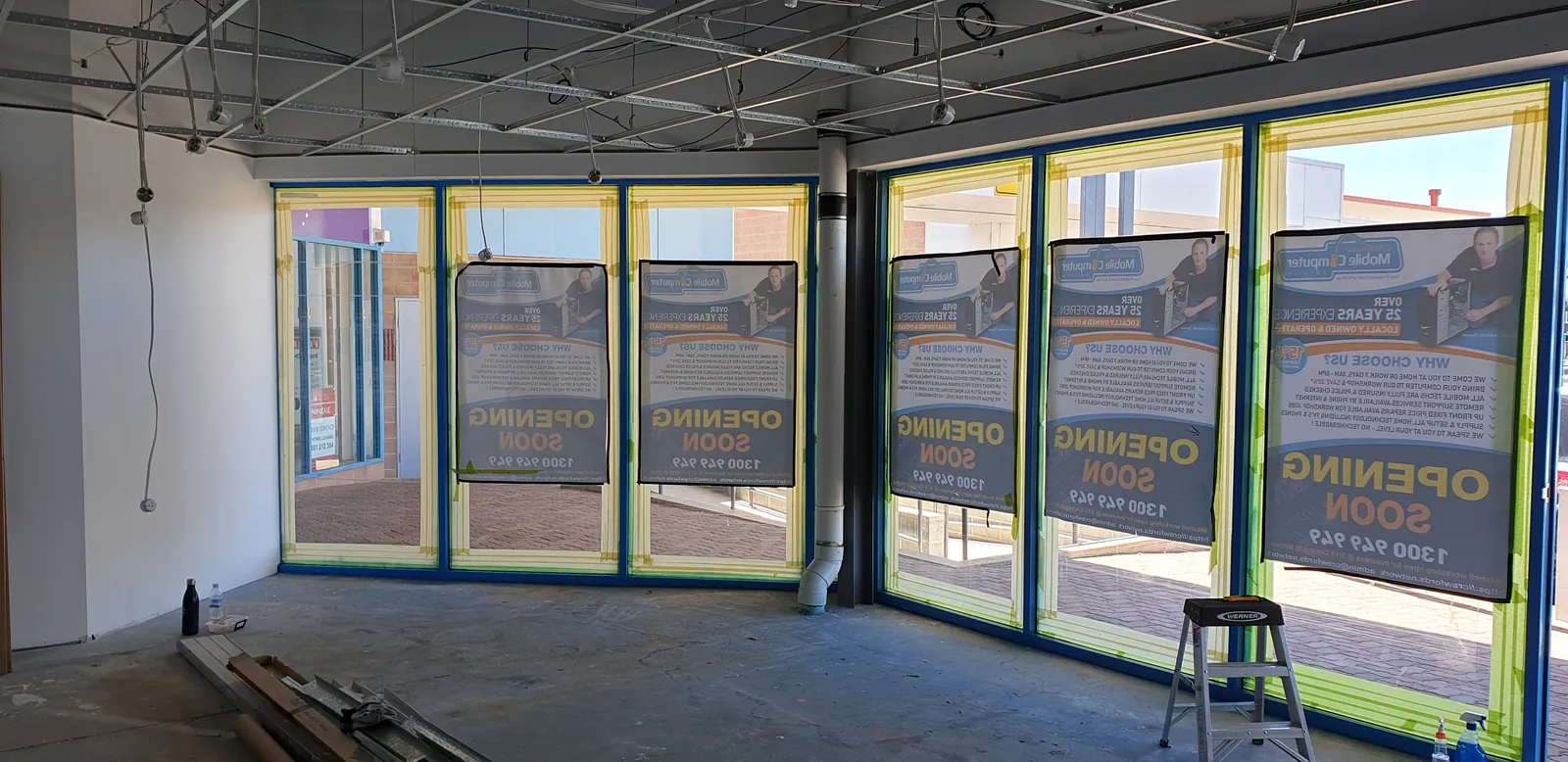

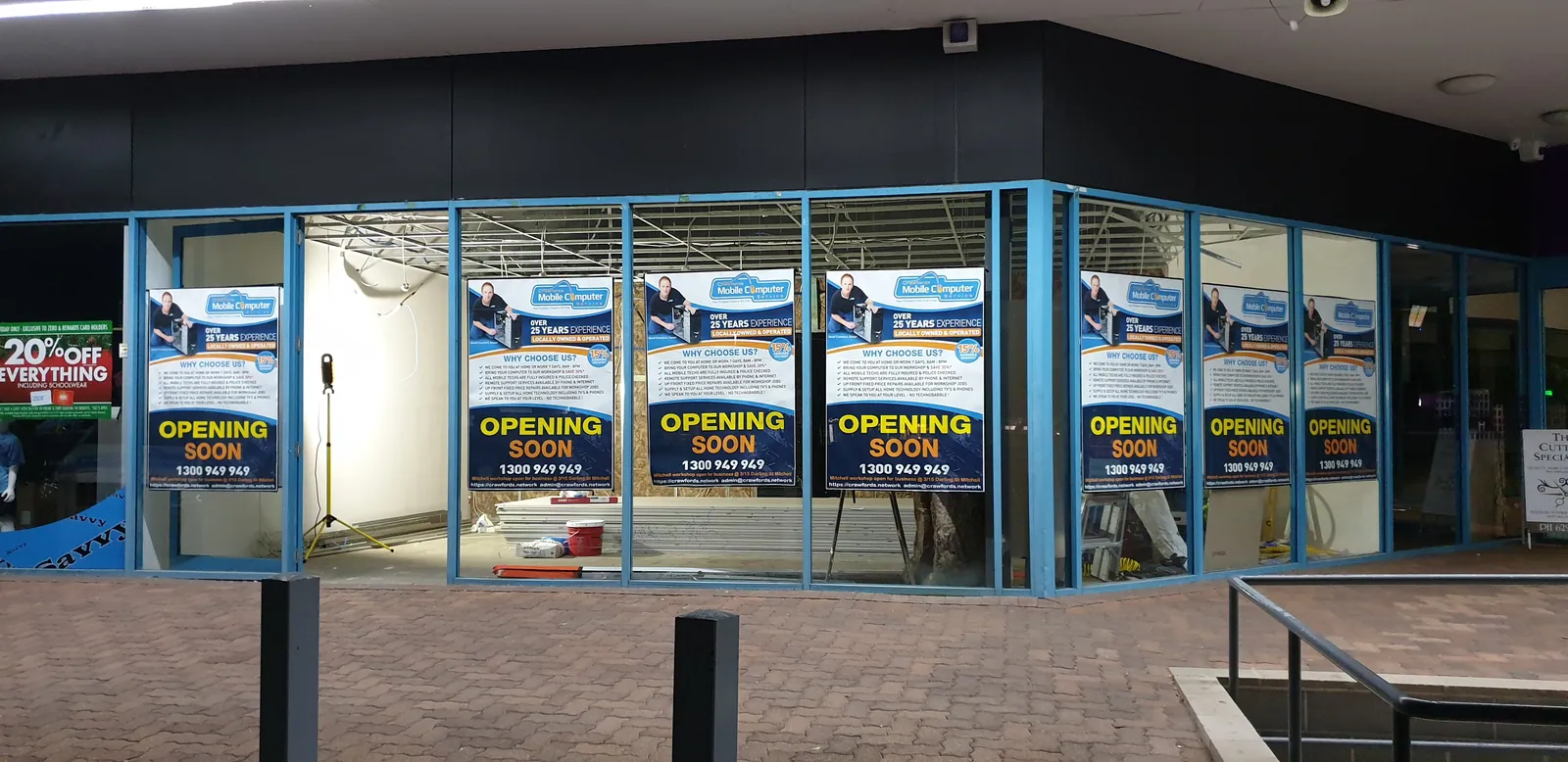

Opening Soon signs across the shopfront windows.

04513 Nov 2019

Opening Soon signs across the shopfront windows.

The illuminated corner shopfront as the interior takes shape.
04613 Nov 2019

The illuminated corner shopfront as the interior takes shape.

The new partition and doorway seen from the retail area.
04713 Nov 2019

The new partition and doorway seen from the retail area.

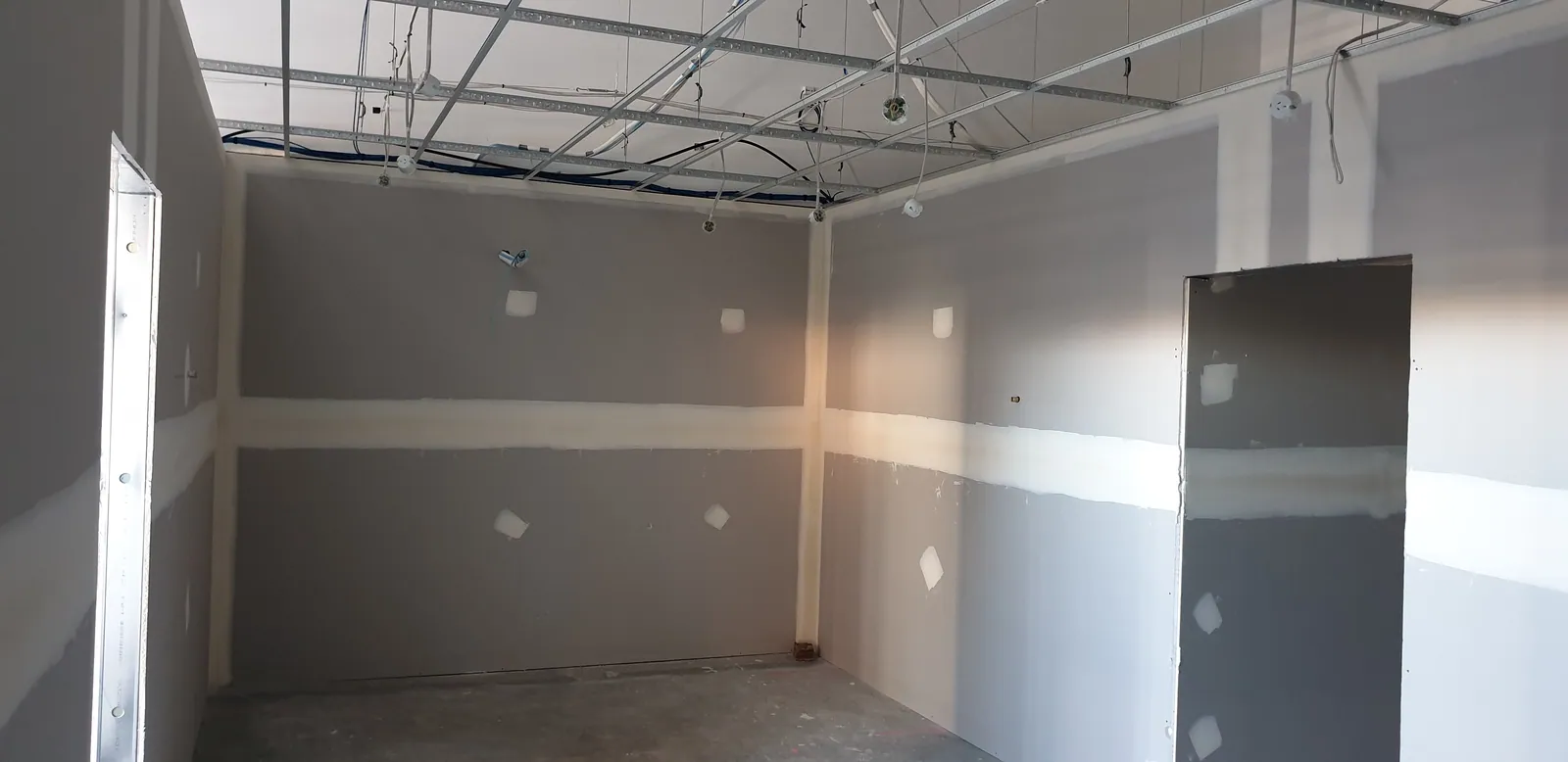

06Plasterboard lining

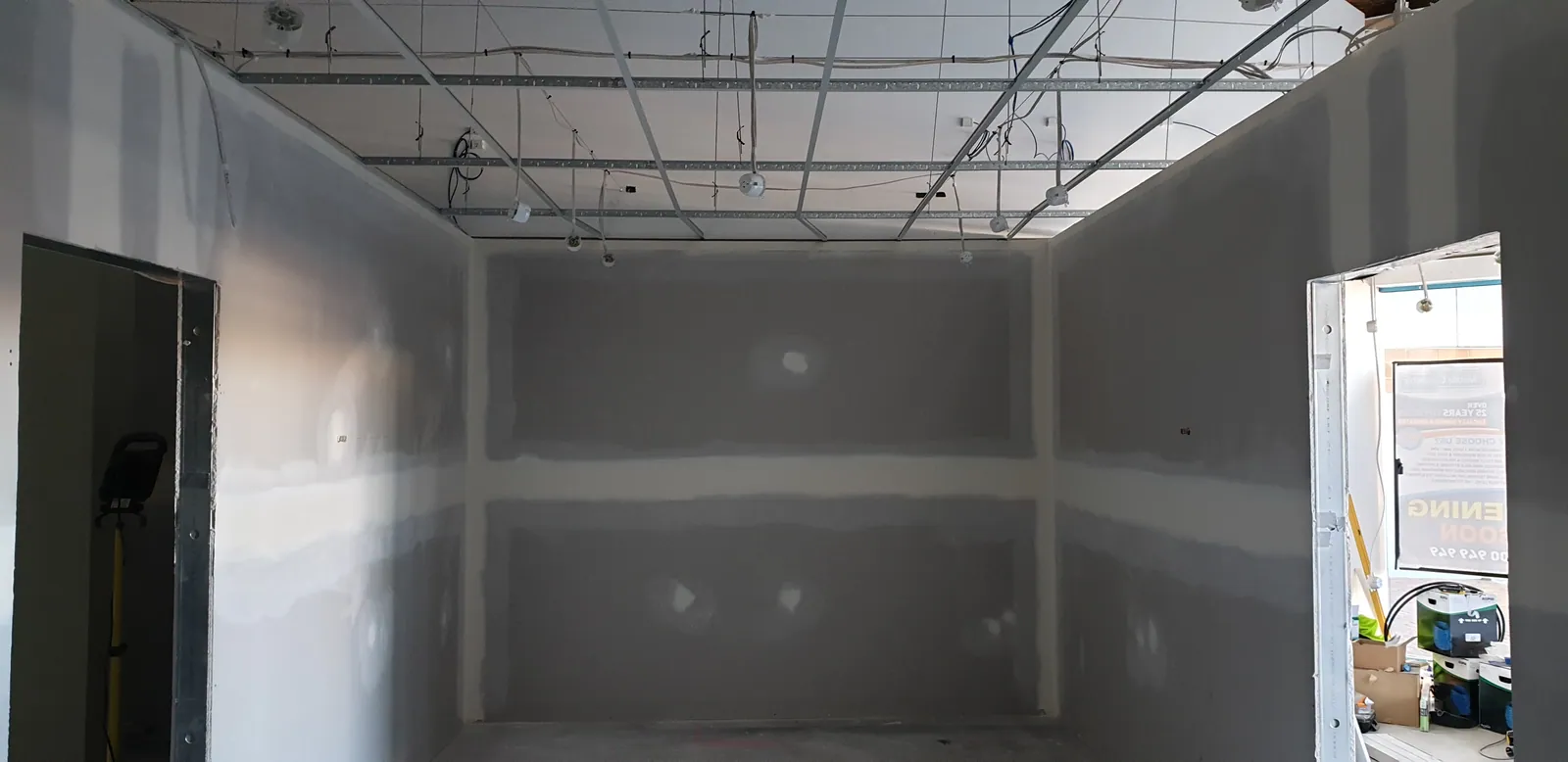

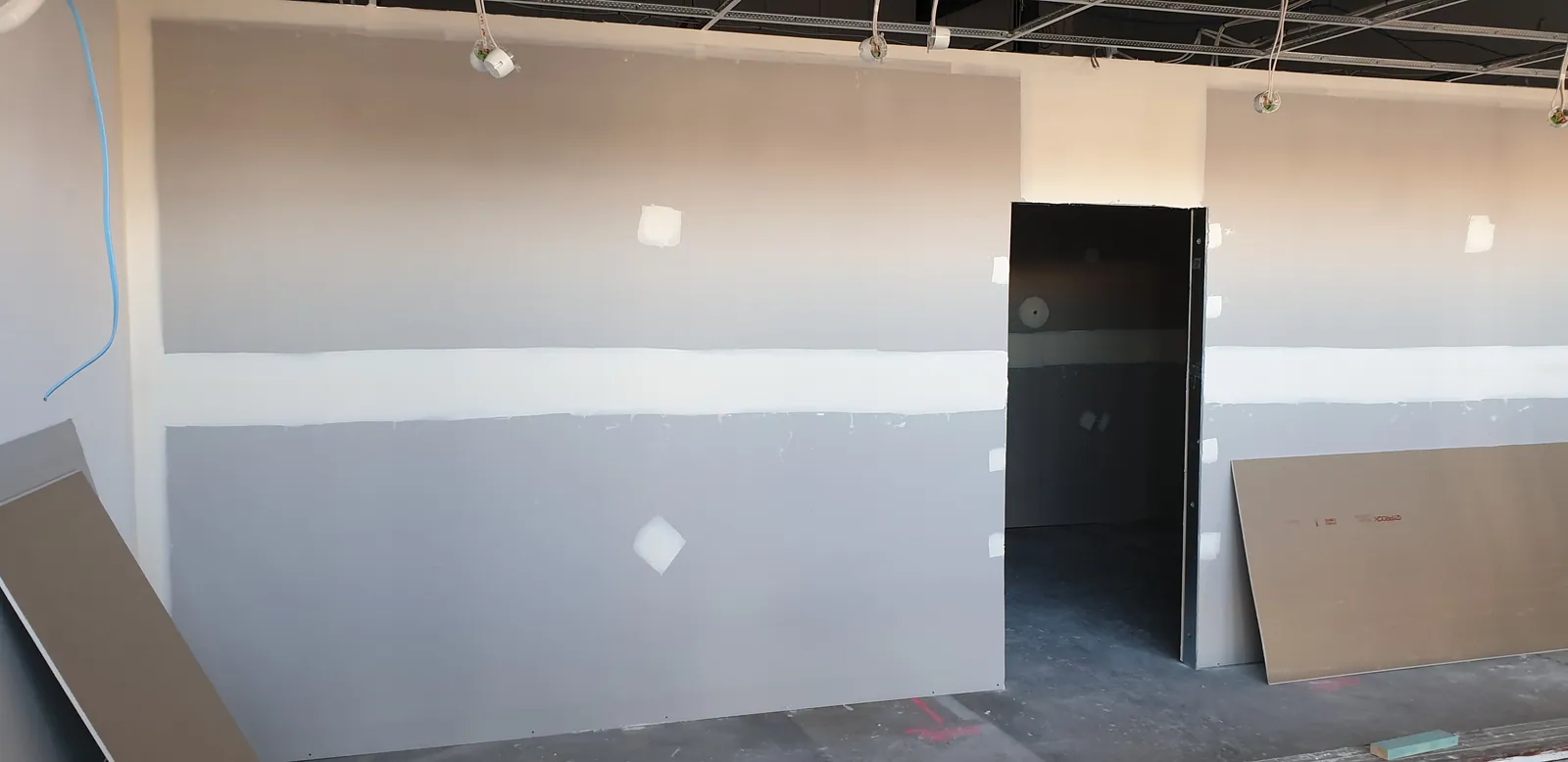

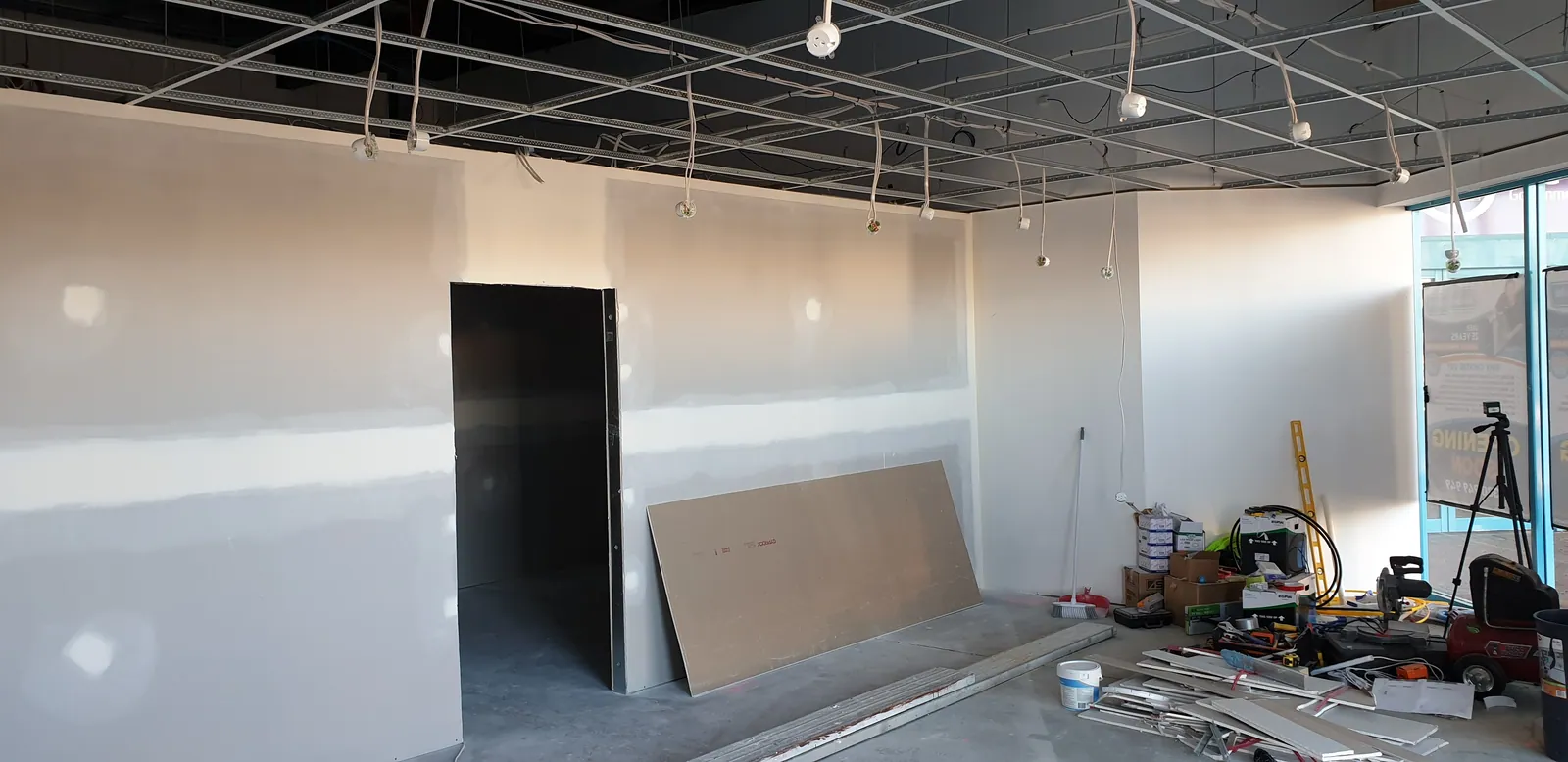

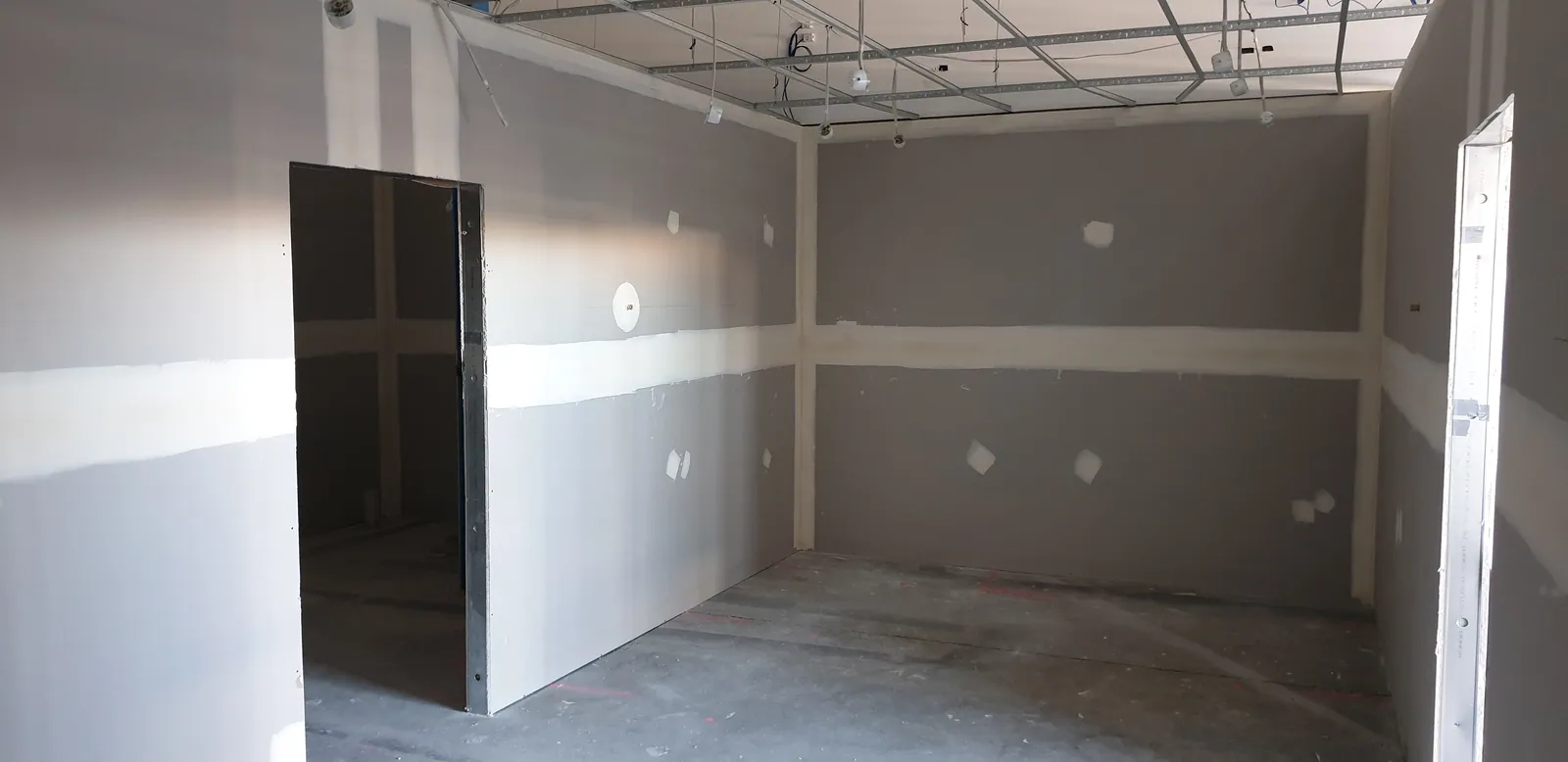

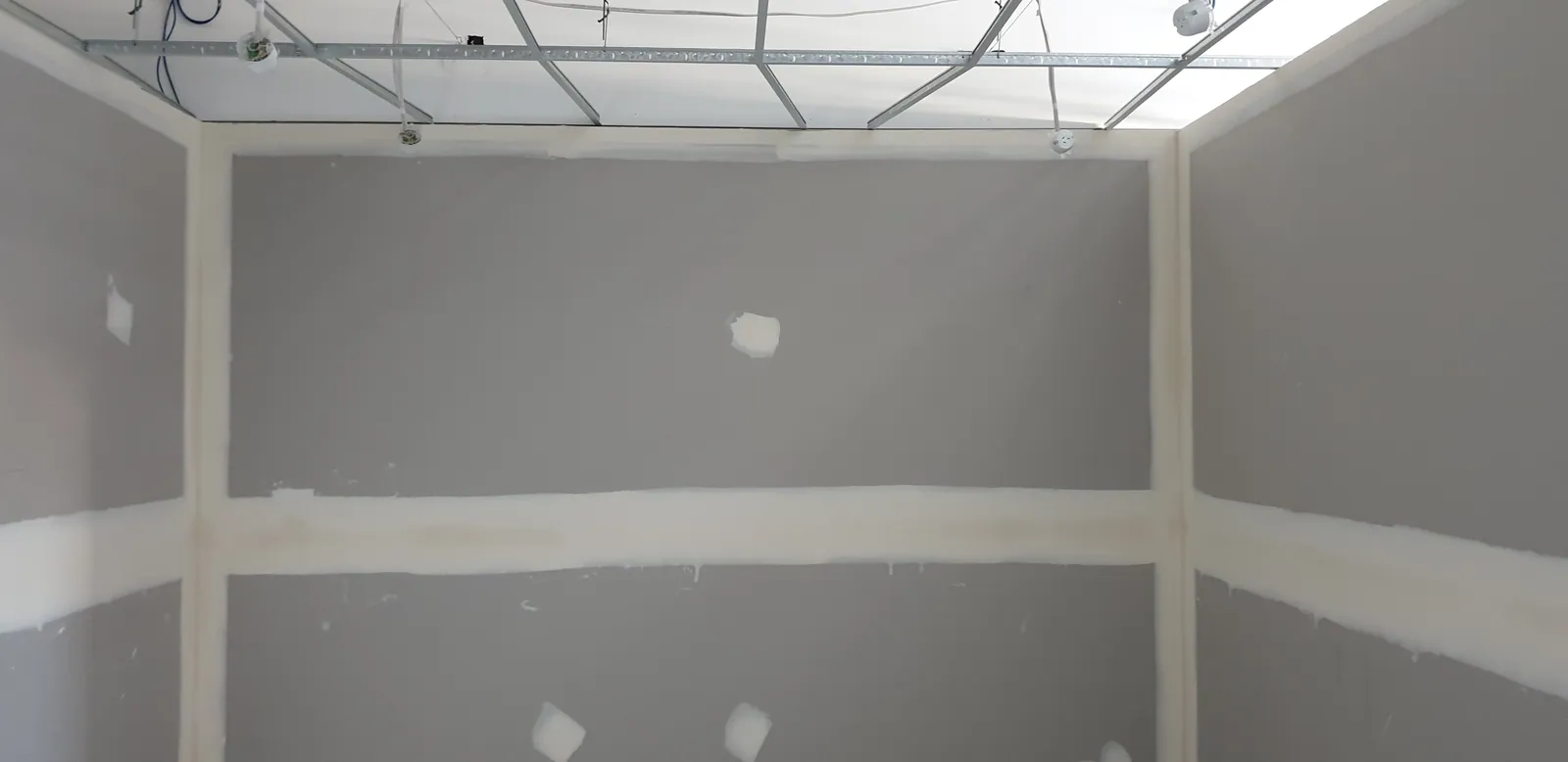

Plasterboard now covers the partition walls.
04814 Nov 2019

Plasterboard now covers the partition walls.

The retail area with newly lined walls and the ceiling grid above.
04914 Nov 2019

The retail area with newly lined walls and the ceiling grid above.

Inside the workshop after the wall lining has been fitted.
05014 Nov 2019

Inside the workshop after the wall lining has been fitted.

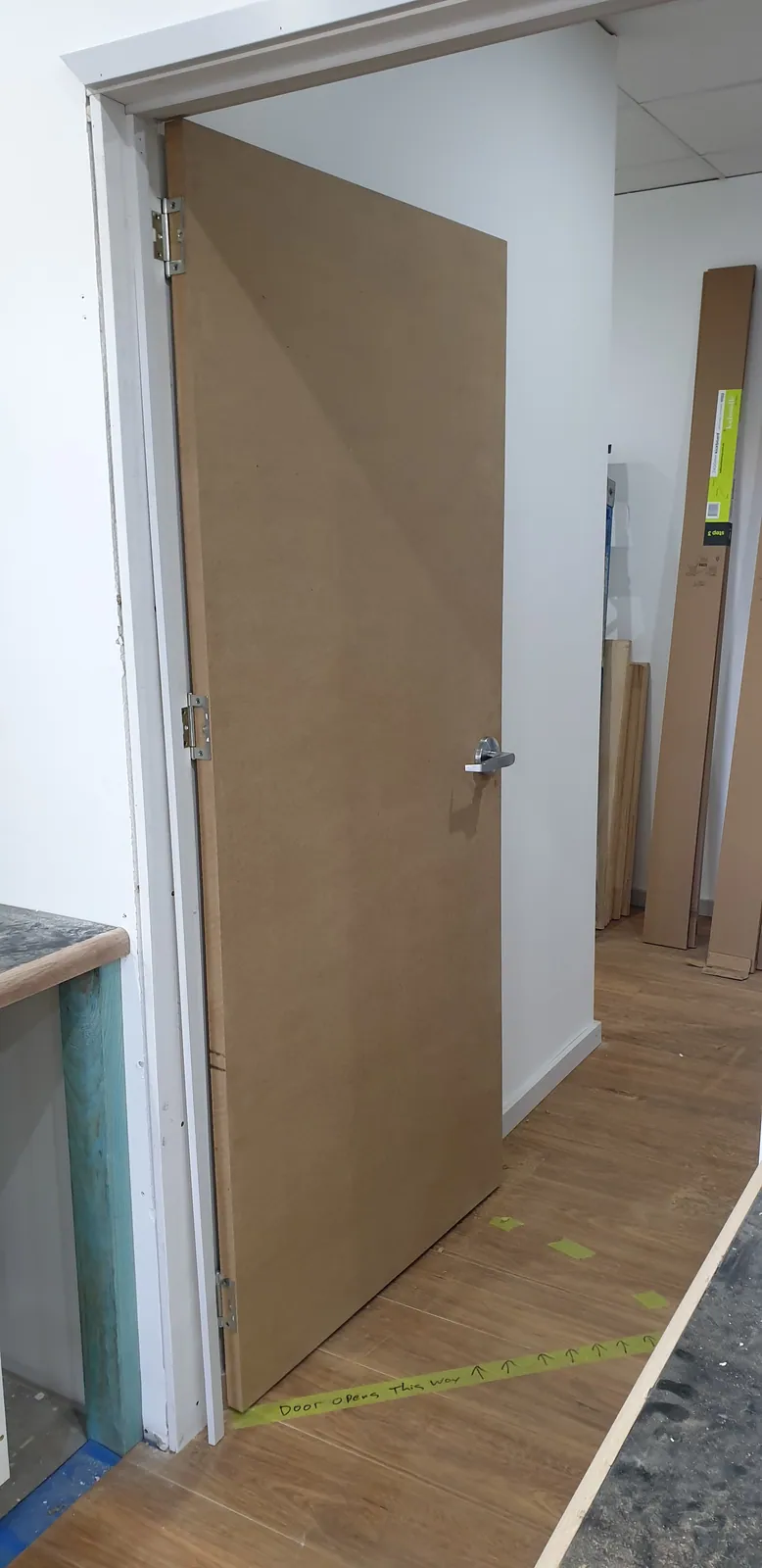

A new internal doorway in the lined partitions.
05114 Nov 2019

A new internal doorway in the lined partitions.

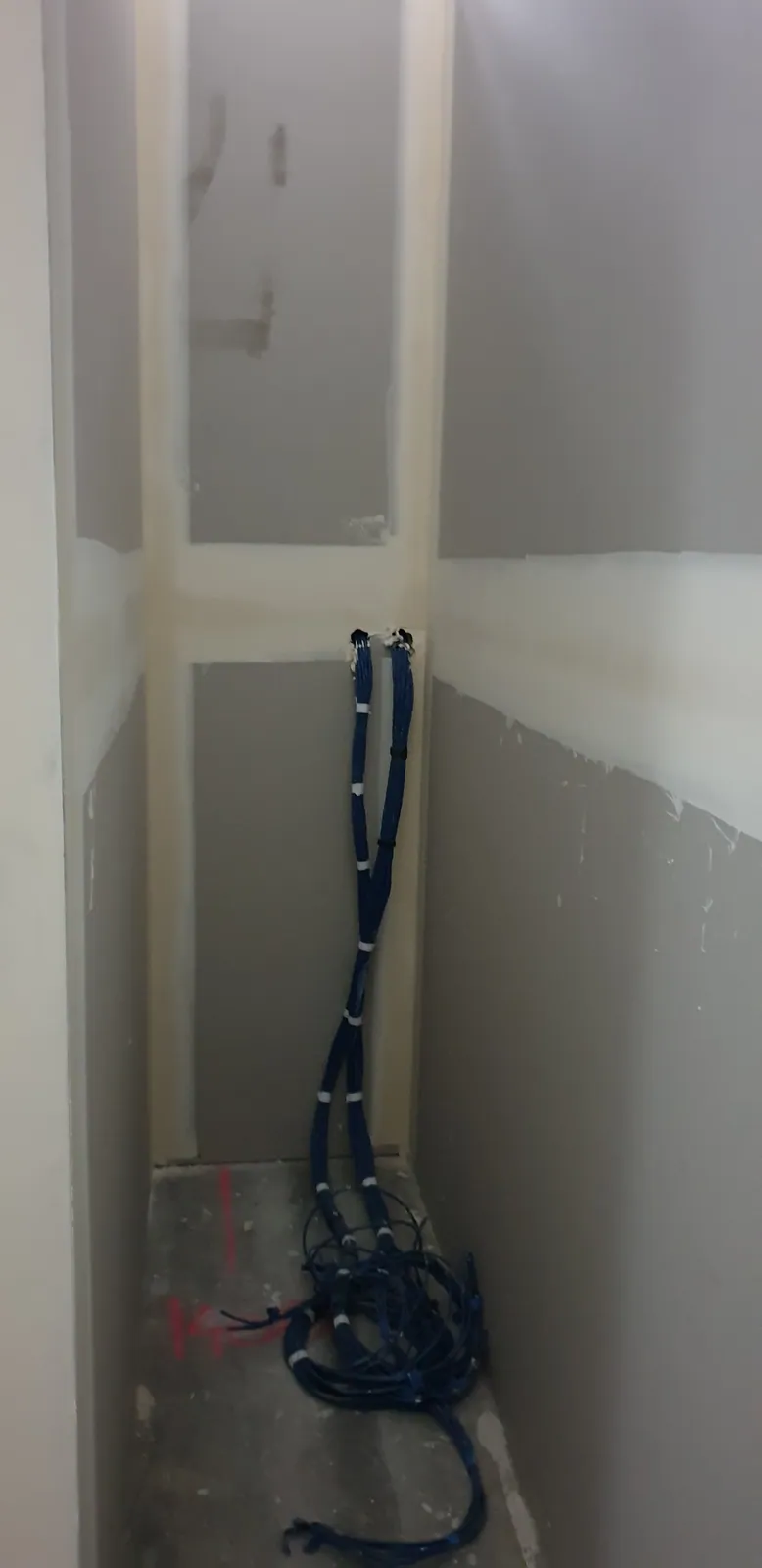

A small service area left accessible during the fit-out.
05214 Nov 2019

A small service area left accessible during the fit-out.

Looking towards the front windows from the newly lined shop.
05314 Nov 2019

Looking towards the front windows from the newly lined shop.

Service outlets emerging through the workshop wall lining.
05414 Nov 2019

Service outlets emerging through the workshop wall lining.

The workshop after the first wall-lining stage.
05514 Nov 2019

The workshop after the first wall-lining stage.

The newly lined passage between the rooms.
05615 Nov 2019

The newly lined passage between the rooms.

The workshop viewed back towards its entrance.
05715 Nov 2019

The workshop viewed back towards its entrance.

The lined workshop with tools and ladders ready for finishing.
05815 Nov 2019

The lined workshop with tools and ladders ready for finishing.

The retail space with the internal walls now enclosed.
05915 Nov 2019

The retail space with the internal walls now enclosed.

07Painting

Painting begins on the retail walls.

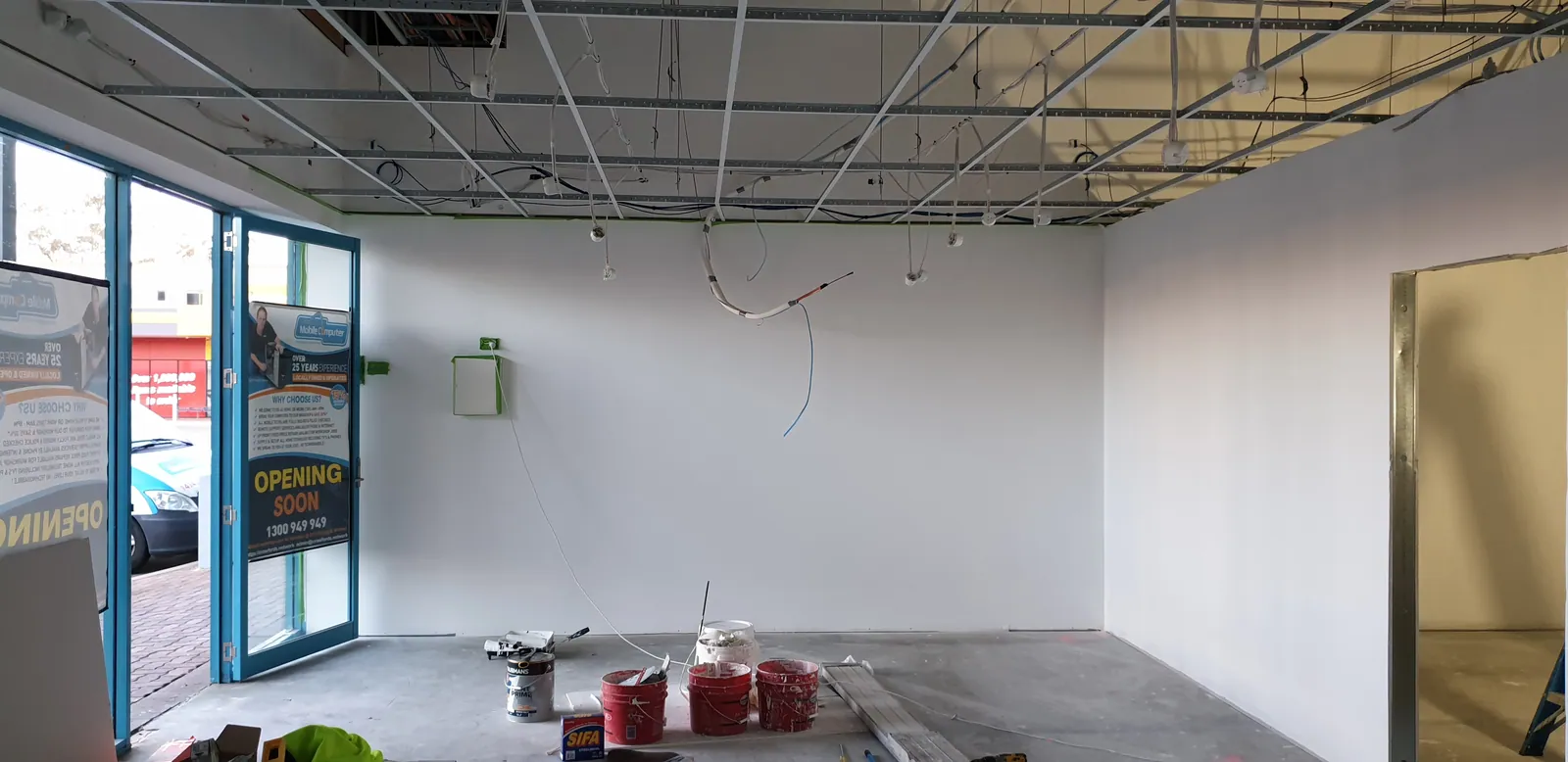

06017 Nov 2019

Painting begins on the retail walls.

Painted walls brighten the new rooms.
06117 Nov 2019

Painted walls brighten the new rooms.

Painting continues around the workshop.
06217 Nov 2019

Painting continues around the workshop.

The painted internal passage.
06317 Nov 2019

The painted internal passage.

The retail walls after another evening of painting.
06418 Nov 2019

The retail walls after another evening of painting.

The workshop with painted walls and ladders still in use.
06518 Nov 2019

The workshop with painted walls and ladders still in use.

The painted retail area in daylight.
06619 Nov 2019

The painted retail area in daylight.

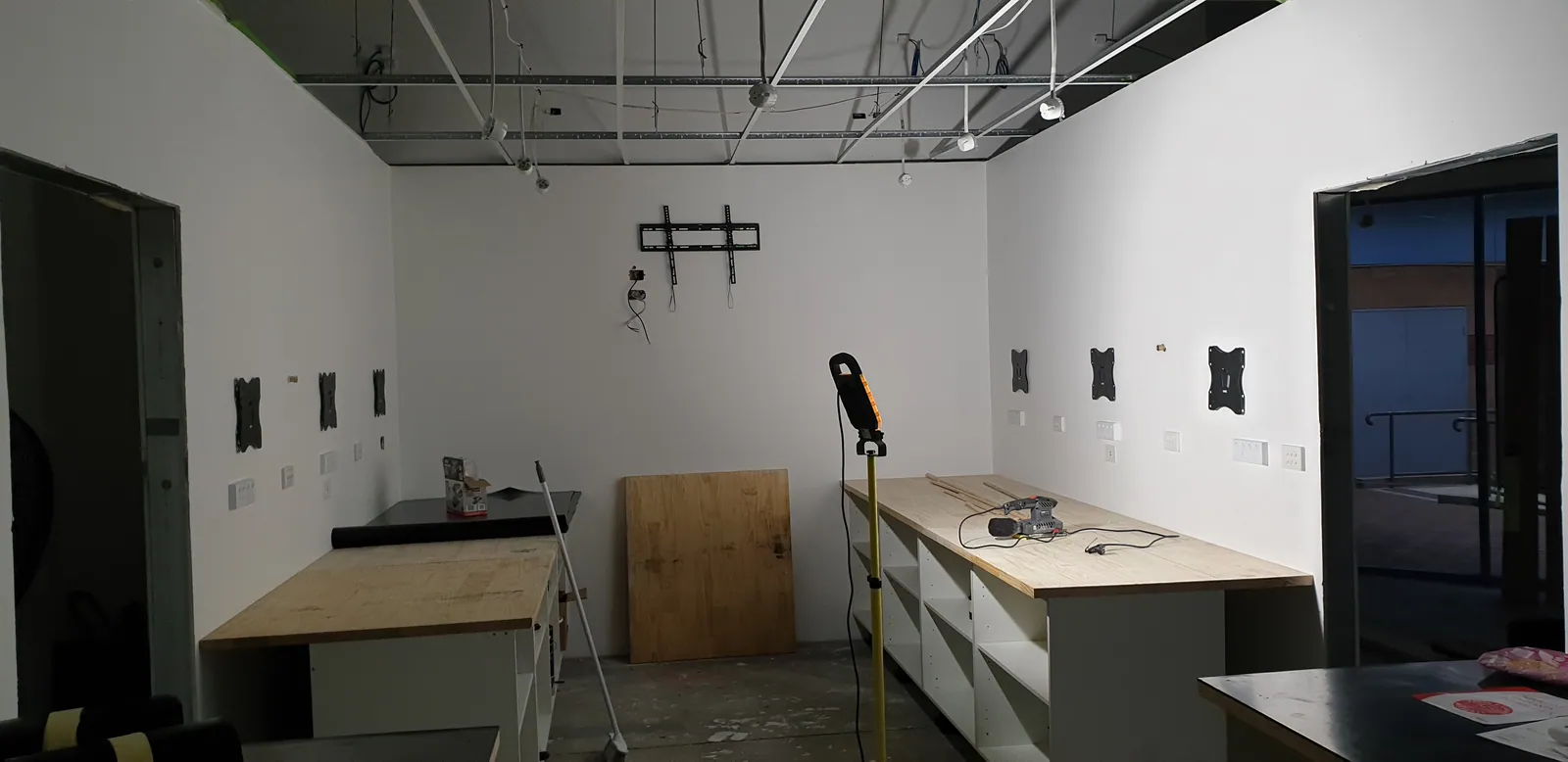

08Screen mounts and network cabinet

Wall mounts being aligned for the workshop screens.
06719 Nov 2019

Wall mounts being aligned for the workshop screens.

Screen mounts fitted around the workshop walls.
06819 Nov 2019

Screen mounts fitted around the workshop walls.

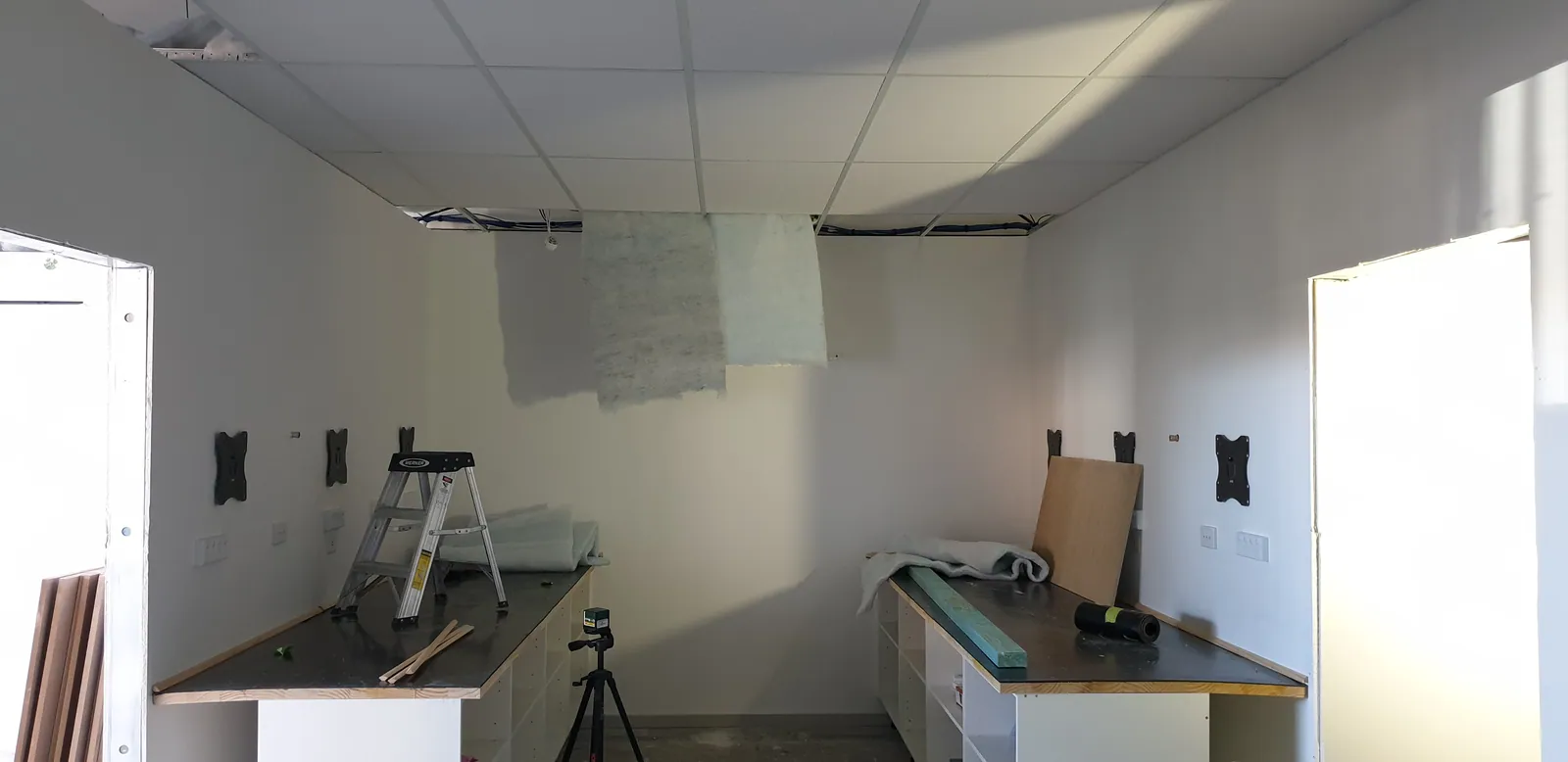

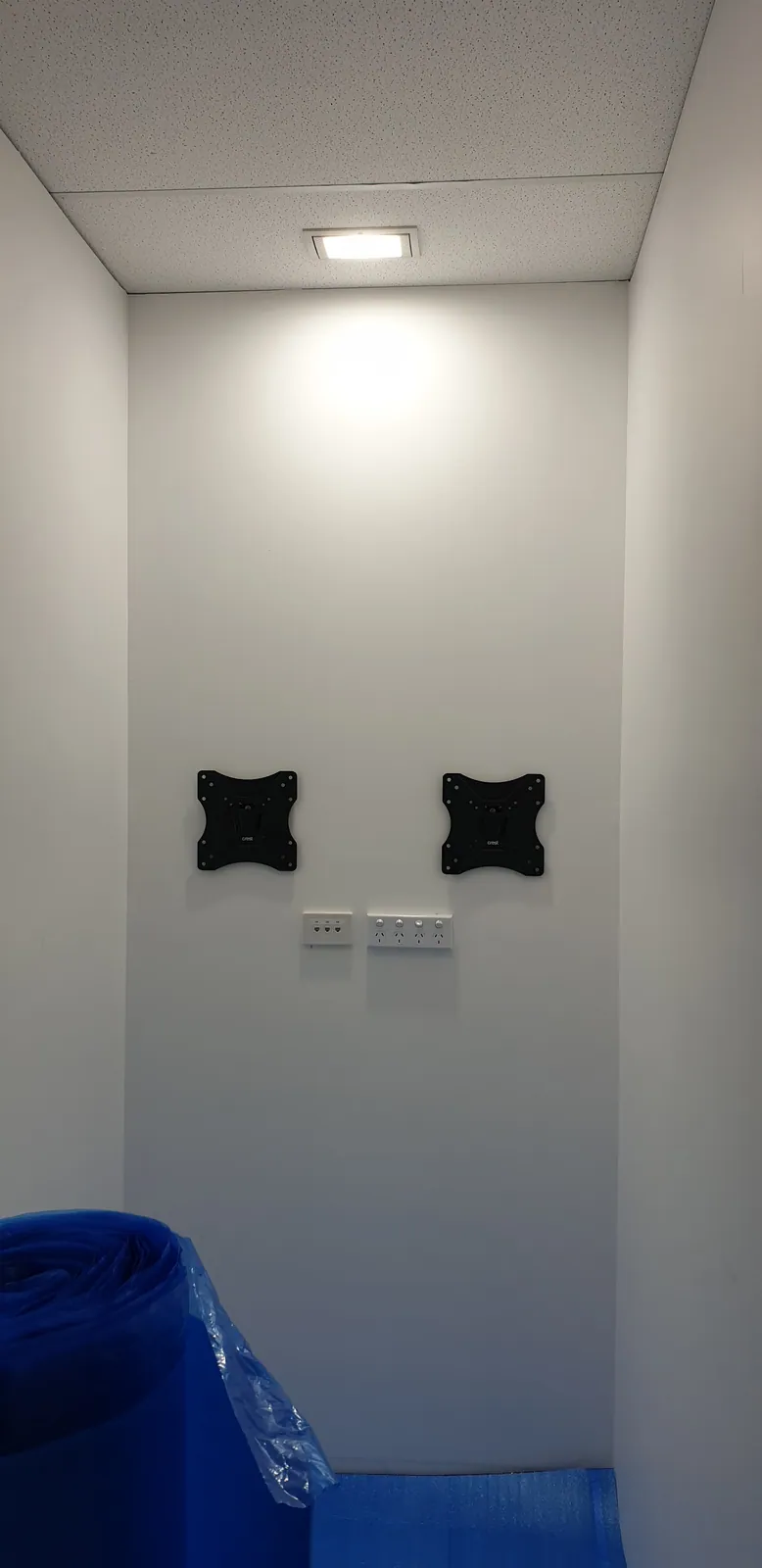

Two screen mounts prepared in a smaller work area.
06919 Nov 2019

Two screen mounts prepared in a smaller work area.

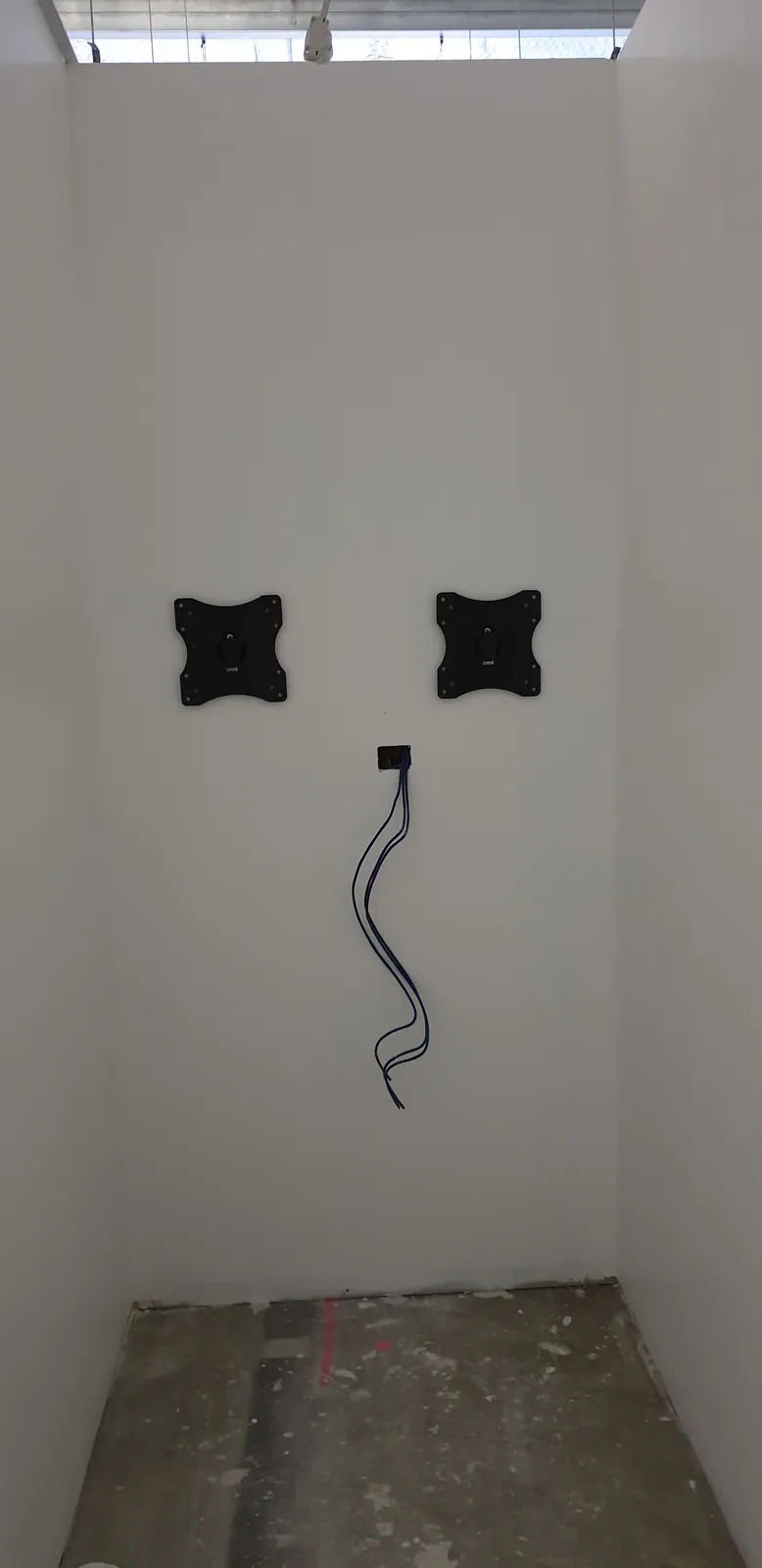

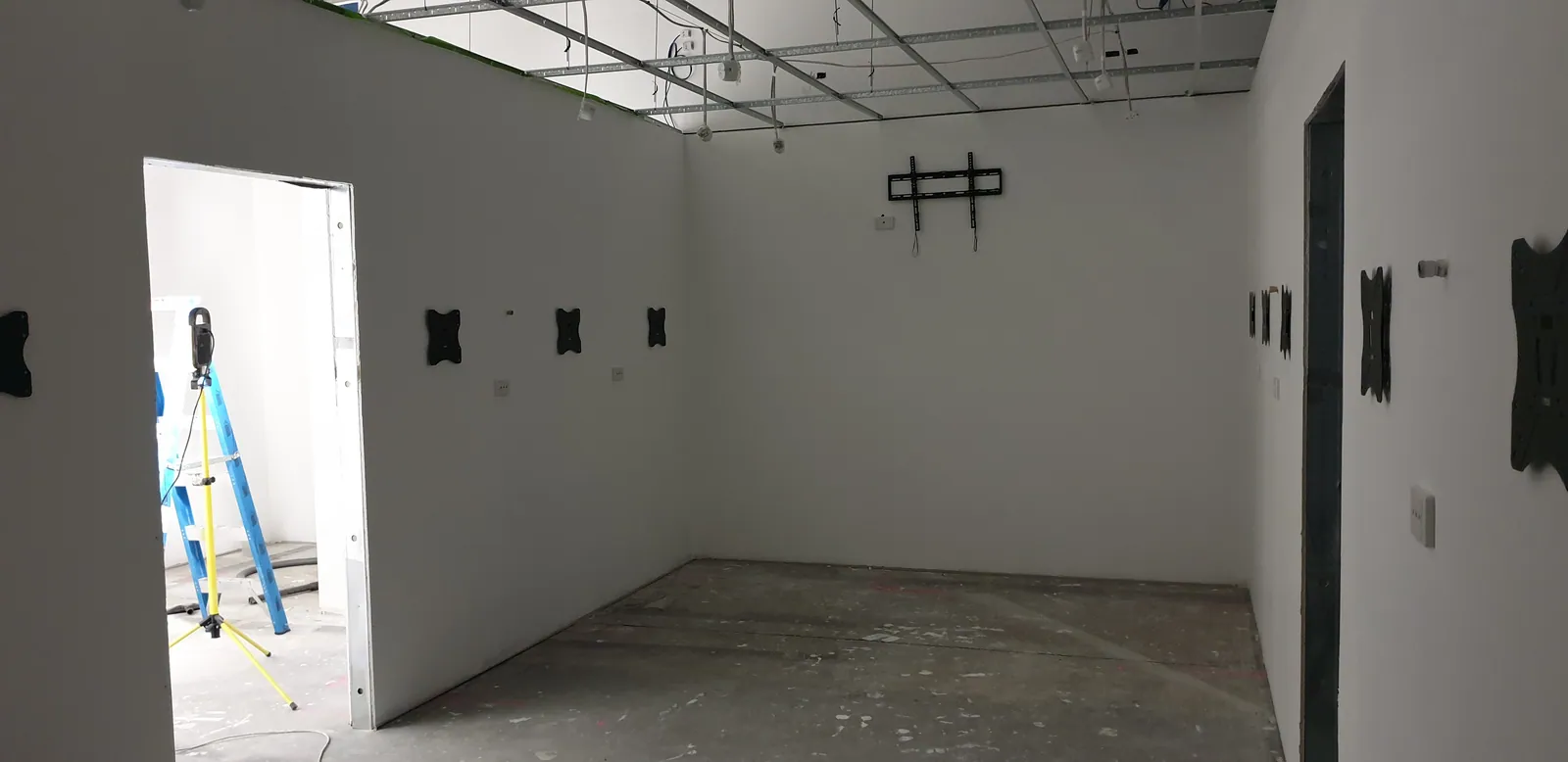

The workshop with the screen positions established.

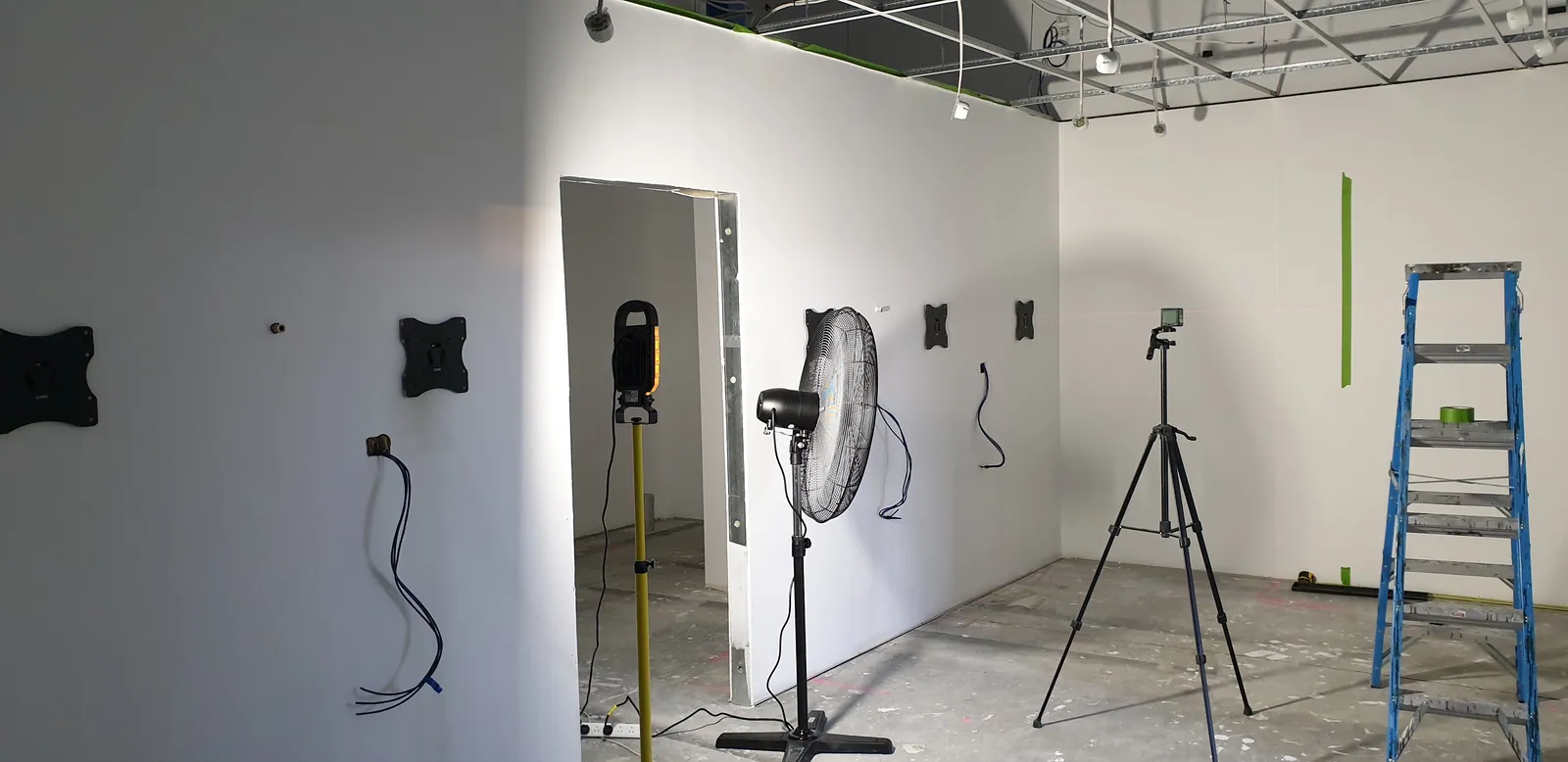

07020 Nov 2019

The workshop with the screen positions established.

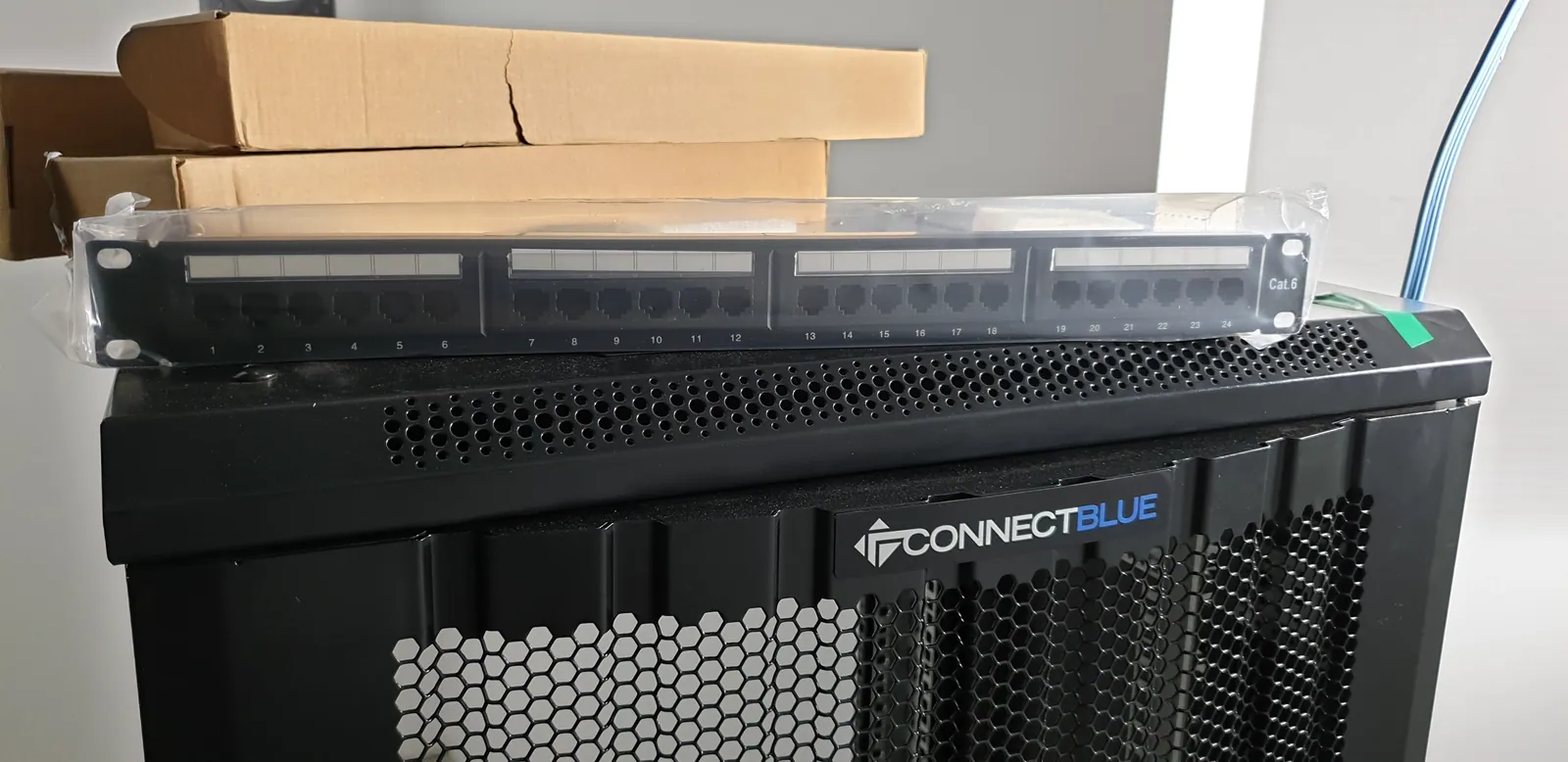

The network cabinet brought into the new premises.
07121 Nov 2019

The network cabinet brought into the new premises.

Network hardware being prepared above the new cabinet.
07221 Nov 2019

Network hardware being prepared above the new cabinet.

Workshop screen mounts above the next delivery of cabinetry.
07321 Nov 2019

Workshop screen mounts above the next delivery of cabinetry.

Cabinet parts awaiting assembly in the workshop.
07421 Nov 2019

Cabinet parts awaiting assembly in the workshop.

A closer look inside the developing network cabinet.
07521 Nov 2019

A closer look inside the developing network cabinet.

Further network-cabinet wiring during the fit-out.
07622 Nov 2019

Further network-cabinet wiring during the fit-out.

09Cabinets, windows and worktops

The first base cabinets positioned along the workshop wall.

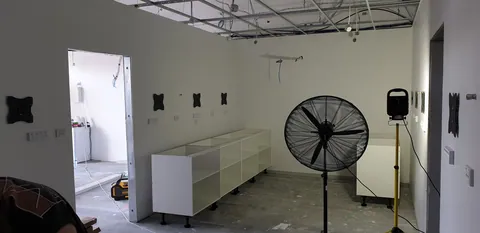

07724 Nov 2019

The first base cabinets positioned along the workshop wall.

Base cabinets taking shape on the opposite side.
07824 Nov 2019

Base cabinets taking shape on the opposite side.

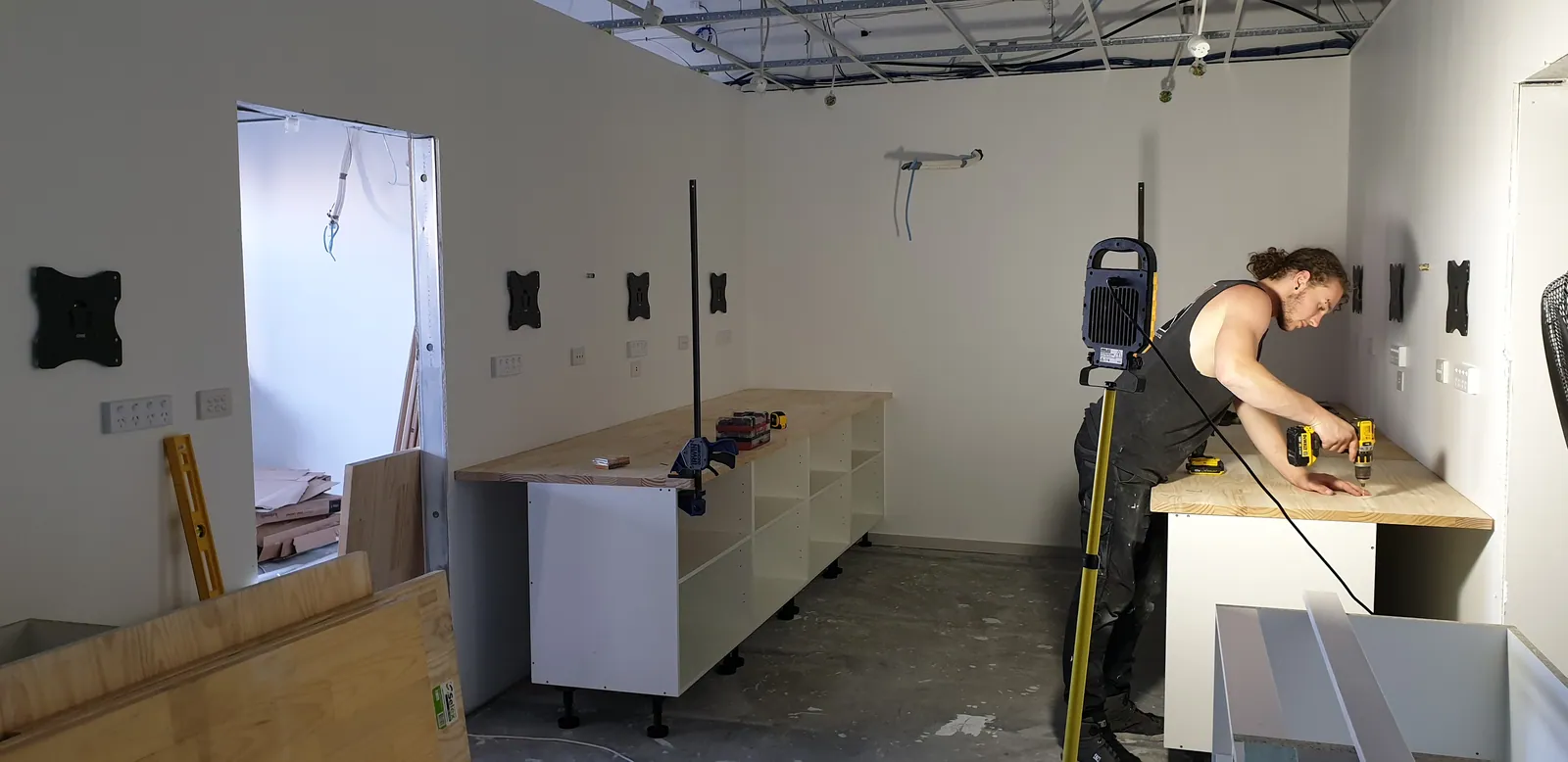

Measuring and assembling the workshop bench cabinetry.
07924 Nov 2019

Measuring and assembling the workshop bench cabinetry.

The cabinet layout viewed across the workshop.
08024 Nov 2019

The cabinet layout viewed across the workshop.

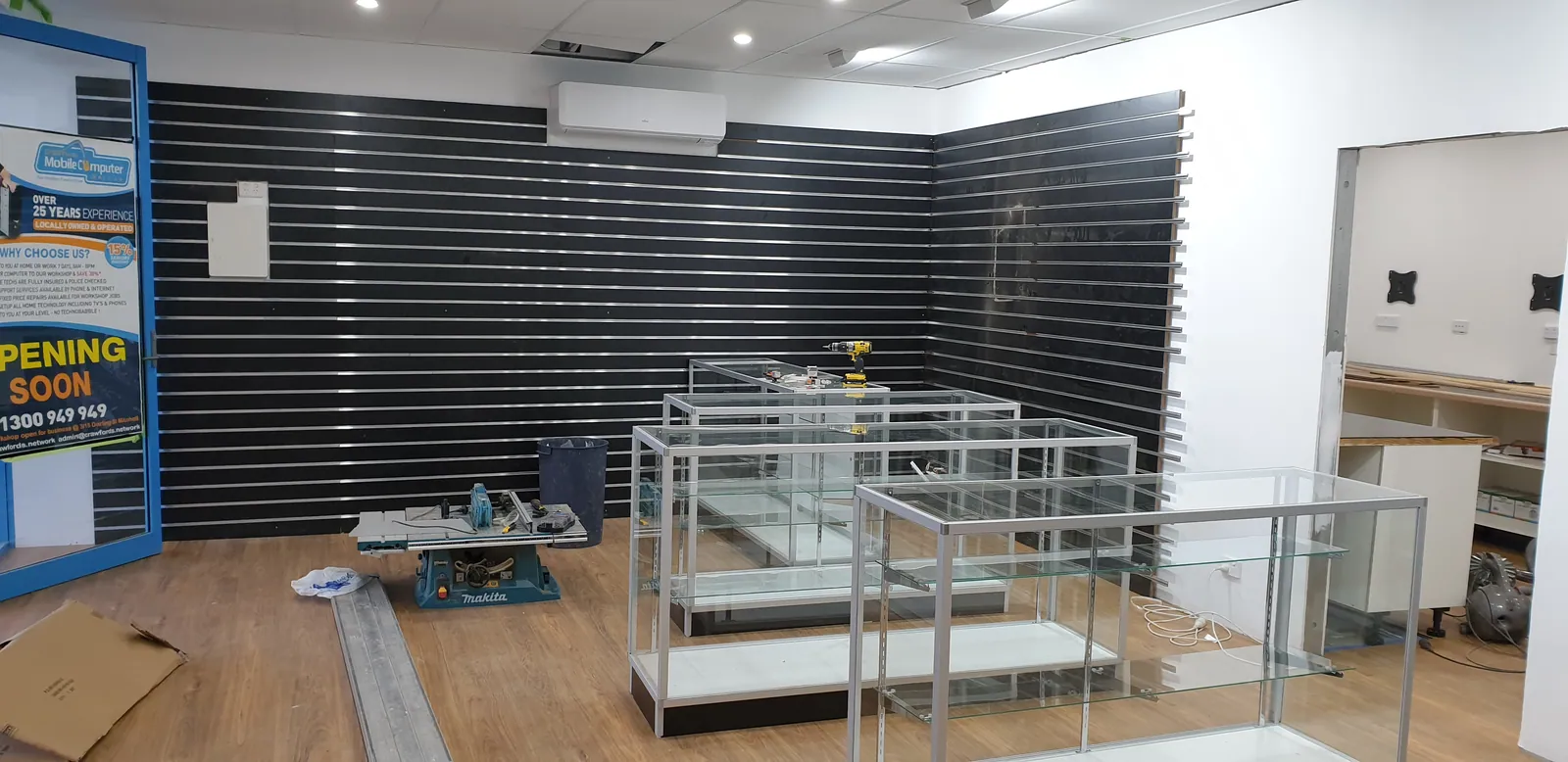

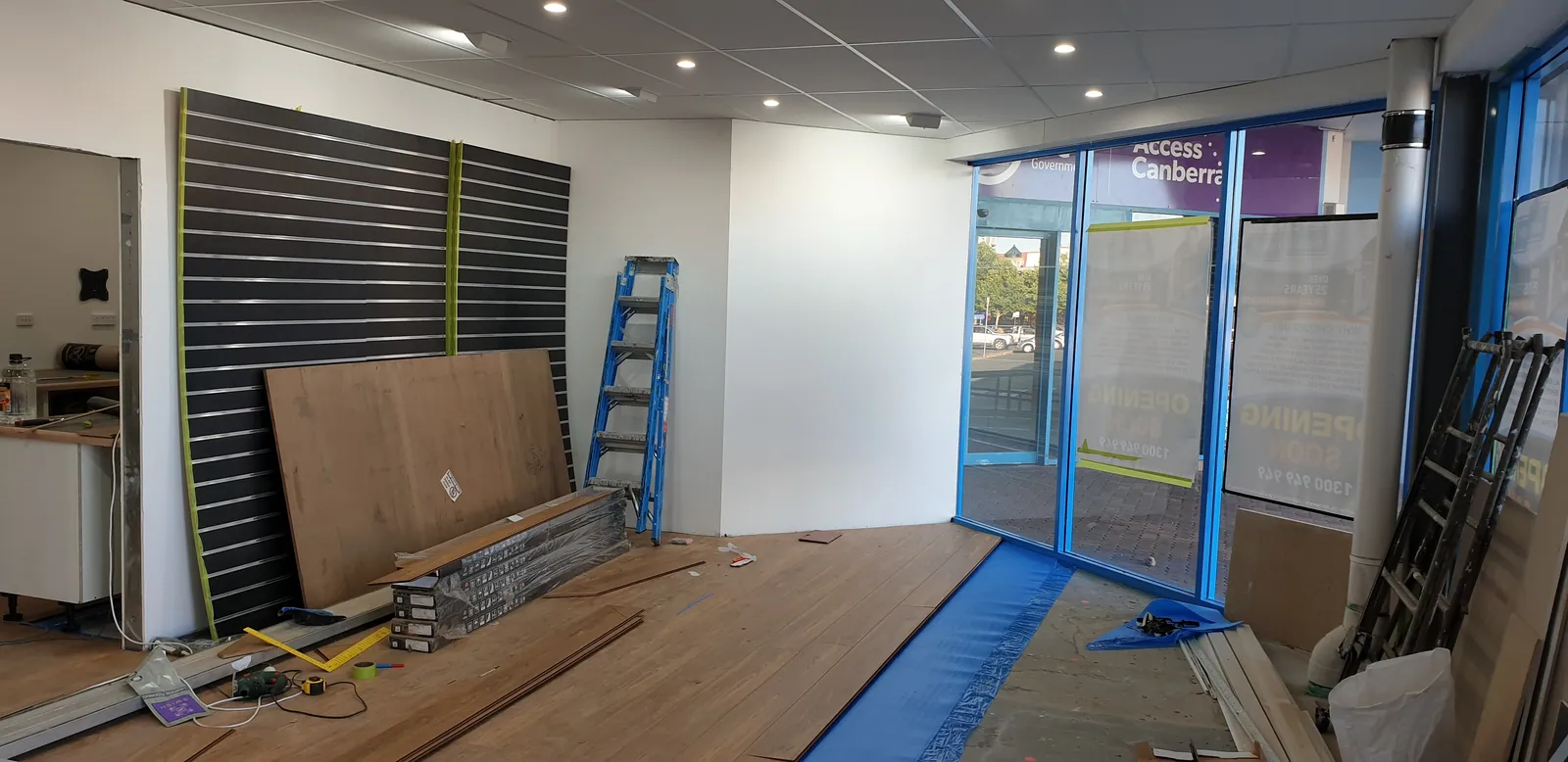

The front glazing masked in preparation for painting.
08125 Nov 2019

The front glazing masked in preparation for painting.

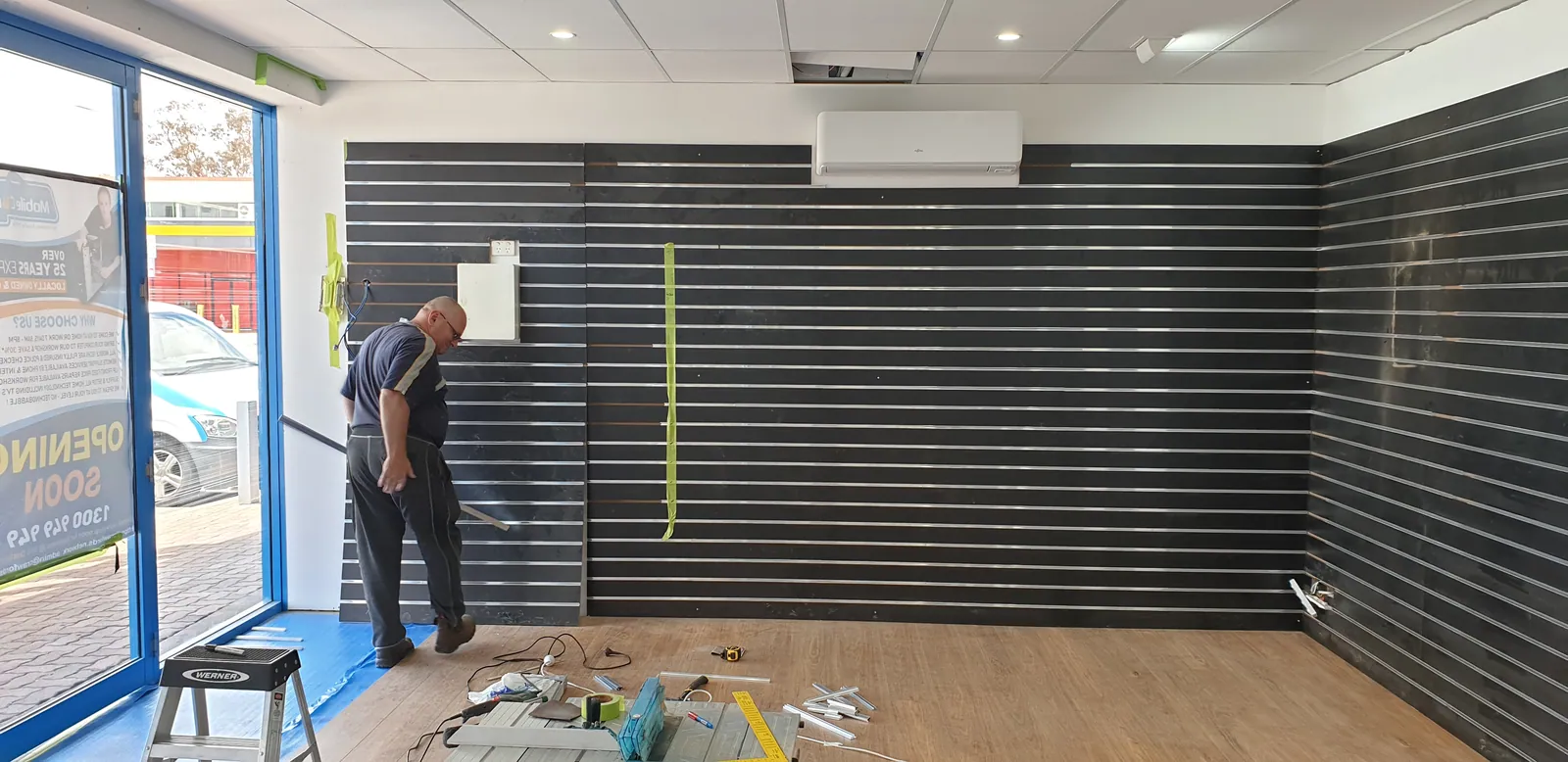

Work continues around the masked front windows.
08226 Nov 2019

Work continues around the masked front windows.

The workshop base cabinets before the benchtops are fitted.
08326 Nov 2019

The workshop base cabinets before the benchtops are fitted.

The opposing run of base cabinets and work area.
08426 Nov 2019

The opposing run of base cabinets and work area.

The Crawfords van outside the Opening Soon shopfront.
08526 Nov 2019

The Crawfords van outside the Opening Soon shopfront.

Materials and panels set out across the retail floor.
08627 Nov 2019

Materials and panels set out across the retail floor.

Looking towards the masked front glazing during the next finishing stage.

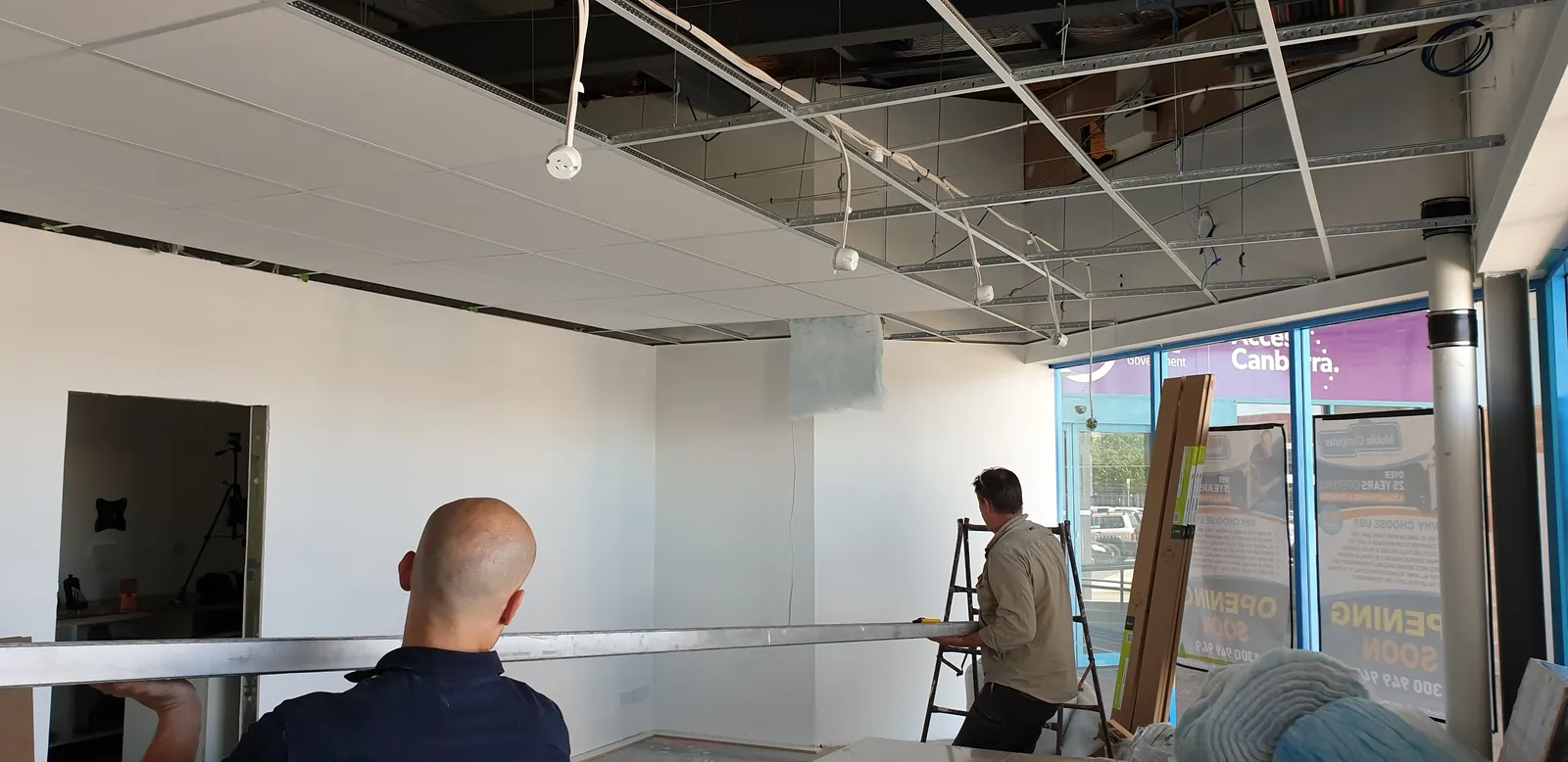

08727 Nov 2019

Looking towards the masked front glazing during the next finishing stage.

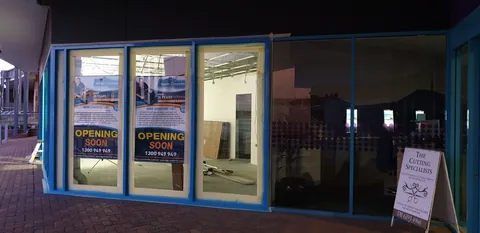

The illuminated shopfront after another evening of work.
08827 Nov 2019

The illuminated shopfront after another evening of work.

The front-window finishing work nearing completion.
08927 Nov 2019

The front-window finishing work nearing completion.

Benchtops fitted to the workshop base cabinets.
09027 Nov 2019

Benchtops fitted to the workshop base cabinets.

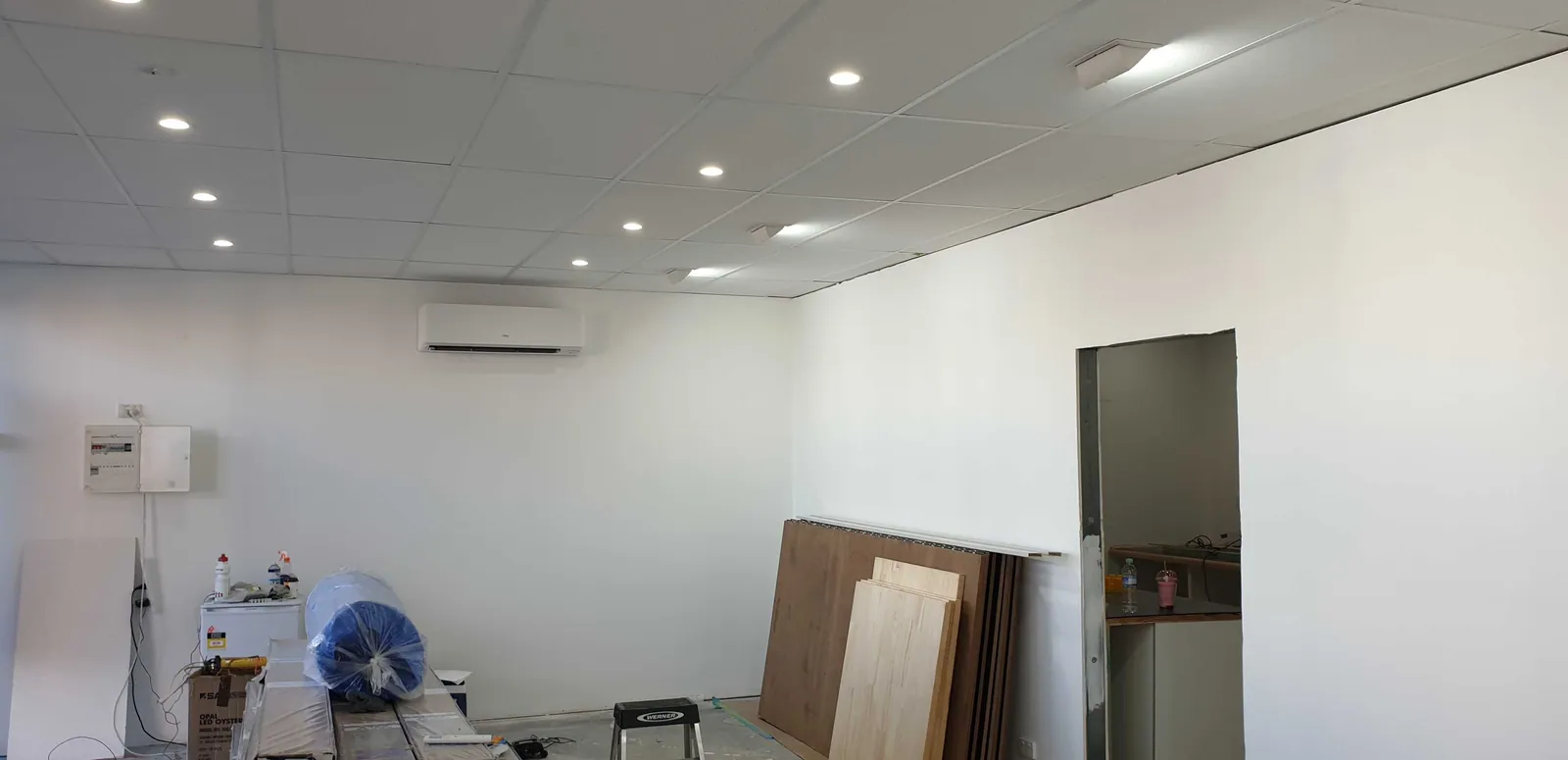

The opposing workbench and air conditioner during installation.
09127 Nov 2019

The opposing workbench and air conditioner during installation.

10Ceilings and lighting

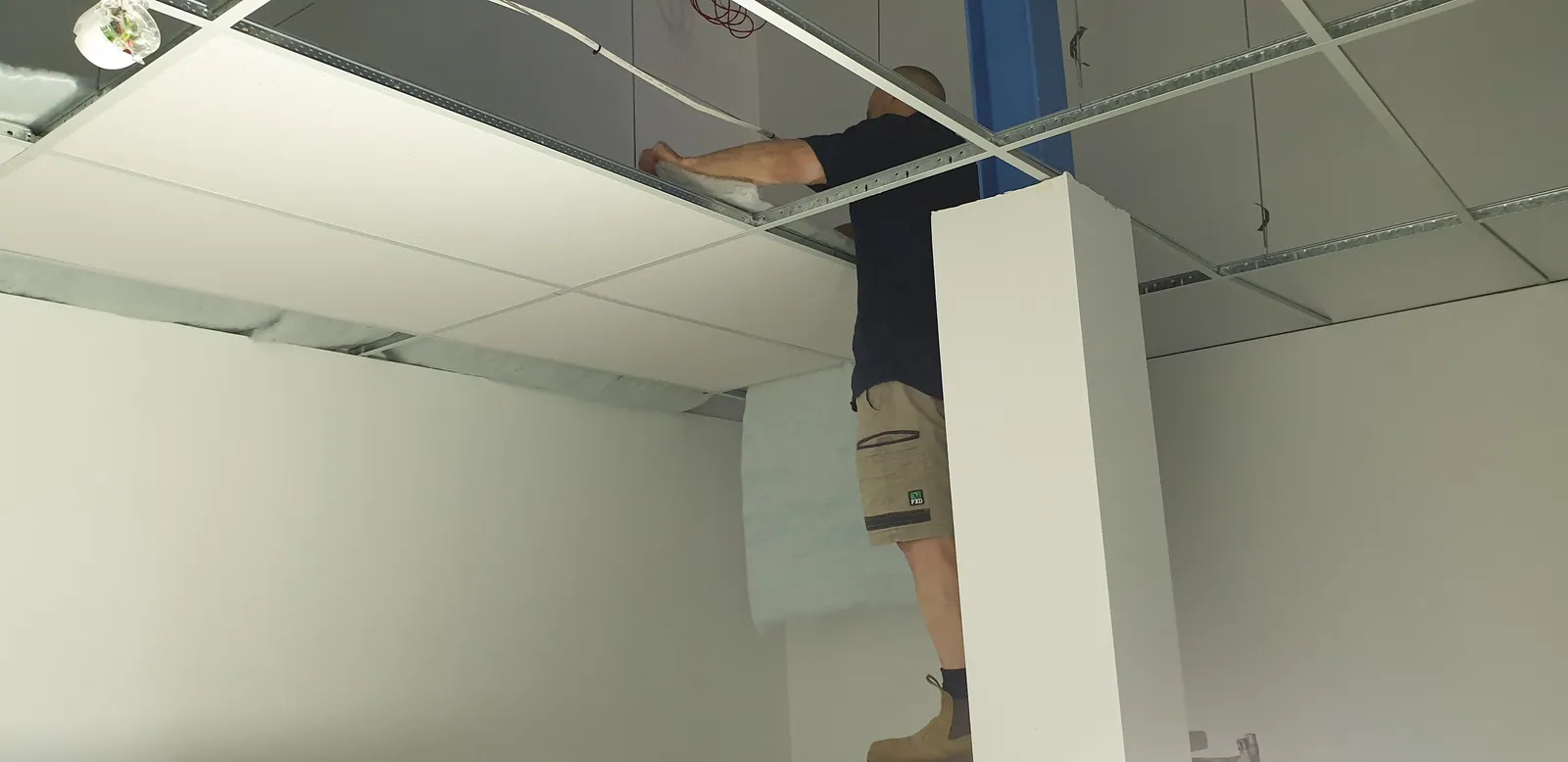

Ceiling panels being installed above the retail area.
09228 Nov 2019

Ceiling panels being installed above the retail area.

The ceiling-panel installation progressing towards the shopfront.
09328 Nov 2019

The ceiling-panel installation progressing towards the shopfront.

Ceiling panels being added above the workshop.
09428 Nov 2019

Ceiling panels being added above the workshop.

More of the workshop ceiling closed in.
09528 Nov 2019

More of the workshop ceiling closed in.

The remaining ceiling openings during installation.
09628 Nov 2019

The remaining ceiling openings during installation.

The workshop with its ceiling panels fitted.
09729 Nov 2019

The workshop with its ceiling panels fitted.

The new retail ceiling and lights in place.
09829 Nov 2019

The new retail ceiling and lights in place.

Looking towards the front beneath the finished retail ceiling.
09929 Nov 2019

Looking towards the front beneath the finished retail ceiling.

The workshop lit by its newly completed ceiling lights.
10029 Nov 2019

The workshop lit by its newly completed ceiling lights.

Floor underlay laid in a smaller rear room.
10129 Nov 2019

Floor underlay laid in a smaller rear room.

The smaller work area with screen mounts and the new ceiling.
10229 Nov 2019

The smaller work area with screen mounts and the new ceiling.

11Floors

Underlay extending along the internal passage.
10329 Nov 2019

Underlay extending along the internal passage.

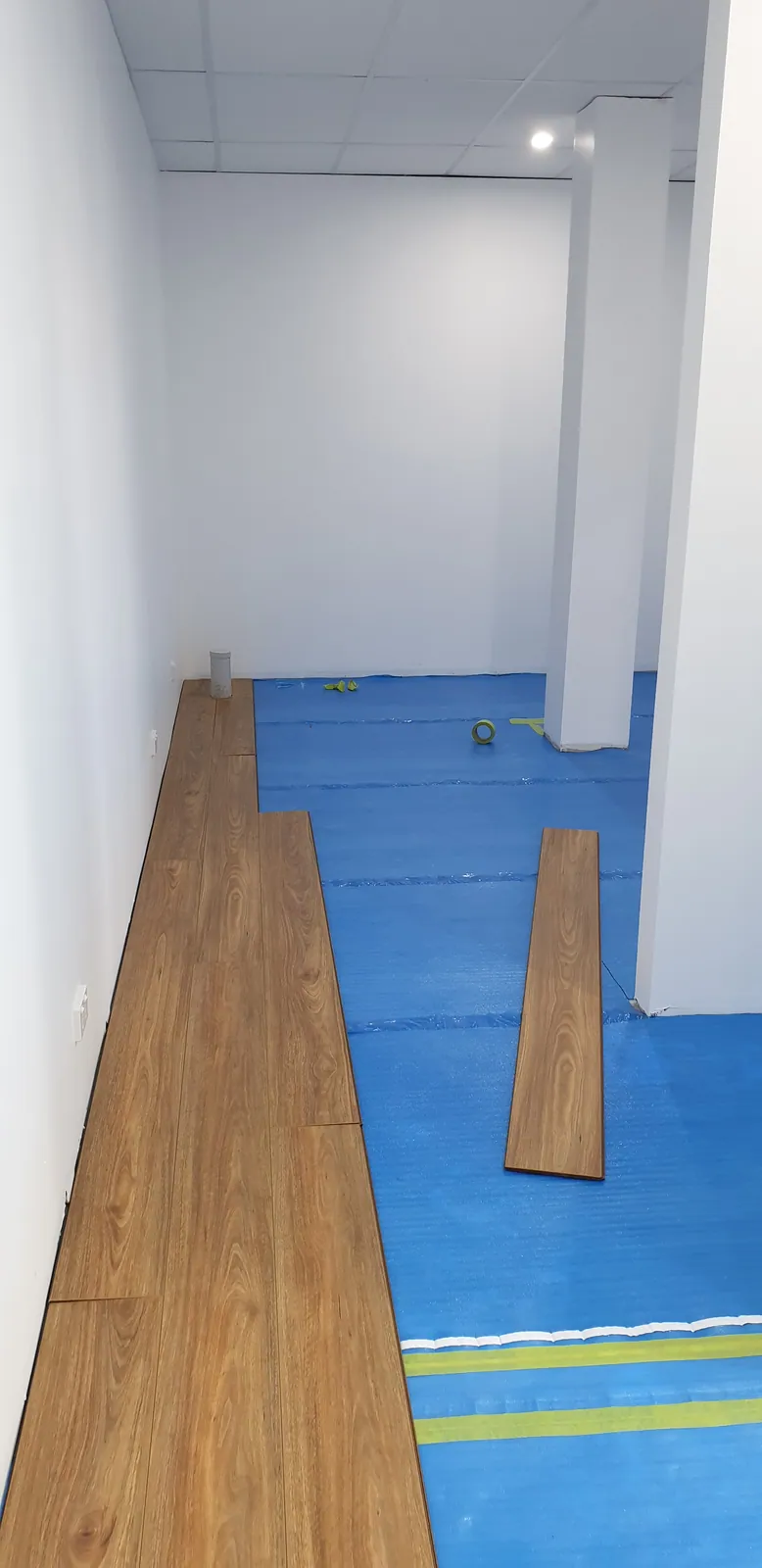

The first floorboards being laid through the passage.
10429 Nov 2019

The first floorboards being laid through the passage.

Flooring cut around a corner and the existing structure.
10529 Nov 2019

Flooring cut around a corner and the existing structure.

The passage with its new flooring laid.
10629 Nov 2019

The passage with its new flooring laid.

Flooring completed in the smaller room.
10729 Nov 2019

Flooring completed in the smaller room.

Laying the new floor across the retail area.
10830 Nov 2019

Laying the new floor across the retail area.

The workshop benches above the newly finished floor.
10930 Nov 2019

The workshop benches above the newly finished floor.

The retail floor progresses towards the front windows.
11030 Nov 2019

The retail floor progresses towards the front windows.

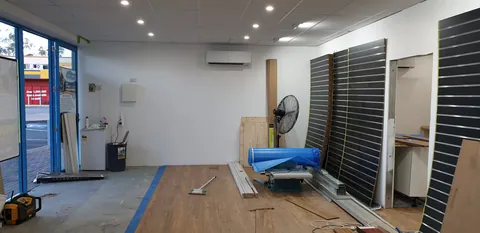

The flooring installation nearing the shopfront.
11130 Nov 2019

The flooring installation nearing the shopfront.

The new floor reaching the entrance.
11230 Nov 2019

The new floor reaching the entrance.

12Retail display walls

The first retail display-wall panels being fitted.
1131 Dec 2019

The first retail display-wall panels being fitted.

Display panels extending around the retail corner.
1141 Dec 2019

Display panels extending around the retail corner.

The new display wall and finished floor together.
1151 Dec 2019

The new display wall and finished floor together.

Display panels fitted beside the front windows.
1161 Dec 2019

Display panels fitted beside the front windows.

The rear retail wall prepared for product displays.
1171 Dec 2019

The rear retail wall prepared for product displays.

Measuring and fitting the next display-wall section.
1182 Dec 2019

Measuring and fitting the next display-wall section.

13Glass displays and service counters

Glass-display cabinet frames brought into the showroom.
1192 Dec 2019

Glass-display cabinet frames brought into the showroom.

The display-cabinet layout taking shape.
1202 Dec 2019

The display-cabinet layout taking shape.

Glass display cabinets partway through assembly.
1212 Dec 2019

Glass display cabinets partway through assembly.

The new display cabinets positioned around the showroom.
1222 Dec 2019

The new display cabinets positioned around the showroom.

The glass cabinets and retail wall panels coming together.
1232 Dec 2019

The glass cabinets and retail wall panels coming together.

Timber prepared along the developing service counter.
1243 Dec 2019

Timber prepared along the developing service counter.

The counter work viewed across the showroom.
1253 Dec 2019

The counter work viewed across the showroom.

The showroom as the counters and fittings progress.
1264 Dec 2019

The showroom as the counters and fittings progress.

Timber counter tops fitted above the cabinets.
1274 Dec 2019

Timber counter tops fitted above the cabinets.

The fitted display walls, counters and glass cabinets.
1284 Dec 2019

The fitted display walls, counters and glass cabinets.

14Doors and final retail fittings

A new internal workshop door hung during the fit-out.
1295 Dec 2019

A new internal workshop door hung during the fit-out.

The new workshop door viewed from the internal passage.
1305 Dec 2019

The new workshop door viewed from the internal passage.

The showroom with its new workshop door in place.
1315 Dec 2019

The showroom with its new workshop door in place.

Finishing the joins around the retail wall panels.
1326 Dec 2019

Finishing the joins around the retail wall panels.

Work continues on the workshop benches.
1336 Dec 2019

Work continues on the workshop benches.

The showroom counters and cabinets approaching completion.
1346 Dec 2019

The showroom counters and cabinets approaching completion.

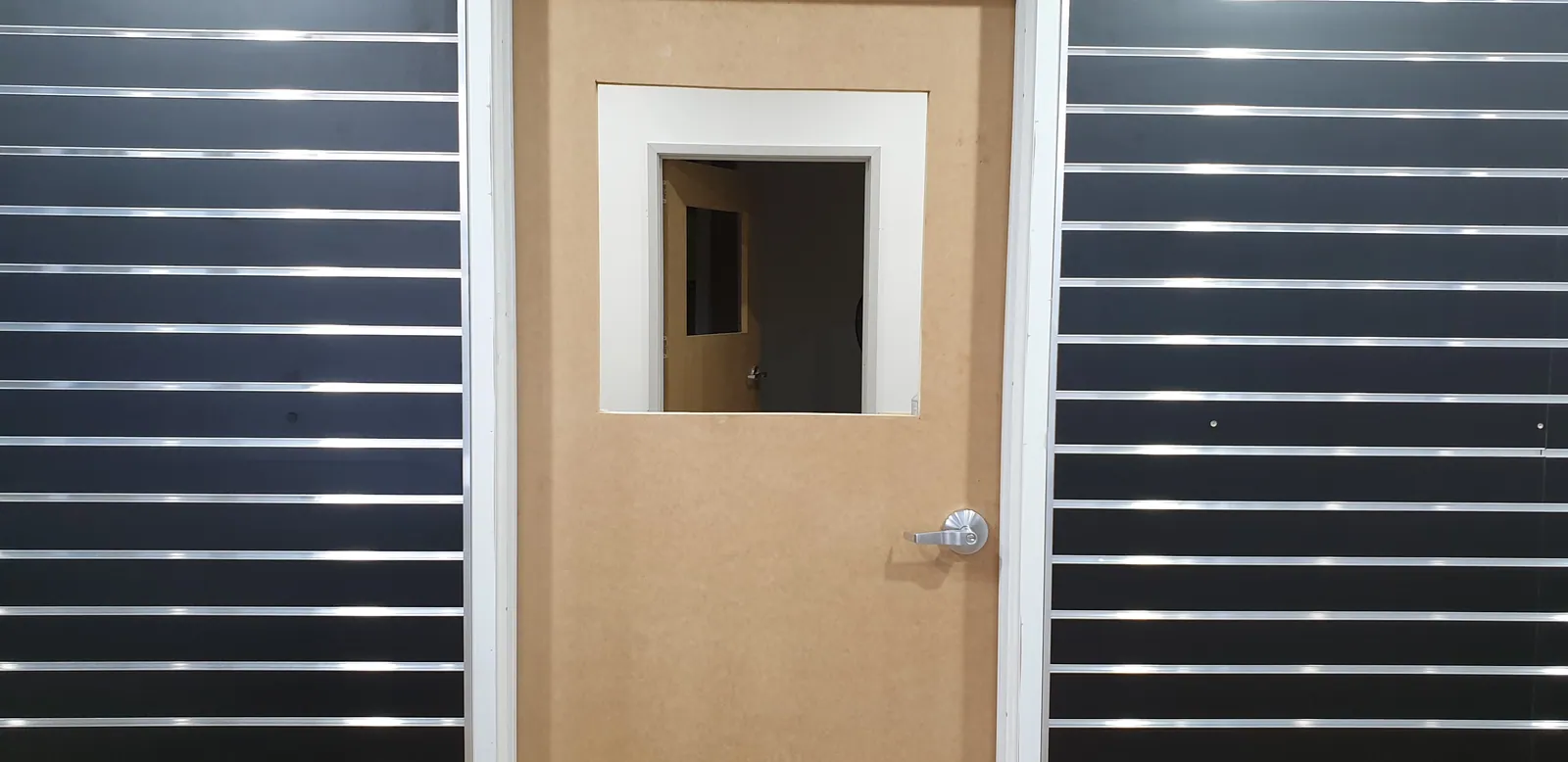

A glazed panel added to the workshop door.
1356 Dec 2019

A glazed panel added to the workshop door.

A closer view of the new door glazing.
1366 Dec 2019

A closer view of the new door glazing.

The fitted showroom before stock is put on display.
1377 Dec 2019

The fitted showroom before stock is put on display.

The completed display walls and counter layout from another angle.
1387 Dec 2019

The completed display walls and counter layout from another angle.

A screen added above the retail display area.
1398 Dec 2019

A screen added above the retail display area.

15Equipping the workshop

The workshop benches being equipped with screens and air lines.
14010 Dec 2019

The workshop benches being equipped with screens and air lines.

The opposing workbench as the repair stations take shape.
14110 Dec 2019

The opposing workbench as the repair stations take shape.

The finished retail counters before stocking.
14210 Dec 2019

The finished retail counters before stocking.

Workshop screens installed above the repair benches.
14311 Dec 2019

Workshop screens installed above the repair benches.

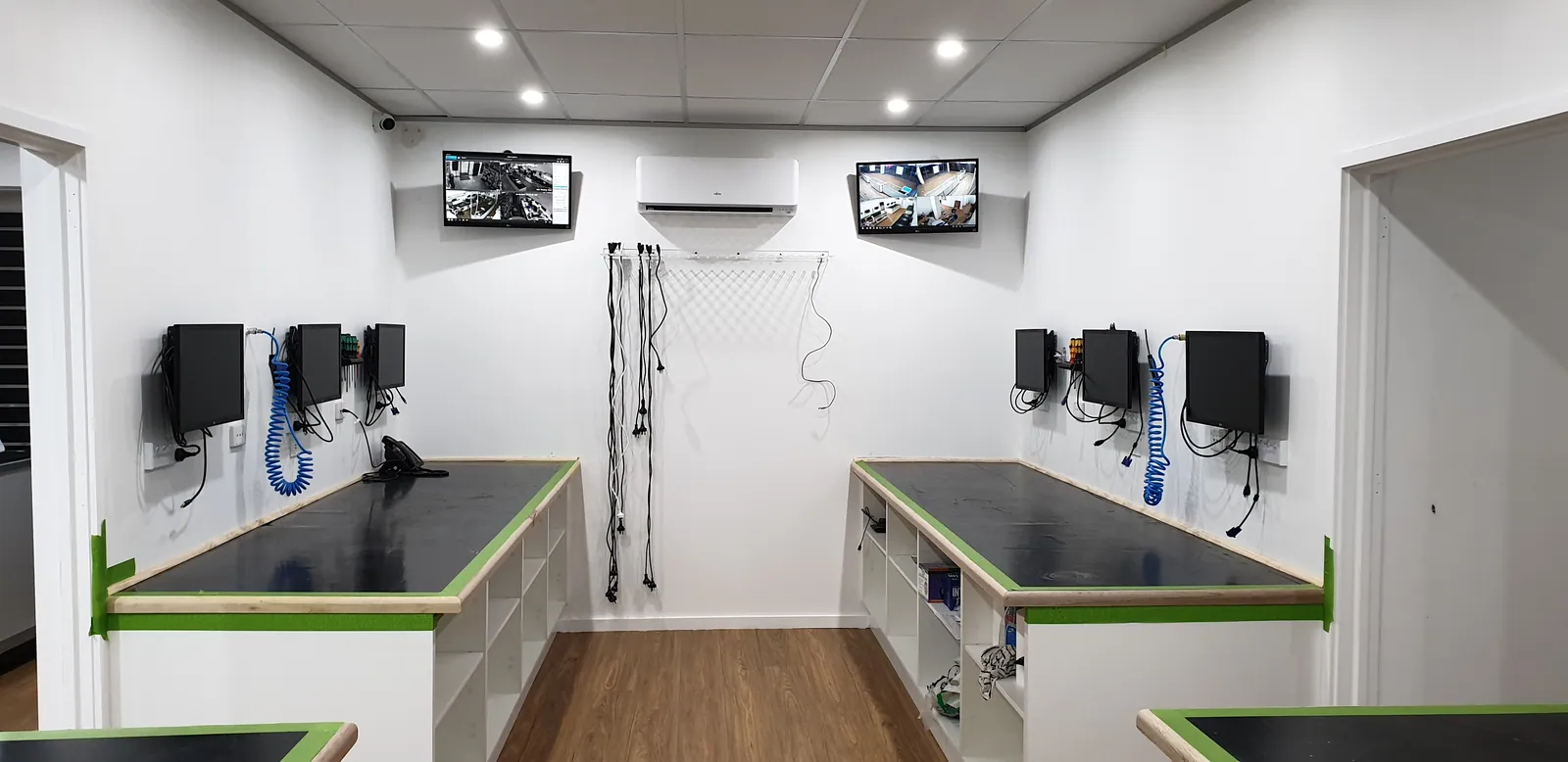

The workshop benches and compressed-air reels during final fit-out.
14414 Dec 2019

The workshop benches and compressed-air reels during final fit-out.

16Stocking the shop

Accessories arranged on the retail display wall.
14517 Dec 2019

Accessories arranged on the retail display wall.

The glass cabinets and wall displays filling with stock.
14617 Dec 2019

The glass cabinets and wall displays filling with stock.

The stocked shopfront illuminated at night.
14717 Dec 2019

The stocked shopfront illuminated at night.

The fitted showroom with its product range on display.
14818 Dec 2019

The fitted showroom with its product range on display.

The stocked retail space later in December.
14919 Dec 2019

The stocked retail space later in December.

17Final stations, storage and frontage

A smaller work area fitted with two screens and a stool.
15021 Dec 2019

A smaller work area fitted with two screens and a stool.

The smaller workstation with its keyboard and bench equipment.
15122 Dec 2019

The smaller workstation with its keyboard and bench equipment.

The expanded accessory display along the retail wall.
15223 Dec 2019

The expanded accessory display along the retail wall.

Additional shelving assembled for storage.
15323 Dec 2019

Additional shelving assembled for storage.

Now Open signs displayed across the illuminated shopfront.
15424 Dec 2019

Now Open signs displayed across the illuminated shopfront.

The new shop entrance with its Now Open signs.
15524 Dec 2019

The new shop entrance with its Now Open signs.

The stocked Tuggeranong shopfront at the end of December.
15631 Dec 2019

The stocked Tuggeranong shopfront at the end of December.

Brand signage being applied inside the front windows.
15731 Dec 2019

Brand signage being applied inside the front windows.

Fitting the tall brand graphic beside the front entrance.
15831 Dec 2019

Fitting the tall brand graphic beside the front entrance.

The front-window display and Crawfords branding.
15931 Dec 2019

The front-window display and Crawfords branding.

The fitted shopfront at the end of the documented build sequence.
16031 Dec 2019

The fitted shopfront at the end of the documented build sequence.

From an empty space to a place to work.

Back to this chapter →Back to the top ↑
CrawfordsComputer Services

Practical computer help.
A local shop. People you can talk to.

Visit our Greenway shop

Shop 39, 150 Soward Way
Greenway ACT 2900

Contact & directions ↗

Call or drop in

02 6112 8380

Monday–Saturday, 10am–3pm
Home and business visits by appointment

Full opening hours →
© 2026 Crawfords Computer ServicesVisitors to this page: 69
WebmailDownloads
Cart0
